|
|
AGENDA
Ordinary Council meeting Monday, 8 April 2024 |
|
I hereby give notice that an Ordinary meeting of Council will be held on: |
|
Date: |
Monday, 8 April 2024 |
Time: |
9.30am |
Location: |
Bay of Plenty Regional Council Chambers Regional House 1 Elizabeth Street Tauranga |
Please note that this meeting will be livestreamed and the recording will be publicly available on Tauranga City Council's website: www.tauranga.govt.nz. |
|
Marty Grenfell Chief Executive |
Membership
Commission Chair Anne Tolley |
|
Members |
Commissioner Shadrach Rolleston Commissioner Stephen Selwood Commissioner Bill Wasley |
Quorum |
Half of the members physically present, where the number of members (including vacancies) is even; and a majority of the members physically present, where the number of members (including vacancies) is odd. |
Meeting frequency |
As required |
· To ensure the effective and efficient governance of the City.
· To enable leadership of the City including advocacy and facilitation on behalf of the community.
Scope
· Oversee the work of all committees and subcommittees.
· Exercise all non-delegable and non-delegated functions and powers of the Council.
· The powers Council is legally prohibited from delegating include:
○ Power to make a rate.
○ Power to make a bylaw.
○ Power to borrow money, or purchase or dispose of assets, other than in accordance with the long-term plan.
○ Power to adopt a long-term plan, annual plan, or annual report
○ Power to appoint a chief executive.
○ Power to adopt policies required to be adopted and consulted on under the Local Government Act 2002 in association with the long-term plan or developed for the purpose of the local governance statement.
○ All final decisions required to be made by resolution of the territorial authority/Council pursuant to relevant legislation (for example: the approval of the City Plan or City Plan changes as per section 34A Resource Management Act 1991).
· Council has chosen not to delegate the following:
○ Power to compulsorily acquire land under the Public Works Act 1981.
· Make those decisions which are required by legislation to be made by resolution of the local authority.
· Authorise all expenditure not delegated to officers, Committees or other subordinate decision-making bodies of Council.
· Make appointments of members to the CCO Boards of Directors/Trustees and representatives of Council to external organisations.
· Consider any matters referred from any of the Standing or Special Committees, Joint Committees, Chief Executive or General Managers.
· Delegation of Council powers to Council’s committees and other subordinate decision-making bodies.
· Adoption of Standing Orders.
· Receipt of Joint Committee minutes.
· Approval of Special Orders.
· Employment of Chief Executive.
· Other Delegations of Council’s powers, duties and responsibilities.
Regulatory matters
Administration, monitoring and enforcement of all regulatory matters that have not otherwise been delegated or that are referred to Council for determination (by a committee, subordinate decision-making body, Chief Executive or relevant General Manager).
Ordinary Council meeting Agenda |
8 April 2024 |
5 Confidential business to be transferred into the open
6 Change to the order of business
7.1 Minutes of the Council meeting held on 18 March 2024
8 Declaration of conflicts of interest
9 Deputations, presentations, petitions
9.1 Petition - Jan Neale - Papamoa Beach Road Traffic
10 Recommendations from other committees
11.1 Council-controlled organisations' half yearly reports

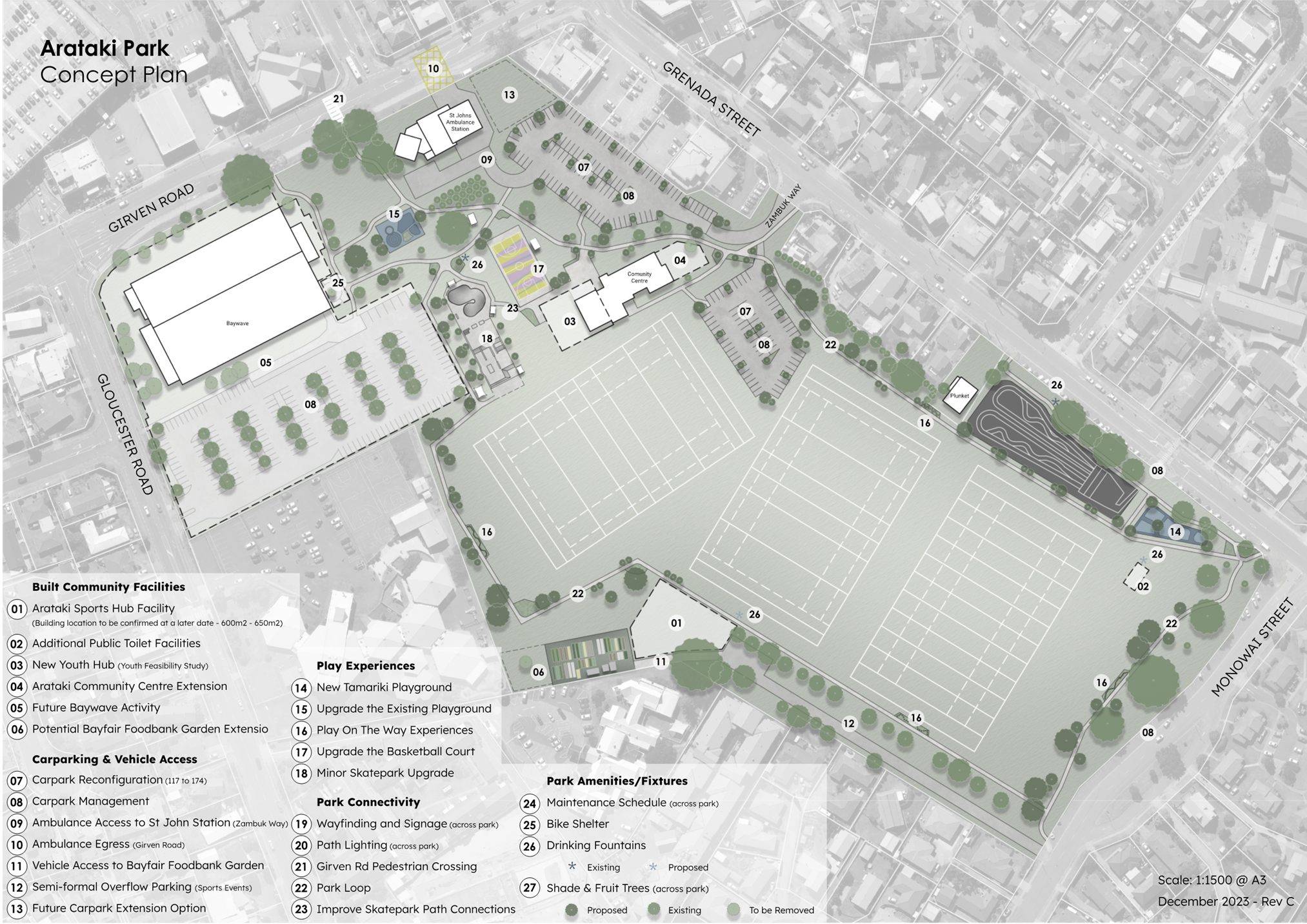

11.2 Adoption of Arataki Park Concept Plan
13.1 Public Excluded Minutes of the Council meeting held on 18 March 2024
13.2 Western Bay of Plenty Subregion City Deal
13.3 Exemption from open competition - Building Services
13.4 Divestment of Marine Precinct and Vessel Works
8 April 2024 |
7.1 Minutes of the Council meeting held on 18 March 2024
File Number: A15751985
Author: Anahera Dinsdale, Acting Team Leader: Governance Services
Authoriser: Anahera Dinsdale, Acting Team Leader: Governance Services
That the Minutes of the Council meeting held on 18 March 2024 be confirmed as a true and correct record.
|
1. Minutes of the Council meeting held on 18 March 2024
|
18 March 2024 |
|
MINUTES Ordinary Council meeting Monday, 18 March 2024 |
Order of Business
1 Opening karakia
2 Apologies
3 Public forum
3.1 Aaron Collier and Dwayne Roper, Zariba Holdings and Classic Group, Tauranga - Speaking to the City Centre Public Transport Facilities
3.2 Simon Clark - Colliers, Tauranga - Speaking to the City Centre Public Transport Facilities
4 Acceptance of late items
5 Confidential business to be transferred into the open
6 Change to the order of business
7 Confirmation of minutes
7.1 Minutes of the Council meeting held on 26 February 2024
8 Declaration of conflicts of interest
9 Deputations, presentations, petitions
Nil
10 Recommendations from other committees
10.1 Wastewater Management Review Committee
10.2 Strategy, Finance and Risk Committee recommendation 19 February 2024 - approval of unbudgeted loan funded operating expenditure for Kennan Road Business Case and Wairoa Bridge Cycleway contribution to safety works
11 Business
11.1 City Centre Public Transport Facilities
11.2 2024-2034 Long-term Plan - Other topics
11.3 Transportation Projects Waka Kotahi Funding Considerations
11.4 Transport Resolutions Report No.50
11.5 Revocation of Speed Limit Bylaw (2009)
11.6 Parking Management Plan Update
11.7 Waiari Kaitiaki Advisory Group Representatives
11.8 Update to 2024/25 Development Contribution Charges
11.9 Executive Report
12 Discussion of late items
13 Public excluded session
13.1 Public Excluded Minutes of the Council meeting held on 26 February 2024
13.2 Spaces and Places - Construction Project Partner Procurement Strategy
13.3 Direct appoint Rolco to a programme of concrete pavement works. 19
14 Closing karakia
MINUTES OF Tauranga City Council
Ordinary Council meeting
HELD AT THE Bay of Plenty Regional Council Chambers,
Regional House, 1 Elizabeth Street, Tauranga
ON Monday, 18 March 2024 AT 9.30am
PRESENT: Commission Chair Anne Tolley (Chairperson), Commissioner Shadrach Rolleston, Commissioner Stephen Selwood, Commissioner Bill Wasley
IN ATTENDANCE: Marty Grenfell (Chief Executive), Nic Johansson (Head of Transport), Christine Jones (General Manager: Strategy, Growth & Governance), Alastair McNeill (General Manager: Corporate Services), Sarah Omundsen (General Manager: Regulatory and Compliance), Gareth Wallis (General Manager: City Development & Partnerships), Alison Law (Acting General Manager: Community Services),Shawn Geard (City Centre Transport Advisor), Tom McEntyre (Principal Investment Advisor: Transport), Josh Logan (Team Leader: Corporate Planning), Kelvin Hill (Manager: Water Infrastructure Outcomes); Reece Wilkinson (Parking Strategy Manager), Ben Corbett (Team Leader: Growth Funding), Anahera Dinsdale (Acting Team Leader: Governance Services), Caroline Irvin (Governance Advisor), Aimee Aranas (Governance Advisor), Janie Storey (Governance Advisor)
Commissioner Shadrach Rolleston opened the meeting with a karakia.
2 Apologies
Nil
3.1 Aaron Collier and Dwayne Roper, Zariba Holdings and Classic Group, Tauranga - Speaking to the City Centre Public Transport Facilities |
External Aaron Collier, Classic Group Dwayne Roper, Zariba Holdings
Key points · Mr Collier noted that he had been involved with the CBD including what was going on in and around the city core and had been a planner in the review processes. · Zariba and the Classic Group jointly owned 134-142 Durham Street, for which both parties planned a redevelopment on the site, giving them a significant interest in the CBD. · They were long term developers with a strong interest in what was going on and were disappointed that they had heard about the bus stops third hand. Also disappointing was that as land owners they had not been consulted. · A key consideration of the proposed development was making sure that these had good active frontages and an interaction with public spaces. · They had first heard about the super stop third hand, and had then initiated consultation with Council staff, which was disappointing. A street meeting and subsequent engagement had been held with staff. · The group were opposed to a super stop as there were a number of social, economic, urban design and traffic issues that they considered had not been taken into account. · Information had been requested on the technical assessments being put forward to provide to their urban designers and transport teams to have a look, but they were still waiting for this. Despite those requests there had been very limited information provided. · As land owners they were not included in any initial consultation with groups and they felt that they should have been included. · Mr Collier suggested two solutions. One was to leave the bus stop where it was in option 2 of the report or consider option 1(a) but pepper pot the spots and make them smaller like those throughout the civic core. · This would still provide connectivity and linkages and reduce their concerns around social issues with a large super stop being located outside an active frontage such as that planned with their new building. · This would also provide the benefit of putting stops around the university or carparking buildings to provide links between east and west. There was not much of a link adjacent to the proposed site apart from a small alleyway and service lane to Grey Street. · The group were supportive of bus stops, but request that the super stop proposal be given more thought and planning. · It was suggested that a conceptual plan be run past the Council’s Urban Design Panel and landholders.
In response to questions · The group had owned one property for 15 years and the other for 5 years. · In response to a query as to whether the owners were aware of the road strengthening at a cost of $10.5M to take buses a few years ago, Mr Roper advised that they just thought it was part of the upgrade and only knew it was for bus stops at the recent on-street meeting. · In answer to a question as to their involvement with the length of time the works took and the cost, Mr Roper advised that there had been issues with the site over the 12 month work period, and did not have a sewage connection after the works were completed. However, they were unaware that a super bus stop was being planned in the street. · Commissioner Tolley advised that there would be a 90m bus stop on each side to allow for 3 buses which would also take away 18 carparks. Council would be concerned if the areas that had been strengthened were to be dug up again and queried whether the land owners would be willing to pay for the gardens to be dug up and re-laid as bus stops. Mr Roper advised it was staff, not them that had proposed option 1(a) to spread the stops along Durham Street and noted that they would be contributing to the Council in the form of development contributions. · Mr Collier noted that the $3.5M quoted in the report was a big cost to replace some gardens and concrete, with staff indicating that the costings were loose and high end estimates. More accurate costings needed to be obtained. · In response to a query as to whether there was a design solution possible to create something in keeping with the proposed development and a compromise solution that would work for both parties, Mr Collier said that he had seen little in terms of design and conceptual plans. He likened it to a developer applying for a consent where he would need to provide a lot of information to do anything, and asked why the Commissioners did not have the same amount of information when making a decision. They were always happy to work collaboratively with the Council, to ensure that there were no social impacts on the activities adjacent to it and the possible future hotel site. Engagement would be welcome, but rather than having everything in one area of 90 metres, having stops broken up in smaller stops would be their preference. · There was already one stop adjacent to the site and it was working well.
Discussion points raised · Commissioners noted that they too were disappointed that early informative discussions were not held with land owners |
3.2 Simon Clark - Colliers, Tauranga - Speaking to the City Centre Public Transport Facilities |
External Simon Clark, Colliers
Key points · Mr Clark noted that he had an interest in 153-159 Durham Street, which had a bus stop located across the road. · They were currently in the advanced stage of designing a 5 story office building with retail on the ground floor of their site and had done the Geotech investigations. They were in the costing and preliminary design stage at present. The ground floor would also include a central foyer and shared amenity spaces for the office tenants. · Mr Clark was disappointed that he had not been properly consulted, and Council seemed to be in a rush to get everything done and Mr Clark had not been given time to provide feedback. · The current plan for compressed stops gave no regard for the street scape. While he had no problem with bus stops on Durham Street, he did have a problem if the bus stops were to be compressed as his development needed to integrate its foyers, parking, entrances and retail frontage. Half of the ground floor would be offices or public amenity for the tenants, but putting three stops on each side would cause clashes with people entering the building as the planned bus stop would be at his front of door. Council had to look at an expanded area on Durham Street as Colliers were spending $25M on a building in that location. · This part of Durham Street was unique in the CBD, it had good geotech ground conditions and putting bus stops in front of some of the best and easily developed land did not make sense. There were geotech conditions in other areas that developers were unable to make viable, but this was a medium rise area that was prime location for picking up the older style buildings that were ready for redevelopment. · Council were putting stumbling blocks in front of the developers as there were not many areas that an office building could be built. In building they also wanted to get the integration correct with the streetscaping as that would also help to make it work. · Mr Clark asked that the Council looked at condensing the bus stops as his development would not be viable if tenants were concerned with safety and having people directly in front of the building. No matter what was said, there were still serious safety concerns. · No one had it right, and the best solutions was to broaden it over a wider area with more bus stops to dissipate the congregation. That was what he was looking for.
Discussion points raised · Commissioner Tolley noted that Wellington CBD managed similar stops in their city centre. · Understood that geotechnically this was a good area of the city to build in. · Commissioners struggle with the practicality of huge buses in a small CBD that were mostly empty and were struggling to find the room for what the Bay of Plenty Regional Council had indicated that they required. A temporary stop had been created in Durham Street North while staff were working through the issues to find somewhere more suitable for the buses to stop. · It was requested that staff work with the developers and to share design concepts so they could determine if there was a way the area could be shared and provide the design concepts to the Urban Design Team in an attempt to find a solution. · While there had been some very serious social issues with bus stops in the past, these had been in areas where the surrounding environment allowed people to congregate there. This was not the case in Durham Street, where instances were rare, with more everyday people using the seating now. The anti-social behaviour perception would change over time, especially as more people used public transport. · Commissioners thanked the developers for attending the meeting and noted that they shared their disappointment that they were not involved earlier in the process.
· There had been a lot of money spent by the ratepayers on Durham Street and Commissioners had been very clear with staff all the way through that Council would not dig up any roading and street scaping that had been put down in the last five years. |
Nil
5 Confidential business to be transferred into the open
Nil
6 Change to the order of business
Nil
Resolution CO5/24/1 Moved: Commissioner Bill Wasley Seconded: Commissioner Stephen Selwood That the minutes of the Council meeting held on 26 February 2024 be confirmed as a true and correct record. Carried |
8 Declaration of conflicts of interest
Nil
9 Deputations, presentations, petitions
10 Recommendations from other committees
Staff Christine Jones, General Manager: Strategy, Growth & Governance Coral Hair, Manager: Democracy & Governance Services
Discussion points raised · Commissioners acknowledged the work of the tangata whenua representatives and the assistance from Council staff with the Wastewater Management Review Committee Program Business Case. · There had been a pause at the end of 2023 to allow time for each of the parties to work through the issues. The Committee were now in agreement with the proposed wording in the Program Business Case. · There was still a lot of work to do within the space, and this would enable them to move forward. · The outcome would set a platform for business cases into the future on how to plan and provide for wastewater in the city as it sets objectives and clarity to the incoming Council in a way that affects mana whenua. |
Resolution CO5/24/2 Moved: Commissioner Bill Wasley Seconded: Commissioner Shadrach Rolleston That the Council: (a) Receives the report "Recommendation from Wastewater Management Review Committee 6 March 2024". (b) Accepts the recommendation of the Wastewater Management Review Committee of 6 March 2024 and (i) endorses the outputs of the Wastewater Programme Business Case as set out in Attachment 1. (ii) continues the Programme Business Case process; and; (iii) approves the subsequent stages of the Programme Business Case commences, starting with the long list option identification in March 2024, including engagement. Carried |
Staff Christine Jones, General Manager: Strategy, Growth & Governance
|
Resolution CO5/24/3 Moved: Commissioner Bill Wasley Seconded: Commissioner Stephen Selwood That the Council: (a) Receives the report "Strategy, Finance and Risk Committee recommendation 19 February 2024 - approval of unbudgeted loan funded operating expenditure for Kennan Road Business Case and Wairoa Bridge Cycleway contribution to safety works". (b) Accepts the recommendation of the Strategy, Finance and Risk Committee recommendation SFR1/24/7 of 19 February 2024 and approves unbudgeted loan-funded operating expenditure and associated rates-funded debt retirement over a five year period for (i) $379k for Keenan Road Business case (ii) Wairoa Bridge Cycleway contribution to safety works $1.1m. Carried |
Staff Nic Johansson, Head of Transport Shawn Geard, City Centre Transport Advisor Tom McEntyre, Infrastructure Funding Specialist
Presentation attached
Key points · Maps with bus stops exclusive and inclusive of Durham Street were shown. · The report included feedback from the land owners following a recent meeting with them. · Staff were going through the business case process with NZTA and the Council project process as it related to the city centre public transport infrastructure to find a working compromise with the Bay of Plenty Regional Council which also encourages and promotes the essential developments and investments in the CBD. · All options required compromise and with new information to hand from the developers, the recommendation was to adapt in order that the best compromise decision could be found for the greatest good and the longest term for the betterment of the city as a whole. · The current interim stop at Durham Street North did not allow for public transport growth and was not considered a suitable location. · Durham Street South had significant development opportunities as noted by the submitters in the public forum. Their alternative option had potential to minimise the impact on vital city centre development and would be given further consideration and investigation.
In response to questions · In response to a comment that the process of developing a business case with NZTA was happening in isolation from land owners and users on the street or whether it was a Council process, it was noted that the NZTA business case methodology lent itself to finding technical solutions early in the process. It was described as three lenses where a technical solution may be good for an engineering, planning or data modelling perspective, but have completely different outcomes for the community or may not be feasible at a political level with NZTA or the Minister depending on the size and scale. There were times that there was an awkward juggling act to find the ultimate compromise for the three parties and the greater good for longer term. · In relation to the suitability of having stops at Durham Street North and spreading the stops to the north and the south of the street, it was noted that it was too far from a bus interchange perspective due to the intersections and had less shelter from bad weather. · In response to a comment that if the stop was near the Spring Street corner it would just be a matter of crossing the road to change buses, it was noted that commuters would have a veranda the entire length and then the perceived separation of having to cross the road for that one stop not three. · In relation to a query as to what was occurring in Dive Crescent being what was needed now or when the new super service comes through when Stage 1 was at least two years away and may not be used for the next 5-6 years, it was noted that yes it would still make public transport more attractive now. If this information had been available when doing the Durham Street upgrade they may have landed on something more along the proposed lines. Staff wanted to be able to provide certainty to everyone and have locations agreed to and to develop around rather than having additional developments, builds and streetscape occurring than in three years’ time, trying to shoehorn them into a location as that would not work. · In relation to a question as to whether there would only be one stop of either side of Dive Crescent, it was noted that a time frame was left off the recommendation for that area based on the proviso that nothing more would not be done until there was an established need.
· Commissioner Tolley noted that the Bay of Plenty Regional Council technical staff should be included in discussions as they were the ones pushing these stops and were a partner with Council having to fund infrastructure. There had been a lot of discussions at the Tauranga Public Transport Joint Committee about the effect on the city and had been told that Council were not going to design the city around bus stops. · In relation to a query as to whether there had been any conversations with the university and owners of 116 and 122 Durham Street about the impact on them, it was noted that this was raised in the recent land holder engagement session, but they had not had the opportunity to discuss it with them as yet. · This was also why the cost element was loose at present with sufficient funding being provided for architectural elements in Durham Street would cost in the vicinity of $10M. If Council were to go for this option, the next step would be the wider stakeholder engagement. The stops had been moved as far away from the University and Mercury Energy’s open frontages as possible. · The entire length of road had been reinforced and in the southern area the current bays were reinforced. In the more spread out system, it would mean installing concrete bays where the planting and stormwater treatment were located. The Durham Street North pavement was failing and had sunk significantly and if that was to be used for much longer as an interim location it would need a new city centre type shelter installed as the current one was in need of an upgrade. · Commissioners noted it was important to understand the volume of people using the area as a bus transfer and if it was a small number of transfers the need for that may have been overstated. There was also a need to understand how far was reasonable for someone to walk from one stop to another, especially for those people disadvantaged in their travelling ability. It was noted that currently the bus service was used by people travelling into the city centre and now there was a desire to allow people to travel more widely across the city in future on a public transport network, the demand for which was desired to increase over time. There was no data as to how much this happened at present. · In response to a question as to what was needed now and whether Durham Street North could be designated for future development if and when a through system and interchange developed, it was noted that an alternative in a Durham Street location was needed to get buses off Grey Street. · The next element at the very least if Durham Street North was kept in operation, would be a significant upgrade and work through with the Bay of Plenty Regional Council on that future. Durham Street South would need the current two stops, split into two individual stops and 1-2 stops on the south side that did not currently exist. · If Council dealt with the stops around Willow, Harrington and Hamilton Streets and Dive Crescent and deferred consideration of the Durham and Elizabeth Streets stops, pending engagement with the property owners around the location and the design being practical to give some certainty to the stops and what was occurring in the northern part of the city centre. It was noted that this was possible and a practical and pragmatic solution to give certainty to move to those areas into the future and allowed staff to consider the most optimal solutions for the whole of Durham Street and recognise the development opportunities. · It was noted that NZTA/Waka Kotahi had been involved with each step throughout the last two years and they would now include Bay of Plenty Regional Council who had provided good input into the recent landowners meeting. · Included was to be an interregional stop on Spring Street or Elizabeth Street depending on the location of city bus stops.
Discussion points raised · Changes to recommendations in the report were made to take into account the comments made. |
Resolution CO5/24/4 Moved: Commissioner Bill Wasley Seconded: Commissioner Shadrach Rolleston That the Council: (a) Receives the report "City Centre Public Transport Facilities". (b) Adopts the city centre bus facility locations, (i) Civic Centre split stops – a set of four stops consisting of one stop in each of these locations: (1) West side of Willow Street, north of Harrington Street (2) North side of Harrington Street, west of The Strand (3) South side of Hamilton Street, west of The Strand (4) South side of Hamilton Street, west of Willow Street. (c) Dive Crescent one stop each way, signalling that was designated as the future super stop when needed. Carried |
Resolution CO5/24/5 Moved: Commissioner Bill Wasley Seconded: Commissioner Stephen Selwood That the Council: (d) engages with property owners/developers and tenants regarding the design, location and cost of bus stops on Durham Street, Elizabeth Street and Spring Street and report back within six weeks. This is to include: Article I. potential distributed placement (pepper potting) along Durham Street,Article II. the implications of retaining the existing Durham Street North bus stops,Article III. what is required now, for the next 5 years, and then beyond that.Carried |
Attachments 1 Tabled - Durham St and City Centre bus facilities |
Staff Christine Jones, General Manager: Strategy, Growth & Governance Gareth Wallis, General Manager, City Development & Partnerships Josh Logan, Team Leader: Corporate Planning
Key points · The report brings together items that were brought up in the submissions that were not consultation questions and provides the Council’s answer to those. · As the submissions had been made in November, staff were looking to have the responses ready to be sent out as soon as the LTP 2024-34 was adopted in April 2024.
In response to questions · In response to a query regarding the depreciation of BayPark stadium not being included until it was understood what the liability was for, it was noted that the renewals funding for the next 10 years was only for the main stand and not the north stand offices or the facilities that support the wider operation of the site or the speedway part section. Staff were quite conservative on how the facility was rated until a decision was made on the future of the stadium. It was requested that this be made very clear in the LTP submission responses. |
Resolution CO5/24/6 Moved: Commissioner Stephen Selwood Seconded: Commissioner Bill Wasley That the Council: (a) Receives the report "2024-2034 Long-term Plan - Other topics". (b) Approves staff comments on submissions relating to other topics in Attachment 1. (c) Authorises the Chief Executive and General Managers to make amendments to Council’s proposed response comments to each submission point in Attachment 1, to refine wording and style prior to responses being sent to submitters no later than one month after the adoption of the LTP. Carried |
11.3 Transportation Projects Waka Kotahi Funding Considerations |
Staff Nic Johansson, Head of Transport Kelvin Hill, Manager: Water Infrastructure Outcomes Tom McEntyre, Infrastructure Funding Specialist
Tabled information
Key points · The report was to consider the risk appetite for Council to maintain momentum on projects that were underway while waiting for the National LTP to be decided on later this year by NZTA/Waka Kotahi in light of the government policy statement shifts. · Two schedules were tabled, one of which was colour coded with the green projects committed to taking a risk from a funding perspective already, the orange were projects proposing to maintain momentum on and the pink being the ones that were too high a risk for funding after the business cases had been developed. · The second schedule noted where the money would come from to fund the risk component of those projects that would move forward. While there was a mix, they would either be pushed out or a revisit of the contingencies to find enough funding to maintain the momentum.
In response to questions · In response to a query as to the difference between the city centre transport hub and city centre transport development, it was noted that the transport hub was considered in item 11.1 and the others were transport works outside of the public transport elements. The figures noted were what was currently in the LTP which looked after all of the divestment of Dive Crescent and the like and staff were looking at how this could be streamlined. · The proposed to progress column was the risk component and the dollar value to maintain the momentum on until the business case was approved or otherwise. · It was noted that with the Arataki project that Council would spend the $4.6M Council budget which was the agreed sum. The projects were communicated with the transport agency staff in the TMOLTP and those amounts were unable to be changed. · It was noted that Arataki projects was still live as a co-funding line between Council and NZTA and would be taken out as there was no obstacle to removing Council’s share of the funding. However, the $4.5M in the solution was not viable to be sufficient on Farm Street due to the undergrounding of services that had now arisen. There were alternative sources of funding being investigated to get a viable solution. · Commissioner Tolley noted that a decision had been made that $4.6M was available to spend to get better facilities, and whatever that would cover as that was all that would be spent with a requirement to come back to the Commissioners if more was required. It was noted that the project could get to a point if the underground work was essential to seek other ways of getting the balance of the works and street scaping underway. · In answer to a query about the use of the IFF funding for the 14 projects going through the NZTA processes, it was noted that the IFF funding would be able to be used regardless of whether the NZTA funding was approved. · The earliest NZTA would confirm funding was 31 August 2024 due to the delayed release of the Government Policy Statement (GPS) document. This would provide certainty of the 3 year trunch of the National Land Transport Plan funding. Staff had been working off an interim GPS since the central government elections in 2023 resulting in an extended period of ambiguity and uncertainty of committed funding. NZTA had confirmed subsidy of 51%, but the ranking order would not be known until the decision was released. Staff were confident the top 5 on the list would be funded as they had a high degree of alignment with the draft policy. There was an obligation to make it clear that the extended time lines had a high degree of alignment and risk with the costs and continuation between now and 31 August 2024. · In relation to the safe network funding which may not be approved, it was noted that NZTA had different outcomes with the new GPS with a reset of physical interventions rather than policing. The risk also depended on where the projects were in the phases and if physical construction was commenced, the project would have to be taken to completion but if it was still at the design or business case stage it could be dropped at any time. · There was still $250M government funding allocated to walking and cycling and Council were competing for some of that. At present projects within Area B were at the top of the list and submitted to NZTA and if successful walking and cycling in active mode shift would be progressed over the next three years. · In relation to a comment from NZTA that Council were not ruthless enough in going after the government money, it was noted that this had changed in the past triennium with the introduction of the IFF, IAF and HIF. There were good threads of information in the GPS which were included in the Council submission to the statement indicating that the Minister proposes to expedite the business case process as it was expensive to provide. It was the opportunity and time costs that Council suffer from and losing the element of urgency to make the most of opportunities put in front of Councils. Council processes had changed to get a better draw down of funding to the greatest extent that they could. The Minster did note on his recent visit that he understood the timeline of the GPS release that some Councils would incur burden on and they wanted to expediate the process as a whole from three years to ten to give certainty to the market and to local government. · Commissioners and the incoming Council would be updated as information come to hand on the level of risk up until the announcement of the National Land Transport Plan.
Discussion points raised · Commissioner Tolley noted that the park and ride trial from Tara Road was frustrating and the only reason Council were going through a business case was because the Bay of Plenty Regional Council could not prioritise funding and the proposal needed NZTA funding. |
Resolution CO5/24/7 Moved: Commissioner Bill Wasley Seconded: Commissioner Stephen Selwood That the Council: (a) Receives the report "Transportation Projects Waka Kotahi Funding Considerations". (b) That approval of up to $4M of local shared funding can be budgeted to progress the four identified priority projects, providing this amount is offset elsewhere within the capital program. (c) That delegation be given to General Manger Infrastructure to manage this capital budget process. Carried |
Attachments 1 Tabled - Transportation Projects WK Funding Consideration - pdf |
Staff Nic Johansson, Head of Transport
|
Resolution CO5/24/8 Moved: Commissioner Shadrach Rolleston Seconded: Commissioner Bill Wasley That the Council: (a) Receives the report "Transport Resolutions Report No.50". (b) Resolves to adopt the proposed traffic and parking controls as per Appendix A relating to minor changes for general safety, operational or amenity purposes, to become effective on or after 19 March 2024 subject to appropriate signs and road markings being installed. Carried |
Staff Nic Johansson, Head of Transport
|
Resolution CO5/24/9 Moved: Commissioner Bill Wasley Seconded: Commissioner Shadrach Rolleston That the Council: (a) Receives the report "Revocation of Speed Limit Bylaw (2009)". (b) Resolves to approve revocation of the Speed Limit Bylaw (2009). Carried |
Staff Nic Johansson, Head of Transport Reece Wilkinson, Parking Strategy Manager
In response to questions · In response to parking in the Mt Maunganui CBD, the LTP feedback requested the current timed parking limits be enforced and managed rather than meters being installed. · The Regulatory team had earmarked some areas for new signs which would be installed prior to the compliance with the time limits. · It was noted that by the end of 2024, there would be a further 360 carparks in the Tauranga city centre and the availability of these would be included on the screens noting the vacant parking spaces.
· The aggregate resource cost of $18M was a mix of maintenance cost of $345 per annum per household for parking at Mount Maunganui and the opportunity cost of not being able to use that land for anything else. It was less in the Tauranga city centre as due to paid parking. . It was requested that the maintenance cost be added into the plan to reinforce that there was no such thing as free parking. · Enforcement was not included in the maintenance costs and should also be recognised. It was hoped that NZTA would reconsider the amount Councils were able to charge as enforcement fines as there were some people who preferred to pay through fines, which in some cities was cheaper than parking costs. · Commissioners noted that with the extension of the city centre parking, Council needed to think about where workers on average to mid-range salaries that work in the central city were able to park so that they were not charged out of the ability to come to work. There was an expected increase of office workers which would also increase pressure of parking spaces on the city fringe.
Discussion points raised · Commissioners acknowledged the sensible and pragmatic report and noted their appreciation for the work done by staff. |
Resolution CO5/24/10 Moved: Commissioner Bill Wasley Seconded: Commissioner Stephen Selwood That the Council: (a) Receives the report "Parking Management Plan Update". (b) Defers the implementation of the following parking projects until March 2025: (i) Extension of paid parking area in the City Centre (ii) Mount Maunganui Parking Management Plan (iii) Or until requirements for an earlier review are met. (c) Notes that staff will report back to Council in March 2025 with updates on the current environment and recommendations on implementation of the Parking Strategy. Carried |
Staff Christine Jones, General Manager: Strategy, Growth & Governance Anahera Dinsdale, Acting Team Leader: Governance Services
|
Resolution CO5/24/11 Moved: Commissioner Shadrach Rolleston Seconded: Commissioner Stephen Selwood That the Council: (a) Receives the report "Waiāri Kaitiaki Advisory Group Representatives". (b) Endorses and appoints Raponi Wilson as the Tapuika iwi Authority representative and Luke Whare as the Te Kapu o Waitaha representative on the Waiāri Kaitiaki Advisory Group. Carried |
Staff Christine Jones, General Manager: Strategy, Growth & Governance Ben Corbett, Team Leader: Growth Funding
Key points · Following the LTP deliberations, the changes in the report reflect some of the decisions made primarily around the changes in the Te Papa catchment.
Discussion points raised · Commissioners noted that the Council had to constantly watch the costs as it was easy to pass those on. · It was a continual challenge to get the costs right at the beginning of process, and the more that goes in at front end process, the better. |
Resolution CO5/24/12 Moved: Commissioner Shadrach Rolleston Seconded: Commissioner Stephen Selwood That the Council: (a) Receives the report "Update to 2024/25 Development Contribution Charges". (b) Notes that the final development contributions charges are based on the decisions made through the Long-Term Plan 2024-34 and Development Contributions Policy 2024/25 deliberations process. Carried |
Staff Marty Grenfell, Chief Executive Nic Johansson, Head of Transport Alison Law, Acting General Manager: Community Services Christine Jones, General Manager: Strategy, Growth & Governance Alastair McNeil, General Manager: Corporate Services Sarah Omundsen, General Manager: Regulatory and Compliance Gareth Wallis, General Manager: City Development & Partnerships
Infrastructure Key points · The success of the water watchers programme was noted in the graphs as having a positive effect, even with the consistent supply of the past two summers. It was suggested that the information be provided to the Climate Change Control Group.
In response to questions · A smart water plan was the process where high water users worked with Council on how to reduce their volume. · In relation to a query, the exact cost ratio for the cost of concrete pavements which would last 40 years compared with asphalt that may need to be replaced three times in that period, it was noted that figure was not known. It did not mean that concrete was cheaper, but takes into consideration that over that time there would be less disruption with road closures and the like. · Laying bitumen over concrete was used in Links Ave as noise was an issue and a better ride quality was needed and provided the look and feel of the black tar seal and much less noise. · The sustainability and waste study for cruise boat waste was valuable as most cruise liners do not allow passengers to take any food or drink back on board and showed that there was a cost to Council to manage that rubbish. The data collated noted a considerable volume of waste and would be provided to Commissioners.
Discussion points raised · The use of abbreviations and names such as Smartwater was confusing and it was requested that an explanation be given in future reports when using these. · It was noted that the carbon reduction statistics made a worthy story with a certified and substantiated reduction in carbon emissions of 33% over a number of activities. · Commendation was passed on to staff for the initiatives.
Community Services In response to questions · An Intern had been working over the summer to establish a basis for tree canopy cover throughout the city. Staff plan to increase the cover from 20% to 30%.
Discussion points raised · Acknowledgement of the purchase of the Waddle beach culture collection items as the culture of Mt Manganui was often overlooked. · Information was requested on what was key to the city being recognised as a tree city. · Acknowledgement was passed on to the Events team who had been very helpful and supportive leading up to and throughout the recent beach volleyball and surf lifesaving tournaments. Using the local kapa haka teams, especially for the international groups to promote the city and showcases the local culture and identity. · Acknowledgement of the library staff for the amount of learning opportunities for children over the summer holiday period so they could keep up with their reading.
Chief Financial Officer Discussion points raised · It was requested that data be collated on whether other regional airports were at similar close to full capacity to Tauranga as Commissioners noted that it was disturbing to see the loading of flights at 90% . There were a lot of complaints about the ability to get a seat on a flight that suited users. · It was suggested that a representative from Air NZ be invited to attend a future meeting to provide their data.
Strategy, Growth & Governance Key points · The number of registered voters had increased so the election focus would be on letting people know that the election was on and encouraging them to vote. There would be voting bins placed in the local supermarkets. · Te Rangapū Mana Whenua o Tauranga Moana had confirmed its priorities for the year.
Discussion points raised · Comment was made on the recent announcement by NZ Post to deliver mail by courier and how this would affect the use of postal voting for future local body elections. Representation would be made to the Minister of Local Government prior to the 2025 elections to change the way elections were run.
Corporate Services Key points · During the Commissioners term, there had been a 5% reduction of turnover of staff. The stability of Council gave a chance to improve community experiences and staff moral. · Engagement survey participation for March 2024 were expected to be high, outlining what staff needed to be effective. · Staff were more innovative with three dimensional views of the city and what could be beside you when in buildings.
Discussion points raised · The staff turnover results demonstrated what good governance looked like with stable consistent decision making and was reflected in what had been delivered and showing in staff turnover, moral and media impact scores. · There had been a number of positive comments received on good governance for the organisation and the city. · The smiley face which had been created by Julian at a Mt Maunganui roundabout could be seen from Mauao and had resulted in many positive comments.
Regulatory & Compliance Key points · The impact of dealing with the backlog of consents was showing and staff were focusing on clearing these. · Consents received in the past three months had a 96% rate of timeliness. · The graph of new dwellings demand forecast against those consented was noted. With the lag of building consents a further drop of actual new builds on the ground would be seen. · The requests for service were mostly complaints in relation to car park in wrong place, there had been a rise in those and freedom camping despite the infringement fines doubling.
Discussion points raised · Concern was raised at the new dwelling builds falling even further behind resulting in a shortfall of around 5,500 houses and it was suggested that this be brought to the notice of the Minister. This also had the implication of higher priced housing and would take central government, local government and private sector working together to increase the stock. · Congratulations to the Animal Control team for the increased amount of dog registrations and working hard to ensure they were registered. · It was noted how well the liquor licencing had been managed at two recent major events given the size of them. · It was good to see the Engineering Concept Consultation and engaging with developers at an early stage in their process. · The retirement village Waitaha development proposal would hopefully be worked through as it was a treaty settlement.
City Development & Partnerships Key points · There was a wide variety of construction updates, including the completion of the rap piling at the Library and Community Hub and the commencement of the test piling on the Civic Whare, Exhibition and Museum site. · The Childrens Day held on 8 March 2024 at the Te Manawataki o Te Papa site was supported by the city centre team and well attended with a number of families engaged in the process. · The City Safety engagement role had the city centre businesses reaching out and positively impacting on the street safety. It was also attracting attention around the country.
In response to questions · It was noted that the cost estimate for the waterfront playground was due to be received and once it had been accepted the plans would be released.
Discussion points raised · It was suggested that the Police Minister be made aware of the City Safe engagement role and how it worked well in association with the local police. · It was requested that the green shoots of the city centre development be included the signage of what was occurring around the city to give people a sense for what was coming. |
Resolution CO5/24/13 Moved: Commissioner Shadrach Rolleston Seconded: Commissioner Bill Wasley That the Council: (a) Receives the report "Executive Report". Carried |
Nil
At 11.45 am the meeting adjourned.
At 11.54am the meeting reconvened.
Resolution to exclude the public
Resolution CO5/24/14 Moved: Commissioner Bill Wasley Seconded: Commissioner Stephen Selwood That the public be excluded from the following parts of the proceedings of this meeting. The general subject matter of each matter to be considered while the public is excluded, the reason for passing this resolution in relation to each matter, and the specific grounds under section 48 of the Local Government Official Information and Meetings Act 1987 for the passing of this resolution are as follows:
Carried |
Commissioner Shadrach Rolleston closed the meeting with a karakia.
The meeting closed at 12.08 pm.
The minutes of this meeting were confirmed as a true and correct record at the Ordinary Council meeting held on 8 April 2024.
........................................................
Commission Chair Anne Tolley
CHAIRPERSON
8 April 2024 |
9 Deputations, presentations, petitions
9.1 Petition - Jan Neale - Papamoa Beach Road Traffic
1. Petition
- Papamoa Beach Road Traffic Petition 20 March 2024 - Redacted -
A15752245 ⇩
8 April 2024 |

11.1 Council-controlled organisations' half yearly reports
File Number: A15513670
Author: Sanjana France, CCO Specialist
Authoriser: Gareth Wallis, General Manager: City Development & Partnerships
Purpose of the Report
1. To present the half yearly reports to 31 December 2023 for Tauranga City Council’s seven council-controlled organisations.
That the Council: (a) Receives the report "Council-controlled organisations' half yearly reports". (b) Receives Bay Venues Limited’s report on its performance for the six months to 31 December 2023. (c) Receives Tauranga Art Gallery Trust’s report on its performance for the six months to 31 December 2023. (d) Receives Tourism Bay of Plenty’s report on its performance for the six months to 31 December 2023. (e) Receives Te Manawataki o Te Papa Limited’s report on its performance for the six months to 31 December 2023. (f) Receives Te Manawataki o Te Papa Charitable Trust’s report on its performance for the six months to 31 December 2023. (g) Receives Bay of Plenty Local Authority Shared Services Limited’s report on its performance for the six months to 31 December 2023. (h) Receives the Local Government Funding Agency’s report on its performance for the six months to 31 December 2023.
|
Executive Summary

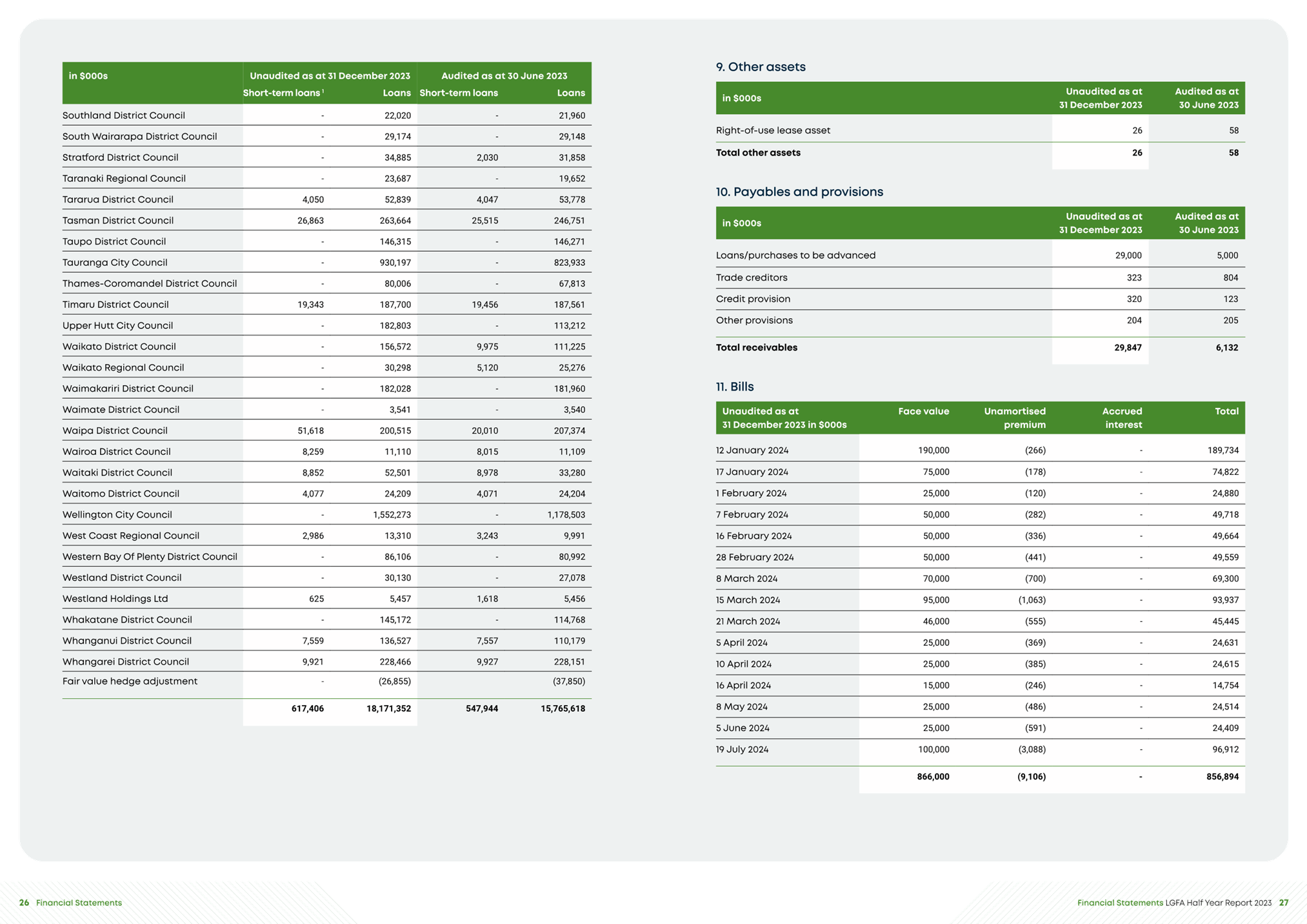

2. Bay Venues Limited (Bay Venues), Tauranga Art Gallery Trust (TAGT), Te Manawataki o Te Papa Limited (TMOTPL) and Te Manawataki o Te Papa Charitable Trust (Charitable Trust) are Tauranga City Council’s (TCC) council-controlled organisations. Tourism Bay of Plenty (TBOP) is a joint-shareholder council-controlled organisation between TCC and the Western Bay of Plenty District Council (WBOPDC).
3. Bay of Plenty Local Authority Shared Services Limited (BOPLASS) and the Local Government Funding Agency (LGFA) are also council-controlled organisations that provide opportunities for TCC and other local government agencies to become either members, shareholders or borrowers, seeking access to improved levels of services, reduced costs, joint procurement, and funding.
4. In accordance with the Statement of Intent and the Local Government Act 2002 (LGA), the seven council-controlled organisations are required to report six monthly and annually to Council on their financial and non-financial performance. The majority of the council-controlled organisations provided their reports to Council as required (by 29 February 2024), although one came in after the deadline.
5. Each council-controlled organisation’s report for the six months to 31 December 2023 is provided as Attachments 1 to 7, with a brief summary in the main body of this report. The reports summarise the financial performance for the period ended 31 December 2023, and performance against objectives/targets.
Background
Bay Venues Limited (Bay Venues)
6. Bay Venues’ report for the six months to 31 December 2023 was received by Council on 29 February 2024 and is included as Attachment 1.

7. Total visitation was up across Bay Venues’ venue network for the first half of the year compared to the same period last year. Their six-month financial result saw revenue of $13.2m and an EBITDA loss of -$1.28m – both were below/behind budget, however EBITDA is expected to be on budget at year end.
8. Mercury Baypark hosted several large and successful events in the six-month period, including The Classic basketball event by HoopNation over Labour Weekend, the New Zealand Festival of Squash over 12 action-packed days in December, and a sold-out live music event Famous Last Words on New Year’s Eve, which showcased an increase in venue capacity allowance in Mercury Baypark Arena’s Lion Foundation Centre.
9. A planned renewals and maintenance project at the Mount Hot Pools was completed on time ahead of the summer holidays. It included important preventive maintenance work being done on the plant room and pool heating system, re-tiling all the outdoor pools for the first time since 1991, and the pool structure and pool tanks underneath were repaired and re-waterproofed to ensure this facility continues to operate successfully and sustainably.
10. Bay Venues faced some challenges during the six-month period including:
(a) Challenging economic conditions and increased costs of living have continued to impact event ticket sales and their associated activities, including Bay Audio Visual and BayStation.
(b) Managing ongoing challenges such as increased anti-social behaviour in their venues.
(c) Keeping an ageing network of facilities functioning efficiently for our community.
11. Customer satisfaction in the six-month period was at 86% for overall satisfaction, which is 2% ahead of their Key Performance Indicator.
12. Bay Venues is looking forward to continuing to work closely with Council on several significant venue projects in the pipeline or already underway.

Tauranga Art Gallery Trust (TAGT)
13. TAGT’s report for the six months to 31 December 2023 was received by Council on 29 February 2024 and is included as Attachment 2.

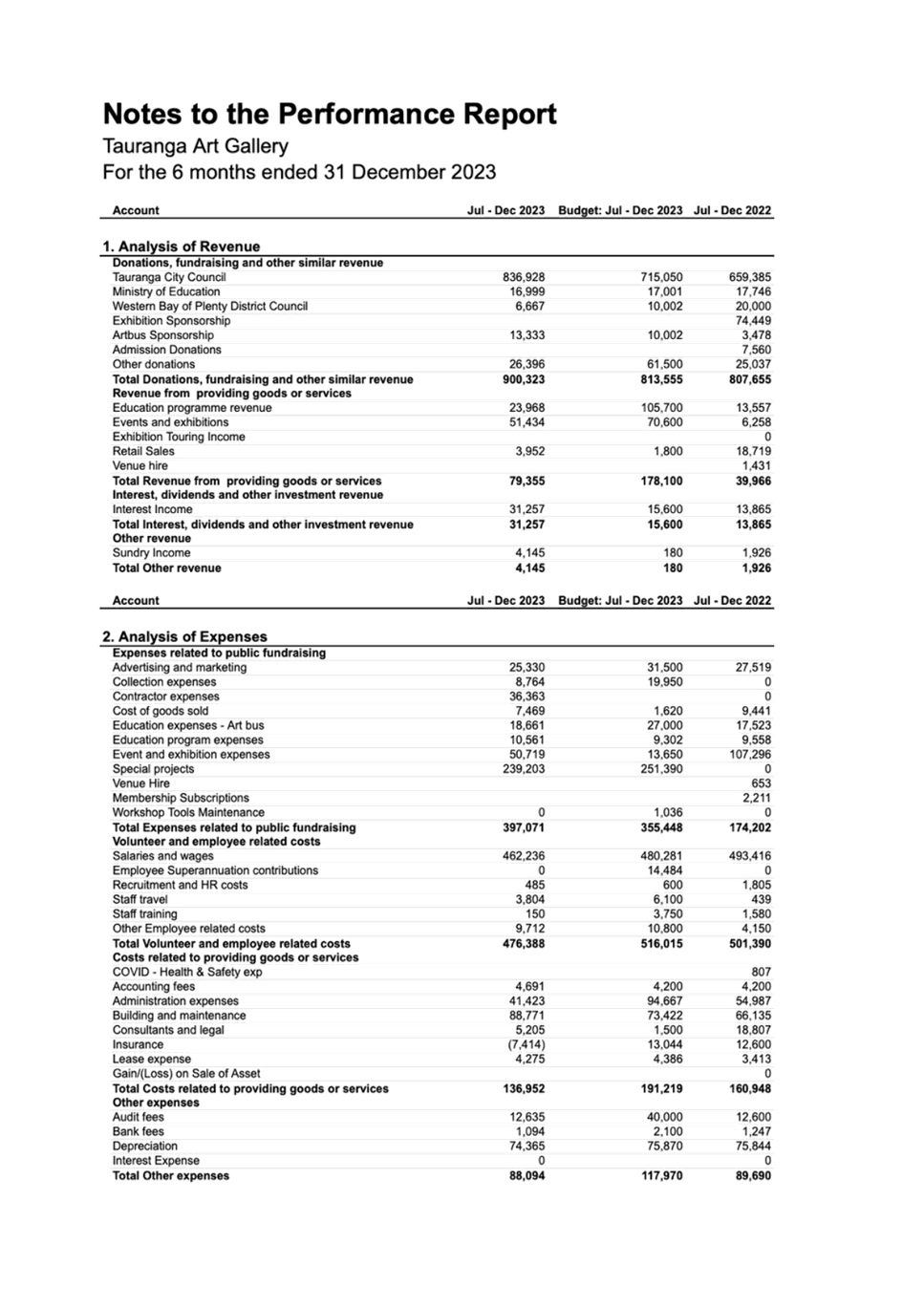

14. TAGT had a deficit of $83,425 over the six-month period, compared to a deficit of $62,819 over the same six-month period in 2022.
15. The Gallery received 14,446 visitors in the six-month period, which is 48% percent of their end of year visitation goal. 4,187 of these visitors were students and art enthusiasts participating in education and engagement initiatives. 92% of visitors were highly satisfied with their visit.
16. Online activity picked up momentum, with over 70,000 viewers choosing to watch talks, tours and/or reels online.
17. With the pending upgrade of Masonic Park and closure of the main Gallery building for redevelopment as part of Te Manawataki o Te Papa’s civic transformation, TAGT opened a Pop Up Gallery and learning centre at 42-44 Devonport Road.
18. Four individual corporate partners aligned with an exhibition in the Devonport Road Pop Up Gallery.
19. In December 2023, Gallery staff moved into temporary offices, co-locating with Tourism Bay of Plenty to enable Art Gallery renovations to begin.
20. Over the reporting period, the Gallery delivered thirteen exhibitions, exceeding their 2023–2024 financial year target of twelve.
21. In line with their performance target, TAGT have been proactively involved with, and collaborating on the development of Te Manawataki o Te Papa, which the Gallery is an important part of. TAGT notes it is committed to the full scope of the project and the futureproofing of the Gallery, while as much as possible, minimising the time it is closed to the public.
Tourism Bay of Plenty (TBOP)
22. TBOP’s report for the six months to 31 December 2023 was received by Council on 27 February 2024 and is included as Attachment 3.
23. TBOP finishes the six-month period in a reasonable financial position, with an overall surplus after tax of $245,840, compared to a budgeted deficit of $195,027. This is primarily due to a mix of timing differences where some expenses will come later than expected, and savings against budget. TBOP expects the results to June 2024 will be on budget at a deficit of around $250,000.

24. TBOP’s progress to date shows seven of ten KPIs are on track, with two a work-in-progress, and one at risk. The social wellbeing KPI shows some risk of not being met, with the percentage of residents agreeing that tourism has a positive impact on the community currently sitting at 13% below target for Tauranga.
25. TBOP delivered key outcomes, including preparation for and hosting the current cruise ship season, continuing to support i-Port and tourism operators, and preparation for the third Flavours of Plenty Festival (April 2024).
26. The Native Nations indigenous youth exchange, inbound tourism operator hosting, and supporting the Omanawa Falls project, have all contributed to TBOP’s elevation of cultural tourism proposition.
27. TBOP continues to contribute significant staff time, resource, and specialist skills in support of a range of Council projects and community priorities. These include a range of action and investment plans, projects relating to major events, cycleways, wayfinding, climate change, city branding, spatial planning, and Te Manawataki o Te Papa.
28. TBOP underwent some office alterations to enable the co-location of the Tauranga Art Gallery back-office team in the TBOP office while the Gallery building is undergoing redevelopment.
29. TBOP notes they are diligently and proactively working to mitigate reductions in their service provision due to significantly reduced opex funding from TCC in the next financial year.
Te Manawataki o Te Papa Limited (TMOTPL)
30. TMOPTL’s report for the six months to 31 December 2023 was received by Council on 13 March 2024 and is included as Attachment 4.
31. This council-controlled organisation was established in 2023 to govern and lead the delivery of Te Manawataki o Te Papa, Tauranga’s civic precinct development. TMOTPL’s projects to be delivered include (but are not limited to) a library and community hub, civic whare, museum and exhibition gallery, aquatics facility and indoor courts, and The Strand waterfront.
32. TMOTPL broke even in the reporting period, with its total revenue and total expenses both being $436,496.
33. TMOTPL’s total assets and total liabilities were both $107,181 in the reporting period.
Te Manawataki o Te Papa Charitable Trust (Charitable Trust)
34. The Charitable Trust’s report for the six months to 31 December 2023 was received by Council on 28 February March 2024 and is included as Attachment 5.
35. This council-controlled organisation, in partnership with the Otamataha Trust, was established in 2023 with two key purposes: (1) To own the land referred to as Site A of the civic precinct, the land bounded by Willow Street, Hamilton Street, Wharf Street and Durham Street, and (2) to support and encourage the development of Site A of the civic precinct, including (but not limited to) a library and community hub, civic whare, museum and exhibition gallery, and the beautification of Civic precinct.
36. Similar to the prior financial year’s annual report, the accounts for the Charitable Trust are still at zero, with no transactions being processed as yet.
37. The land sales agreement is a process which is still in progress, but nearing completion.
Bay of Plenty Local Authority Shared Services Limited (BOPLASS)
38. BOPLASS’s report for the six months to 31 December 2023 was received by Council on 29 February 2024 and is included as Attachment 6.
39. BOPLASS is reporting a $45,032 surplus at their six-month position. They believe the organisation is on track to achieve budget for the financial year.
40. Variances on some areas include council contributions being higher than budget due to an inflationary adjustment, and crime prevention being a new project introduced during the current financial year, which was not originally budgeted for.
41. Of interest to TCC are the following initiatives:
(a) BOPLASS was successful in securing co-funding from the Ministry of Social Development for Crime Prevention initiatives in the Bay of Plenty region. Initial work has been undertaken by an independent CCTV consultancy engaged to conduct a CCTV capability maturity assessment survey of the councils involved in the BOPLASS Retail Crime Prevention project. The assessment will ensure councils’ requirements are qualified, and the outcomes will be beneficial to local communities.
(b) The BOPLASS Health and Safety advisory group continue to collaborate and share resources to manage an increasing trend of aggressive behaviour within public spaces across BOPLASS councils. Comprehensive material and information have been made available to all BOPLASS councils allowing for a collective approach to developing best practice.
Local Government Funding Agency (LGFA)

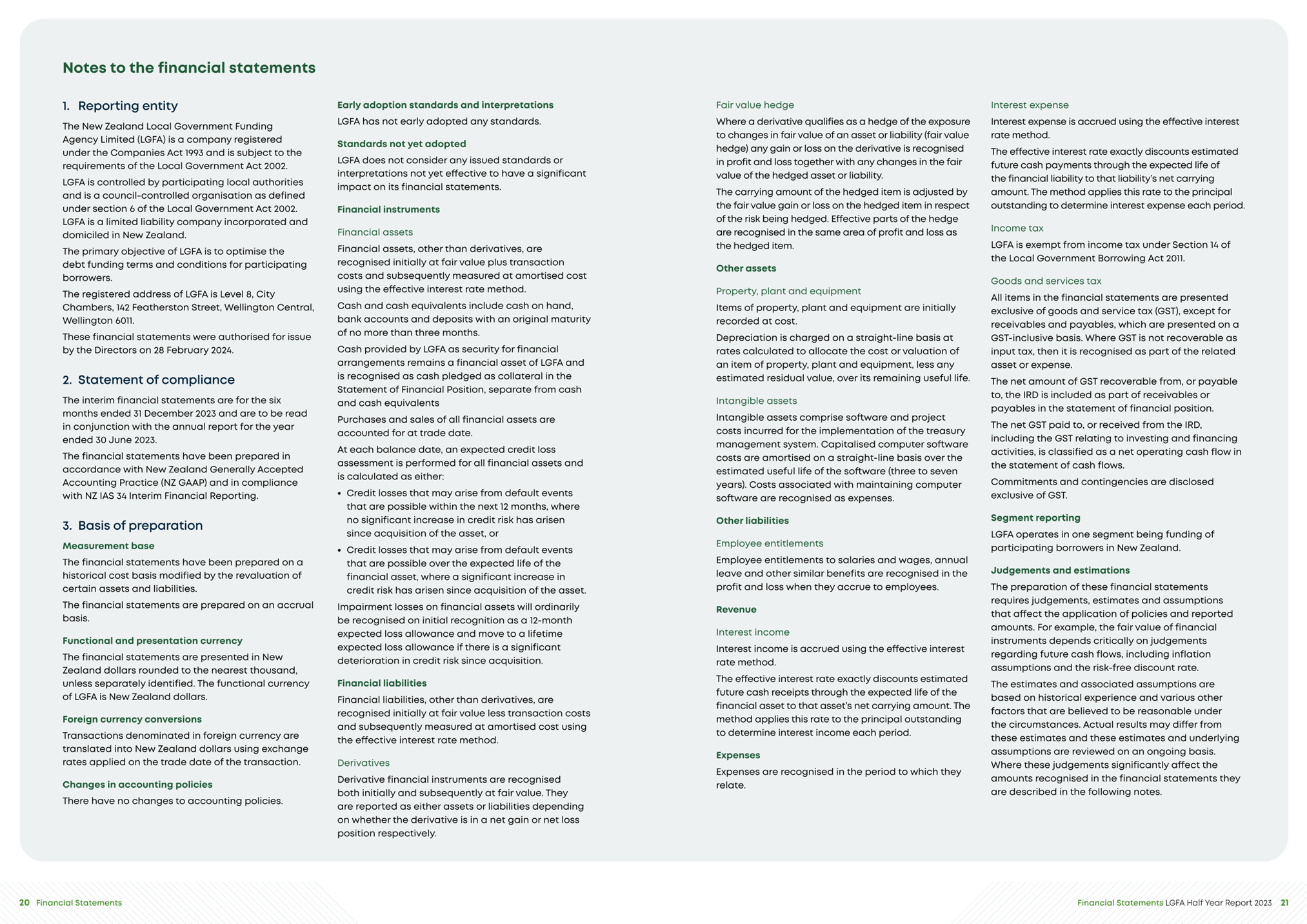

42. The LGFA half year report to 31 December 2023 was received by Council on 28 February 2024 and is included as Attachment 7.
43. LGFA’s Net Operating Profit for the six-month period was $5.2 million, which is slightly below their Statement of Intent forecast due to higher costs from increased issuance, and the establishment and issuance under foreign currency programmes. However, they expect to meet the full year Statement of Intent forecast by June 2024.
44. LGFA has assets of $21.77 billion and Shareholder Equity of $109.4 million as at 31 December 2023.
45. LGFA had a market value of loans outstanding of $18.8 billion, which followed record lending of $2.63 billion over the six-month period.
46. LGFA added two new council-controlled organisations as members over the six months, bringing the number of members to 72 councils and five council-controlled organisations.
47. LGFA issued $1.63 billion of NZD bonds over the past six months, with outstanding bonds totalling $18.92 billion (including $1.10 billion of treasury stock) across 11 maturities ranging between 2024 to 2037. The average term of their NZD bond issuance during the six months at 5.7 years was significantly longer than the prior year period.
48. Highlights over the period included LGFA assisting central and local government with the implementation of the water reform programme, and working with councils and council-controlled organisations members on promoting sustainability.
49. The financial strength of LGFA was affirmed by Fitch Ratings who maintained their domestic currency credit rating at AA+ in October 2023. Their AAA rating from S&P Global Ratings was affirmed in March 2023 and remains the same as the New Zealand Government.
Strategic / Statutory Context
50. In accordance with the Statement of Intent and the LGA 2002, council-controlled organisations are required to report to Council on their financial and non-financial performance six monthly and annually.
51. Council’s partnerships with its council-controlled organisations help us successfully deliver our community outcomes and be a city that attracts and supports business and education, is well planned with a variety of successful and thriving compact centres, values culture and diversity, and is well connected having a key role in making a significant contribution to the social, economic, cultural and environmental well-being of the region.
52. As Council continues to work with the community to develop its strategic priorities through Our Direction – Tauranga 2025, it will work with its council-controlled organisations on how they can help achieve these through the annual Letters of Expectation and Statements of Intent so they are aligned.
Options Analysis
53. As this report, and the half yearly reports received from the council-controlled organisations are for receipt only, an options analysis is not required.
Financial Considerations
54. The financial implications are outlined in the above report and attachments.
Legal Implications / Risks
55. There are no legal implications.
56. While this report outlines council-controlled organisation performance against Statement of Intent measures for the first half of the year, with the ongoing impact of environmental and weather-related events, along with dynamic funding environment at both local and central government levels, there is some risk that the council-controlled organisations may not meet all their Statement of Intent measures by the year end.
Consultation / Engagement
57. Staff have shared the six-monthly reports across the organisation, and they will become available here on TCC’s website following the meeting.
Significance
58. The Local Government Act 2002 requires an assessment of the significance of matters, issues, proposals and decisions in this report against Council’s Significance and Engagement Policy. Council acknowledges that in some instances a matter, issue, proposal or decision may have a high degree of importance to individuals, groups, or agencies affected by the report.
59. In making this assessment, consideration has been given to the likely impact, and likely consequences for:
(a) the current and future social, economic, environmental, or cultural well-being of the district or region;
(b) any persons who are likely to be particularly affected by, or interested in, the matter; and
(c) the capacity of the local authority to perform its role, and the financial and other costs of doing so.
60. In accordance with the considerations above, criteria and thresholds in the policy, it is considered that the matter is of low significance.
ENGAGEMENT
61. Taking into consideration the above assessment, that the matter is of low significance, officers are of the opinion that no further engagement is required prior to Council making a decision.
Click here to view the TCC Significance and Engagement Policy
Next Steps
62. A copy of this report and the resolutions will be sent to each of the seven council-controlled organisations.
63. As required by the amendment to the LGA 2002, following receipt by Council, the half yearly reports to 31 December 2023 for Bay Venues, BOPLASS, TAGT and TBOP will be publicly available on the TCC website for the next seven years.
1. Bay
Venues Ltd Six Monthly Report up to 31 December 2023 - A15691652 ⇩
2. Tauranga
Art Gallery Trust Six Monthly Report to 31 December 2023 - A15706944 ⇩
3. Tourism
Bay of Plenty Six Month Report to 31 December 2023 - A15706945 ⇩
4. Te
Manawataki o Te Papa Ltd 6 Monthly Report to 31 December 2023 - A15706943 ⇩
5. Te
Manawataki o Te Papa Charitable Trust Six Monthly Report to 31 December 2023 -
A15591054 ⇩
6. BOPLASS
Six Monthly Report to 31 December 2023 - A15706946 ⇩
7. LGFA Six Monthly
Report to 31 December 2023 - A15706947 ⇩
8 April 2024 |
11.2 Adoption of Arataki Park Concept Plan
File Number: A15501389
Author: Emma Joyce, Open Space and Community Facilities Planner
Authoriser: Barbara Dempsey, General Manager: Community Services
Purpose of the Report
1. To adopt the Arataki Park Concept Plan noting that it will provide the basis for future development of the park.
That the Council: (a) Receives the report "Adoption of Arataki Park Concept Plan". (b) Adopts the Arataki Park Concept Plan dated December 2023. (c) Notes that any new facility on Arataki Park will only be for play, active recreation and sport purposes. (d) Notes that Council intends to enter into a lease with the Bayfair Foodbank Garden in order for them to continue to occupy space on Arataki Park subject to the provisions for leasing of recreation reserves outlined in the Reserves Act 1977.
|
Executive Summary
2. Arataki Park is an active reserve used primarily for rugby and rugby league. Play spaces are available on the edge of the fields to provide for informal community recreation. The park is also home to the Arataki Community Centre, Baywave, Hato Hone St Johns and Mt Maunganui Plunket. The park is an integral part of Council’s active reserves network and also serves as a central gathering point for the Arataki community and mana whenua.
3. In 2021, Council received a submission from Tātai Ora / Whalers Rugby League requesting lease of space at the Monowai Street edge of the park for a facility that would both provide a home for the league club and a space for delivery of community wellbeing programmes.
4. Following this request, Council became aware of several other organisations who had a similar desire to occupy space on Arataki Park, including from Arataki Sports who previously had their own clubrooms on the park. At the same time, Council completed a feasibility study that identified the park as the preferred site for a future youth hub (a youth centre that provides a dedicated. safe environment for youth/rangatahi to gather, recreate and get access to social services). Staff were also aware that the community garden at the back of the park had no current licence to occupy that space.
5. In order to address these issues, Council embarked on a process to engage park users and the wider community to develop a concept plan that would provide the basis for the park’s future development. This report asks Council to adopt the concept plan to confirm that any future building on the park be for sporting purposes and the primary home for Arataki Sports Club. In addition, the adoption of the concept plan gives certainty that the Bayfair Foodbank Garden can continue to occupy part of the park, subject to a lease.
Background
Issues
6. In order to fairly address a number of requests from community organisations for space and facilities on the park, Council commenced a planning process to engage those organisations and other park users in determining a future plan for the park.
7. Both Whalers and Arataki Sports noted that the current changing facilities available at the Arataki Community Centre are inadequate to accommodate the growth in women’s and junior teams. Both clubs also expressed desire to have a ‘home’ where they could host visiting teams and display club memorabilia.
8. Arataki Sports’ original clubrooms were demolished around 2010 when the community centre became available. The loss of these clubrooms is still felt strongly by club members who recall that the clubrooms once also provided a safe space for the area’s young people. Safety and space for young people are key drivers behind the concept of a youth hub to be located on the park.
Concept Plan process
9. As well as safety, the concept plan process identified other shared values between the various interested parties. These included the park being a space for whānau, being open and accessible and recognition of the park’s history in providing for sport and the community.
10. These values were reflected in community feedback that noted that while the park had a primary purpose to provide for sport and recreation, it was highly valued by the community for its openness, as a space to be outside, and providing a range of activities.
Final concept plan
11. The final concept plan recognises the strong hapū and community support for limiting future buildings on the park and providing a home for the park’s sports clubs. The primary user of any sports facility would be Arataki Sports acknowledging their long history at the park and loss of their previous clubrooms. However, both Arataki Sports and Whalers League acknowledged that they could potentially share a facility so that both clubs had access to change facilities and the ability to host visiting teams. The location of the sports facility would be roughly where the club had their original clubrooms with the entrance off Monowai Street.
12. No other new buildings would be developed on the park with any youth hub being developed as an extension to the existing community centre. This meets the space and open access to the rest of the park identified as requirements for a youth hub in the feasibility study. (It is noted that the development of the youth hub is a long-term project). The concept plan reflects the existing action in the Community Centres Action and Investment Plan to extend the community centre.
13. Through the concept plan process, we were able to build a better relationship with the team who manage the foodbank garden and identify that the area the garden occupies was not required for a sport and recreation purpose. This allows us to develop an up-to-date agreement with the garden to allow for their continued use of the park.
14. Other recommended actions include upgrades to play spaces, development of additional facilities such as toilets and providing for better movement through the park connecting the play spaces and BayWave. Funding to implement these actions will be prioritised from existing Spaces and Places bulk fund budgets included in the 2024-2044 Long-term Plan.
15. The concept plan does not specifically identify space on the reserve for Tātai Ora. This reflects the purpose of the reserve to provide for sport and recreation, noting that health and community services could be delivered from other locations. An expanded community centre or a future sports facility could potentially provide physical space for community outreach services.
Strategic / Statutory Context
16. The park is classified as a recreation reserve under the Reserves Act 1977 and further categorised as an active reserve in the Tauranga Reserves Management Plan (TRMP). This recognises the key role of the park in providing space for organised sport, particularly rugby and rugby league. In general, the TRMP is designed to be flexible, rather than prescriptive, when considering future role of a particular reserve. The TRMP anticipates the development of concept plans when major changes to landscape, amenities or facilities are proposed. A concept plan for Arataki Park was desired to address multiple conflicting requests and give some certainty to existing users as to future use of the park.
17. The TRMP provides for Council to agree a new license to occupy for the foodbank garden. However, a license to occupy assumes that the public will continue to have free access to the area. As the foodbank garden would like to continue to fence their garden, it is more appropriate to grant a lease under section 73(3) of the Act to enable the foodbank garden to have exclusive use of their site. We can grant a lease under this section as the concept plan has shown that the area is not required for sport and recreation purposes as per the park’s classification. The power to determine whether a recreation reserve (or part of a recreation reserve) is not likely to be used for purposes of a recreation reserve and to enter into a lease has been delegated to Council as the administering authority. Consultation with iwi hapū and public notification of the proposed lease is required under the Act, including the opportunity for people to object. The terms of the lease, including the length, will be negotiated with the garden with the fee determined by Council’s user fees and charges.
Options Analysis
19. Council could choose to adopt or not adopt the concept plan. The advantages and disadvantages of each option is outlined in the table below.
Option |
Advantages |
Disadvantages |
|
1 |
Adopt Arataki Park Concept Plan (recommended) |
· Provides certainty to current and future users around future use and gives direction on any future requests for space on the park · Acknowledges the community’s desire for the openness of the reserve to be retained · Provides a coordinated set of actions to improve the park over time. · Enables the foodbank garden to retain its space on the park |
· Less flexibility to develop the park. |
2 |
Do not adopt Arataki Park Concept Plan |
· Potentially more flexibility to develop the park. |
· Likelihood of future requests to occupy space on the park · Less certainty for current park users, including foodbank garden, on their long-term occupation of space · Lack of coordinated direction for the park. |
Financial Considerations
20. There is no specific funding to implement the concept plan. However, funding may be made available through existing budgets for play and community spaces included in the draft LTP. In particular, funding could be made available from the proposed budgets for new toilets and implementing the Play, Active Recreation and Sport Action and Investment Plan as well as upgrades determined through the renewals programme. As a 30 year plan, it is anticipated that the masterplan will be implemented over time as budget is made available.
21. At the time of the concept plan development, Waka Kothahi funding was available to construct the shared path in front of the pump track and a renewal of the bike rack outside BayWave. This funding has since become unavailable. Both the path and bike rack have been included in the concept plan should this funding become available again.
22. A council resolution agreeing to a lease of land may support Arataki Sports to access external funding to develop a facility.
Legal Implications / Risks
23. There is a risk that without the concept plan that Council will continue to receive requests from organisations to locate a facility on the park.
24. As noted above, a minor amendment to the policy is required to allow for the foodbank garden as produce grown at the garden is not for personal consumption.
Consultation / Engagement
25. As well as an initial workshop with park user groups, 1:1 sessions were held with key park users and leaseholders. These helped identify key values to inform the concept plan. A second workshop was held in December 2023 to present the draft concept plan. Key users were generally supportive.
26. A hui with representatives of Ngāi Tukairangi and Ngāti Tapu was held in October 2023. Both hapū expressed support for the wider concept plan development and providing a home for Arataki Sports at the park. As noted above, hapū acknowledged that non-sports users had the option to occupy or lease other space. Hapū noted that while the park has limited cultural significance, any redevelopment should consider opportunities to better incorporate cultural narratives into the design.
27. Feedback from the wider public was received via an online survey run in September and October 2023. The survey showed strong support for retaining the open feeling of the park and to provide a home for the park’s sporting groups. Feedback was also received through consultation on the Mount to Arataki Spatial Plan in support of a facility for Arataki Sports Club.
28. Staff have also worked with Transport to ensure transport-led projects such as the shared path and bike shelter renewal are included in the concept plan and will be developed as funding is made available.
29. Public consultation, including consultation with hapū, will be required of any new lease.
Significance
30. The Local Government Act 2002 requires an assessment of the significance of matters, issues, proposals and decisions in this report against Council’s Significance and Engagement Policy. Council acknowledges that in some instances a matter, issue, proposal or decision may have a high degree of importance to individuals, groups, or agencies affected by the report.
31. In making this assessment, consideration has been given to the likely impact, and likely consequences for:
(a) the current and future social, economic, environmental, or cultural well-being of the district or region
(b) any persons who are likely to be particularly affected by, or interested in, the decision.
(c) the capacity of the local authority to perform its role, and the financial and other costs of doing so.
32. In accordance with the considerations above, criteria and thresholds in the policy, it is considered that the decision is of low significance.
ENGAGEMENT
33. Taking into consideration the above assessment, that the decision is of low significance, officers are of the opinion that no further engagement is required prior to Council making a decision.
Next Steps
34. Staff will prioritise the delivery of actions within the concept plan and support Arataki Sports to develop plans for a facility on the reserve.
35. Larger capital projects would be developed for consideration through a future Long Term Plan process.
1. Arataki
Park Concept Plan - A15590123 ⇩
8 April 2024 |
Resolution to exclude the public
