|
|
AGENDA
Ordinary Council meeting Monday, 18 March 2024 |
|
I hereby give notice that an Ordinary meeting of Council will be held on: |
|
Date: |
Monday, 18 March 2024 |
Time: |
9.30am |
Location: |
Bay of Plenty Regional Council Chambers Regional House 1 Elizabeth Street Tauranga |
Please note that this meeting will be livestreamed and the recording will be publicly available on Tauranga City Council's website: www.tauranga.govt.nz. |
|
Marty Grenfell Chief Executive |
Membership
Commission Chair Anne Tolley |
|
Members |
Commissioner Shadrach Rolleston Commissioner Stephen Selwood Commissioner Bill Wasley |
Quorum |
Half of the members physically present, where the number of members (including vacancies) is even; and a majority of the members physically present, where the number of members (including vacancies) is odd. |
Meeting frequency |
As required |
· To ensure the effective and efficient governance of the City.
· To enable leadership of the City including advocacy and facilitation on behalf of the community.
Scope
· Oversee the work of all committees and subcommittees.
· Exercise all non-delegable and non-delegated functions and powers of the Council.
· The powers Council is legally prohibited from delegating include:
○ Power to make a rate.
○ Power to make a bylaw.
○ Power to borrow money, or purchase or dispose of assets, other than in accordance with the long-term plan.
○ Power to adopt a long-term plan, annual plan, or annual report
○ Power to appoint a chief executive.
○ Power to adopt policies required to be adopted and consulted on under the Local Government Act 2002 in association with the long-term plan or developed for the purpose of the local governance statement.
○ All final decisions required to be made by resolution of the territorial authority/Council pursuant to relevant legislation (for example: the approval of the City Plan or City Plan changes as per section 34A Resource Management Act 1991).
· Council has chosen not to delegate the following:
○ Power to compulsorily acquire land under the Public Works Act 1981.
· Make those decisions which are required by legislation to be made by resolution of the local authority.
· Authorise all expenditure not delegated to officers, Committees or other subordinate decision-making bodies of Council.
· Make appointments of members to the CCO Boards of Directors/Trustees and representatives of Council to external organisations.
· Consider any matters referred from any of the Standing or Special Committees, Joint Committees, Chief Executive or General Managers.
· Delegation of Council powers to Council’s committees and other subordinate decision-making bodies.
· Adoption of Standing Orders.
· Receipt of Joint Committee minutes.
· Approval of Special Orders.
· Employment of Chief Executive.
· Other Delegations of Council’s powers, duties and responsibilities.
Regulatory matters
Administration, monitoring and enforcement of all regulatory matters that have not otherwise been delegated or that are referred to Council for determination (by a committee, subordinate decision-making body, Chief Executive or relevant General Manager).
Ordinary Council meeting Agenda |
18 March 2024 |
3.1 Simon Clark - Colliers, Tauranga - Speaking to the City Centre Public Transport Facilities
5 Confidential business to be transferred into the open
6 Change to the order of business
7.1 Minutes of the Council meeting held on 26 February 2024
8 Declaration of conflicts of interest
9 Deputations, presentations, petitions
10 Recommendations from other committees
10.1 Recommendation from Wastewater Management Review Committee 6 March 2024
11.1 City Centre Public Transport Facilities
11.2 2024-2034 Long-term Plan - Other topics
11.3 Transportation Projects Waka Kotahi Funding Considerations
11.4 Transport Resolutions Report No.50
11.5 Revocation of Speed Limit Bylaw (2009)
11.6 Parking Management Plan Update
11.7 Waiari Kaitiaki Advisory Group Representatives
11.8 Update to 2024/25 Development Contribution Charges
13.1 Public Excluded Minutes of the Council meeting held on 26 February 2024
13.2 Spaces and Places - Construction Project Partner Procurement Strategy
13.3 Direct appoint Rolco to a programme of concrete pavement works.
18 March 2024 |
3.1 Simon Clark - Colliers, Tauranga - Speaking to the City Centre Public Transport Facilities Report
Nil
18 March 2024 |
7.1 Minutes of the Council meeting held on 26 February 2024
File Number: A15594477
Author: Shaleen Narayan, Team Leader: Governance Services
Authoriser: Shaleen Narayan, Team Leader: Governance Services
That the Minutes of the Council meeting held on 26 February 2024 be confirmed as a true and correct record.
|
1. Minutes of the Council meeting held on 26 February 2024
|
26 February 2024 |
|
MINUTES Ordinary Council meeting Monday, 26 February 2024 |
Order of Business
1 Opening karakia
2 Apologies
3 Public forum
3.1 Tauriko West - Kainga Ora - Mark Fraser, General Manager of Urban Development and Delivery, with support from Darren Toy and Campbell Larking
4 Acceptance of late items
5 Confidential business to be transferred into the open
6 Change to the order of business
7 Confirmation of minutes
7.1 Minutes of the Council meeting held on 12 February 2024
8 Declaration of conflicts of interest
9 Deputations, presentations, petitions
Nil
10 Recommendations from other committees
Nil
11 Business
11.1 Adoption of Variation 1 to Plan Change 33 - Tauriko West Urban Growth Area
11.2 Transfer of Te Pāhou Reserve
11.3 Links Avenue Transitional Improvements
12 Public excluded session
13.1 Public Excluded Minutes of the Council meeting held on 12 February 2024
13.2 Hairini Bridge Detailed Design Direct Appointment
13.3 Project Update; Civic Whare, Exhibition and Museum
13.4 Te Manawataki o Te Papa Infrastructure Funding and Financing Levy
11 Business (continued)
11.4 Project update; Civic Whare, Exhibition and Museum
13 Discussion of late items
14 Closing karakia
MINUTES OF Tauranga City Council
Ordinary Council meeting
HELD AT THE Bay of Plenty Regional Council Chambers,
Regional House, 1 Elizabeth Street, Tauranga
ON Monday, 26 February 2024 AT 9.30am
PRESENT: Commission Chair Anne Tolley (Chairperson), Commissioner Shadrach Rolleston, Commissioner Stephen Selwood, Commissioner Bill Wasley
IN ATTENDANCE: Marty Grenfell (Chief Executive), Paul Davidson (Chief Financial Officer), Barbara Dempsey (General Manager: Community Services), Nic Johansson (Head of Transport), Christine Jones (General Manager: Strategy, Growth & Governance), Richard Harkness (Project Leader: Urban Planning), Alistair Talbot (Team Leader: Strategic Planning), Andrew Mead (Manager: City Planning & Growth), Alicia Oldham (Team Leader: Strategic and Commercial Property), Simon Collett (Manager Commercial Property), Karen Hay (Team Leader: Cycle Plan Implementation), Mike Naude (Director of Civic Developments), Graeme Frith (Team Leader: Legal & Business Support), Coral Hair (Manager: Democracy & Governance Services), Anahera Dinsdale (Governance Advisor), Janie Storey (Governance Advisor),
Commissioner Shadrach Rolleston opened the meeting with a karakia.
2 Apologies
Nil
External Mark Fraser, Kainga Ora, General Manager of Urban Development and Delivery Darren Toy, Kainga Ora Campbell Larking, Kainga Ora Bryce Donne, Element IMF
Mark Fraser Key points · Noted that Kainga Ora urban development and delivery included land development with land to produce 50,000 homes in New Zealand, most of which was the redevelopment of large tracts of land owned by the Crown. There was also some older land where they were renewing housing and a mix of greenfield projects for urban development. · Kainga Ora was formed in 2019 to continue to be the landlord of 70,000 state homes and to produce more. · As a Crown agency they were responsible for driving housing and urban outcomes where it made sense to do so. · They had been working closely with Council for some years, and developed a partnership with SmartGrowth, and Kainga Ora was considered as a partner in that work. · Fern Cliff farm had been identified to unlock land for housing. Kainga Ora purchased the land two years ago and were looking to develop it alongside Classic Homes and Element IM to unlock housing. · They would also partner with other agencies, including the Ministry of Education, to bring the development to the table and make the most of the opportunities it provided. · Kainga Ora support the notification of the plan change as it was an important step to get growth moving forward and allowed them to work in earnest to begin to unlock the land for housing. · This was an important approach by Kainga Ora to take with the housing as it would move the market beyond a conservative base approach to introduce duplex and terraced housing, making a move towards how the city appeared to want to approach development and density.
In response to questions · In relation to a query regarding the number of dwellings, it was noted that Kainga Ora were keen to support the plan change and were heading in the right direction with regards to the density with the type being beyond what the market may conservatively deliver.
Discussion points raised · Commissioners acknowledged the work done and noted that they had worked closely with Darren Toy and the Crown agency as partners with the development of land and to drive to change to that which was being delivered to the market.
Bryce Donne Key points · Noted his support of the notification of the plan change and looked forward to continuing to work with Council staff and stakeholders to progress the development. · They had been working a long time on this project and had put a lot into it. · Gratitude to Kainga Ora who had brought a lot of financial impetus into the project and they were a lot closer now than would have been without them. |
Nil
5 Confidential business to be transferred into the open
Nil
6 Change to the order of business
Resolution CO3/24/1 Moved: Commissioner Shadrach Rolleston Seconded: Commissioner Bill Wasley That the Item 11.4 - Project update; Civic Whare, Exhibition and Museum be deferred until the conclusion of the public excluded items. Carried |
Resolution CO3/24/2 Moved: Commissioner Bill Wasley Seconded: Commissioner Stephen Selwood That the minutes of the Council meeting held on 12 February 2024 be confirmed as a true and correct record. Carried |
8 Declaration of conflicts of interest
Commissioner Rolleston noted an interest in any discussion that may take place on the government fast track consenting process as he was supporting some of the work being done by the Crown.
9 Deputations, presentations, petitions
10 Recommendations from other committees
11.1 Adoption of Variation 1 to Plan Change 33 - Tauriko West Urban Growth Area |
Staff Christine Jones, General Manager: Strategy, Growth & Governance Richard Harkness, Project Leader: Urban Planning Andrew Mead, Manager: City Planning & Growth Alistair Talbot, Team Leader: Strategic Planning
Presentation attached
Key points · The plan change had been a lot of work over eight years. · Staff wish to acknowledge the partnerships within the project. · A presentation was provided outlining the request approval for public notification of variation 1 to the plan change and an outline of the rezoning of Tauriko West urban growth from rural to a residential zone · The area had a strong footing in the SmartGrowth strategy as a strategic and important growth area which had helped Council to deliver the land supply for urban development. · A variation to plan change 33 was identified as a defined time line to delivery and had procedural advantages in applying residential standards to bring the area in line with the rest of the city and zoning. · Notification provided further opportunity for public feedback to be made on the proposal. · Noted the steps to be undertaken from the process of engagement, to the hearing. · Any technical challenges would mean more investigation work could be needed which could add to the timeframe. · The hearing was due to take place in late 2024 or early 2025, with a decision being made by the end of 2025. · Introduction of medium residential zone and standards across the growth area to enable housing supply. · A small area of properties in the southern area would remain rural as they were low lying and not suitable for development. · Included an increased area of conservation zone and passive open space to reflect the feedback received around the cultural heritage and the interface with the Wairoa River boundaries. · Management of any flood risk was through a minimum building platform. · Average of 25 dwelling per hectare which may become more or less depending on some topographical and landscape features. · Enables one commercial centre and two neighbourhood commercial centres. · Staging was important with Spine Road required to be connected once 2,400 houses had been provided. · Establishment of the growth area was dependent on a transport investment and enabling works improvements. Council and Waka Kotahi had been working on this for a number of years. · Staging allowed up to 2400 homes as determined by the technical assessment, NZTA business case, and the position reached with key partners and stakeholders. · Staging limits does not apply to schools, health, retail and community purposes. · Anticipated that 200 houses would be delivered each year, over a 10-12 year development capacity before reaching the 2,400 threshold. · NZTA were still considering the timing of the broader solution and wider growth across the western corridor and were awaiting the new government policy statement on land transport to be announced. When this was known, it would be determined if it was a one or multi stage development project. Once this was known the consent process could be done to go beyond 2,400 houses. · Presently the Council were taking on the investment and risk and realising that the full development was reliant on the governments delivery of the National Land Transport Programme. · Next steps following adoption was to go through the submission process and public engagement process, review the submissions received and to determine when a hearing was achievable. The Independent Hearing Panel would make recommendations to the Council and decisions would be made. · Working in parallel with that was the NZTA developments, land owners would be lodging earthworks consents with the Bay of Plenty Regional Council, other land owners would be continuing with the development of their schemes and seeking Council consents. Council would also be lodging a comprehensive stormwater consent with the Bay of Plenty Regional Council.
In response to questions · Dependent on the delivery of the enabling works, the first house could be built in 2026 if land owners in the southern section sought consent before the plan change was in place. Otherwise it was like to be 2027. · Discussion ensued on the amount of time this had taken and was still to take and whether there was any way to speed it up as there were people still moving to the area and using the roads resulting in traffic congestion. It was noted that the area had to be developed with the enabling works and that depended on how long it took to deliver as these needed to be understood as they got into construction. The big challenge at present was that it would take 2 years to get the works into place in the northern part of the area. A lot of earthworks was required in the south where the earth had to settle for two years before it could be built on. Pathways to consenting for that part of the development means that the consenting needed to be alongside the plan change rather than to wait until it was adopted. Staff would monitor that once legislation was put in place to assist.
· Adding an additional 1,600 homes would be a live issue throughout the plan change, as with more houses came more cars. However, the land owners would want to deliver all of the proposed 4,000 houses. · Staff were expecting a range of submissions. · The government long term transport upgrades and money for the designation and construction phases also provided opportunities to amend the stages. These would emerge in the next 3-6 months. · Earthworks was driven by the land owners and Council had created an exemption to proceed so that they were able to progress. Kainga Ora had taken up that opportunity and already lodged a consent with Council and the Bay of Plenty Regional Council and the other owners were aware of it and working towards lodging their consents. These were key to the housing as well as the infrastructure. · There were a number of hurdles with the Bay of Plenty Reginal Council Policy Statements and the Freshwater Plan which was not as straight forward if the land was not zoned residential. There was a sense of confidence in the plan change with all those factors taken into account. · The Council was able to make a submission to the plan change once it understood the pending government and NZTA policy plans.. · In response to a query as to whether getting the work on State Highway 29 as one stage being tied into the release of other 1,600 houses as a trigger point rather than going back to another process, it was agreed that issue would be kept on the table as the hearing would not take place until late 2024. · There were significant issues that Council were seeking support and to get endorsement for a submission to government from the Council the of the day. In relation to fast tracking it was noted that legislation had not been introduced to Parliament, but staff were continuing to talk to the Ministry for the Environment and other agencies providing what could be helpful for inclusion once it moves through the Select Committee process in March 2024. A Council submission would be compiled and staff would engage back on content before submitting it. · In response to a query regarding achieving a greater number of homes if the key provisions for three story dwellings met criteria it was noted that the development capacity assessment and range of considerations and from a pure planning perspective there could be as many 75 per hectare or 10,000 homes. In reality this would not be able to happen as there were limitations around transport, infrastructure and the like which would require added benefit. There were also areas where the average would be a lot lower because of land constraints.
Discussion points raised · It was noted that consenting and funding principles were major hurdles and reinforces central government discussions to allow Council to have more ability and to fund the required investment sooner. If they do not they cannot invest in transport and if don’t invest in that, then Tauranga would not get the houses. Council needed to advocate with government for consenting and funding issues, as it was a critical role with the community to deliver homes. There was a need to be bolder on some of the key issues. · It was requested that when the item came back to Council that it include the triggers to the thresholds contained in the variation and whether there was a need to go through the discretionary activity process if those triggers or thresholds were met. When information was provided around a Council submission, how to look at those and noting any other advocacy that Council could discuss with the government. · Outside of this forum Commissioners wished to discuss with staff the engagement of governance during plan change preparation process, to ensure that the process, their engagement and the government response. Consideration of matters included the extensive amount of greenspaces which someone need to pay to maintain. Also to include ensuring that they look at wider areas to influence the growth of the city including commercial areas and the tie back to commercial hierarchy. · Commissioners acknowledged that 8 years had included a lot of work going on behind the scenes, they appreciated the partnership approach with stakeholders and hapu, and taking into account the Wairoa River strategy which was not an easy process. Also the competing drivers and interests with a regional and national overlay. · This would be an excellent case study of how complex and time consuming such processes could be and a helpful exercise to look at what had been done in terms of effort and to share with the government to unlock land, work collaboratively, form partnerships and the like resulting in 4,000 homes. · Acknowledged that this was a momentous day for staff to get this change to this point and for the developers as it was the start of the real journey of getting those 4,000 houses. It would interesting to see what the cost per house was to get it to this stage. |
Resolution CO3/24/3 Moved: Commissioner Bill Wasley Seconded: Commissioner Shadrach Rolleston That the Council: (a) Receives the report “Adoption of Variation 1 – Tauriko West to proposed Plan Change 33”. (b) Adopts proposed Variation 1 – Tauriko West to proposed Plan Change 33 (Attachment 1) for public notification, to implement the Intensification Planning Instrument (IPI) required under the Resource Management Act (Enabling Housing Supply and Other Matters) Amendment Act 2021. (c) Authorises the General Manager: Strategy, Growth and Governance to arrange the public notification process in accordance with the provision of section 95(2) of Part 6 of Schedule 1 of the Resource Management Act 1991 (RMA). (d) Delegates authority to the General Manager: Strategy, Growth and Governance to approve any minor and technical changes to the proposed text amendments contained in Annotated Text, Structure Planning Maps and proposed Planning maps contained in Attachment 1, as required prior to public notification. Carried |
Attachments 1 Presentation Council 26 February 2024 - Tauriko West Variation 1 - Adoption for public notification (A15557102) |
Staff Barbara Dempsey, General Manager: Community Services Alicia Oldham, Strategic Property Advisor Simon Collett, Manager Commercial Property
Key points · The area had been classified late last year and the responses had been overwhelming with all in support of the transfer. · The land would be transferred to the Trust for $1 subject to easements provided for Council to access their infrastructure and services.
In response to questions · There would be no ability to erect any substantial improvements or housing on the land and would be restrictive covenants included around that.
Discussion points raised · Commissioner Tolley noted the audience and thanked Ngāi Te Ahi Settlement Trust Members for their submissions and noted that the transfer made absolute sense. · Commissioner Rolleston acknowledged the Ngai Te Ahi land and surroundings that had been created on the land and noted that it had been an area of contention for a long time. The impact of the infrastructure development, history of Maungatapu and the urban growth on the Trust had been significant as it was a real place of importance, especially with the urupa and stream. He noted that he had worked on the Maungatapu underpass in the early 2000’s and recalled the discussions with hapu at that time seeking a potential transfer. Today was restoring their land and gave a mihi to the whanau who had turned up to witness this important decision and to remember those who were not here present today, especially Huia Kakau. |
Resolution CO3/24/4 Moved: Commissioner Shadrach Rolleston Seconded: Commissioner Bill Wasley That the Council: (a) Receives the report "Transfer of Te Pāhou Reserve "; and (b) Receives the submissions lodged during the public consultation period 13 December 2023 to 19 January 2024; and (c) Agrees to receive the late submission from Buddy Mikaere on behalf of Ngāti Pūkenga Iwi ki Tauranga Trust (the Ngāti Pūkenga runanga); and (d) Approves the reconnection of the land known as Te Pāhou Reserve by way of transfer to the Ngāi Te Ahi Settlement Trust at nil consideration; and (e) Delegates authority to the Chief Executive to negotiate and approve the terms and conditions of the Sale and Purchase Agreement on the following material terms: (i) Purchaser: Ngāi Te Ahi Settlement Trust; (ii) Purchase Price: $1.00; (iii) Property: Reserve Land as described; (iv) Settlement Date: 10 working days following issue of title for the Reserve Land; (v) Conditions of Agreement: Reserve Land title to be subject to registration of easements in favour of Council to enable maintenance and access of Council infrastructure (water main and the stormwater ponds) located within the Reserve Land post transfer; and (vi) Other Key Terms: As may be appropriate based on legal advice received by Council. Carried |
Staff Nic Johansson, Head of Transport Karen Hay, Team Leader: Cycle Plan Implementation
Key points · A community liaison advisory group had been established in 2022. This concluded the work that had been done with the group and implementation of what had been agreed to. · Acknowledgement of the panel who had tested, challenged and worked to achieve great outcomes for all. · This was the last phase for the implementation for the business case which would be wrapped around the implemented change. · It was not appropriate to take out all of the parking at this time, it had enhanced cycling in the vicinity from the challenges they had faced. · The cul-de-sac had been opened in December 2023 and they were now waiting for the traffic patterns to normalise. This also gave Council the opportunity to look at it and to consider options for people in the area to access the services they used.
In response to questions · In response to a query that the testing of normalisation was being carried out too soon due to other roads being closed off and traffic re-routed, it was noted that they would look at extending the period. The congestion was triggered by re-routed traffic from the B to B project which was what had generated the safety issues and primary concern of parents and had also caused a delay in completing the project. SH2 traffic had not returned to the area yet. · Commissioner Tolley noted that it went back further through the Traffic Systems Plan and considered that governance needed to be over the top of some of the planning as at some stage Links Avenue had become a bus link with 200 buses a day in a residential street, with no consultation with that community. Now with the bus lane, Council had to put in the safety measures. As public transport increased, a query was raised as to how many more buses there would be as this issue was the biggest complaint by residents was that the buses should be on the State Highway. There were other locations where there were up to 50 buses a day outside residential homes and it was asked whether the Council or Regional Councillors had looked at or been aware of the effects of that when it was planned. · The Chief Executive advised that the public transport blueprint process had been undertaken by the Regional Council and Tauranga City Council in 2017. Governance was disconnected and did receive and endorse the blueprint but had not understood the full impact on the community, nor appreciated by the Council of the day. B to B had been determined as not suitable for a major bus terminal, however in hindsight it should have been considered. · In relation to the transitional changes proposed, reassurance was asked that the conversations and engagement continue with the community following the initiated changes. It was noted that part of the transitional change was to test the results which was important and before a full business case was finalised for funding into the future. Even though the panel was disbanded they still wanted to know the cost interventions and the challenges the community still face and they along with the community would be kept updated. · The bus stop was an incredibly challenging situation to address as it was by the Golf Road intersection. It had been moved down the road to allow for vehicles to pass as the footpath in that area was quite congested and with cyclists going into traffic lane they were not seen. The cycle lane had been brought into the inside of the lane and bus lane moved down so there was sufficient space for vehicles.
Discussion points raised · Commissioners acknowledged the work completed by the panel and noted that it was not an easy task for residents who cared about their community to grapple with all sorts of rules, people, systems and processes of local government. · Also acknowledgement for Karen Hay for her willingness to work alongside the community with a can do attitude. Residents commented how they had felt they were being listened to and that Karen was doing the best for them. |
Resolution CO3/24/5 Moved: Commissioner Bill Wasley Seconded: Commissioner Stephen Selwood That the Council: (a) Receives the report "Links Avenue Transitional Improvements. (b) Endorses the Links Ave Safety Improvements Phase 3 for Implementation. Carried |
Resolution to exclude the public
Resolution CO3/24/6 Moved: Commissioner Stephen Selwood Seconded: Commissioner Shadrach Rolleston That the public be excluded from the following parts of the proceedings of this meeting. The general subject matter of each matter to be considered while the public is excluded, the reason for passing this resolution in relation to each matter, and the specific grounds under section 48 of the Local Government Official Information and Meetings Act 1987 for the passing of this resolution are as follows:
Carried |
At 11.53am the meeting adjourned.
At 11.59am the meeting reconvened in public excluded.
11 Business (continued)
Staff Paul Davidson, Chief Financial Officer Mike Naude, Director of Civic Developments Graeme Frith, Team Leader: Legal & Business Support
Key points · The Gateway process for Te Manawataki o Te Papa outlined the next steps and how the gateway was being working through to move the project forward and provided a financial strategy update. · A further report would be provided to the 18 March 2024 Council meeting once the LTP deliberation process had been worked through. · The ratepayer contribution was limited to $151.2M with the balance from non-ratepayer sources and staff were confident the amount could be achieved. · All of the development design work had been completed and had gone through a stringent value engineering process to ensure that cost savings could be realised. The detail design was now currently underway and expected by the end of May 2024. · Two major steps had taken place within the development, including the commencement of the enabling works comprising of service relocations, capping and services for the site set up, the demolition of the existing floor pad on the corner of Willow and Hamilton Streets and the commencement of excavation and temporary retention works. · It was always envisaged that the site works would be carried out in a sequential process and at present the rap piling was underway for Library and Community Hub and expected to be completed by mid-March 2024. The machinery would then move across to commence the rap piles for the Civic Whare, Exhibition and Museum. · There were a number of trades and building materials that needed to be secured by way of a deposit to ensure that they were included in production line for the time they would be needed. This included timber components, structural steel, lifts and façade work. The importance of the façade was that the manufacturers were involved in completing and working with the architect on the final design of the fabrication of that item.
In response to questions · Confirmation was needed for the ground conditions and foundations when installing the rap piles and would remove considerable risk for the contract. · In response to a query as to the project being increased to $306M it was noted that the additional work included the Art Gallery upgrade. The Civic Whare, Exhibition and Museum component was $126M. · Costs were secured and based on the fixed contract and the price that was locked in at the time it was ordered. The Council would only be paying deposit on the early procurement items now with the major cost being in the third quarter of 2027-28.
Discussion points raised · Commissioners noted that they had consulted with public on Te Manawataki o Te Papa to be completed as one project with the reasoning that it would result in considerable cost savings. The feedback received also confirmed that as Tauranga had a history of not finishing projects. · It made sense that while large equipment was on site, that it move from one site to the next. This was also the same as there were different ground conditions. · In relation to the early procurement of materials, Commissioners noted that the erection of the wooden structure for 90 Devonport Road was a different way of building and putting the construction together. Getting into the construction line to have the supplies when they were needed was critical to the timeline of the delivery of some of the items. It was fiscally prudent to go ahead with early works to enable and order materials for delivery, making up 25-30% of the construction cost. |
Resolution CO3/24/7 Moved: Commissioner Stephen Selwood Seconded: Commissioner Shadrach Rolleston That the Council: (a) Receives the report "Project update; Civic Whare, Exhibition and Museum". (b) Notes that Te Manawataki o Te Papa Limited endorse the approach outlined in this report for CWEM Stage 1 Enabling Works and the CWEM Stage 1 Procurement of materials and early trades. (c) Notes that an update will be presented to a future Council meeting updating progress on the financial strategy for the funding of Te Manawataki o Te Papa noting that work continues consistent with the principles outlined in the previous Financial Strategy presented to the Council meeting of 24 July 2023. (d) Confirms authority for the Chief Executive to enter contracts on behalf of Council for CWEM Stage 1 Enabling Works and the CWEM Stage 1 Procurement of materials and early trades in accordance with approved delegated financial authority processes, subject to prior recommendation from Te Manawataki o Te Papa Limited. Carried |
Nil
Commissioner Shad Rolleston closed the meeting with a karakia.
The meeting closed at 12.11 pm.
The minutes of this meeting were confirmed as a true and correct record at the Ordinary Council meeting held on 18 March 2024.
........................................................
Commission Chair Anne Tolley
CHAIRPERSON
18 March 2024 |
10 Recommendations from other committees
10.1 Recommendation from Wastewater Management Review Committee 6 March 2024
File Number: A15646410
Author: Anahera Dinsdale, Governance Advisor
Authoriser: Coral Hair, Manager: Democracy and Governance Services
Purpose of the Report
1. The purpose of this report is to bring a recommendation from the Wastewater Management Review Committee to Council for consideration. At its meeting on 6 March 2024, the Committee passed the following resolution which includes a recommendation to Council.

9.1 – Wastewater Programme Business Case
Committee Resolution WW0/24/1 That the Wastewater Management Review Committee: (a) Receives the report "Wastewater Programme Business Case". (b) Endorse the agreed wording for the three previously outstanding matters.
i. CSF17: Disturbance to Urupā and Wāhi Tapu from Wastewater Infrastructure Must minimise disturbance at identified urupā or wāhi tapu sites, or further disturbance where wastewater infrastructure has already disturbed urupā/wāhi tapu*. *Council and tangata whenua will work as Te Tiriti partners to achieve this. 'Identified urupā or wāhi tapu sites' are defined as those identified as urupā or wāhi tapu in the Register of Significant Maori Areas on the TCC City Plan
ii. KSR5: Gives greater effect to tangata whenua values (Level/Metric: Protecting and Enhancing the Mauri of the Taiao)
iii. KSR6: Promotes opportunities for strong and enduring partnerships with tangata whenua
(Level/Metric: Extent to which impact of existing wastewater infrastructure on iwi/hapū is taken into account or addressed in wastewater decision making.)
(Level/Metric: Decision making quality, authority and capacity.)
(c) Endorse the agreed addition to the list of ‘Tangata whenua considerations’ within ‘Other attributes that need to be given regard to and/or are of interest’: ‘The impact from existing wastewater infrastructure on iwi/hapū, in particular where disproportionate, is addressed or reduced’. (d) On the basis of endorsement being given for recommendation b) i-iii) and c) gives approval for external engagement to commence on the PBC (and confirmed outputs); and, (e) Recommends to Council to endorse the outputs of the Wastewater Programme Business Case (PBC), continue the PBC process and approve the subsequent stages of the PBC commencing, starting with long-list option identification in March 2024 including engagement. Carried |
2. In accordance with Committee Resolution WW0/24/3 ( e) Council is now asked to consider the recommendation to endorse the outputs of the Wastewater Programme Business Case (PBC) as set out in Attachment 1, continue the PBC process and approve the subsequent stages of the PBC commencing, starting with long-list option identification in March 2024, including engagement.
That the Council: (a) Receives the report "Recommendation from Wastewater Management Review Committee 6 March 2024". (b) Accepts the recommendation of the Wastewater Management Review Committee of 6 March 2024 and (i) endorses the outputs of the Wastewater Programme Business Case as set out in Attachment 1. (ii) continues the Programme Business Case process; and; (iii) approves the subsequent stages of the Programme Business Case commences, starting with the long list option identification in March 2024, including engagement. |
1. Attachment
- Wastewater Programme Business Case - A15646432 ⇩
Ordinary Council meeting Agenda |
18 March 2024 |
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 1
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 2
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 3
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 4
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 5
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 6
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 7
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 8
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 9
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 10
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 11
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 12
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 13
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 14
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 15
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 16
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 17
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 18
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 19
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 20
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 21
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 22
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 23
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 24
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 25
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 26
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 27
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 28
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 29
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 30
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 31
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 32
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 33
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 34
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 35
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 36
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 37
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 38
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 39
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 40
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 41
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 42
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 43
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Wastewater Management Review Committee
Attachment: Attachment - Wastewater Programme Business Case
Page: 44
18 March 2024 |
10.2 Strategy, Finance and Risk Committee recommendation 19 February 2024 - approval of unbudgeted loan funded operating expenditure for Kennan Road Business Case and Wairoa Bridge Cycleway contribution to safety works
File Number: A15662244
Author: Coral Hair, Manager: Democracy and Governance Services
Authoriser: Christine Jones, General Manager: Strategy, Growth & Governance
Purpose of the Report
1. The purpose of this report is to bring a recommendation from the Strategy, Finance and Risk Committee to Council for consideration. At its meeting on 19 February 2024, the Committee passed the following resolution which includes a recommendation to Council.
Committee Resolution SFR1/24/1
Moved: Commissioner Stephen Selwood
Seconded: Commissioner Bill Wasley
That the Strategy, Finance and Risk Committee:
(a) Receives the report "Q2 Financial Monitoring Report to 31 December 2023".
(b) Recommend to Council to approve unbudgeted loan-funded operating expenditure and associated rates-funded debt retirement over a five year period:
(i) $379k for Keenan Road Business case
(ii) Wairoa Bridge Cycleway contribution to safety works $1.1m
Carried
2. In accordance with the Committee recommendation SFR1/24/7 (b) (i) and (ii) Council is asked to approve unbudgeted loan-funded operating expenditure and associated rates-funded debt retirement over a five-year period for Keenan Road Business Case and Wairoa Bridge Cycleway contribution to safety works.
That the Council: (a) Receives the report "Strategy, Finance and Risk Committee recommendation 19 February 2024 - approval of unbudgeted loan funded operating expenditure for Kennan Road Business Case and Wairoa Bridge Cycleway contribution to safety works". (b) Accepts the recommendation of the Strategy, Finance and Risk Committee recommendation SFR1/24/7 of 19 February 2024 and approves unbudgeted loan-funded operating expenditure and associated rates-funded debt retirement over a five year period for (i) $379k for Keenan Road Business case (ii) Wairoa Bridge Cycleway contribution to safety works $1.1m |
Nil
18 March 2024 |
11.1 City Centre Public Transport Facilities
File Number: A15465966
Author: Shawn Geard, City Centre Transport Advisor
Tom McEntyre, Principal Investment Advisor: Transport
Authoriser: Nic Johansson, Head of Transport
Purpose of the Report
1. To present to Council the recommended option of the long-term public transport facility in the city centre, and seek approval to proceed to detailed design and implementation of the Durham Street South Super Stop.
That the Council: (a) Receives the report "City Centre Public Transport Facilities". (b) Adopts the city centre bus facility locations, (i) Durham Street South super stop, between Elizabeth Street and Spring Street – three stops in each direction utilising Option 1a or Option 1b. (ii) Civic Centre split stop – a set of four stops consisting of one stop in each of these locations: (1) West side of Willow Street, north of Harington Street (2) North side of Harington Street, west of The Strand (3) South side of Hamilton Street, west of The Strand (4) South side of Hamilton Street, west of Willow Street. (c) Dive Crescent super stop, adjacent to the Cargo Shed – three stops in each direction. (d) Durham Street, adjacent to Baycourt (a single stop in each direction). (e) An inter-regional stop is provided on the south side of Elizabeth Street, east of Durham Street. (f) Adopts the following implementation timeframe: (i) Expand Durham Street South – mid 2024 (ii) Civic Centre split stop locations are to be implemented alongside the City Centre Enabling Movement Project, with the exception of the Hamilton Street stop (west of Willow Street) being implemented by 30 September 2028; and (iii) Elizabeth Street inter-regional stop – mid 2024 (g) Notes that these stops are to be funded through existing budget lines, with or without New Zealand Transport Agency Waka Kotahi (NZTA) funding, pending their future decision on the business case process. (h) The following bus stops are adopted for removal: (i) Durham Street, between Spring Street and Wharf Street, once the Durham Street South super stop has been commissioned; (ii) East side of Grey Street (outside 45 Elizabeth Street) once the Durham Street super stop has been commissioned; and (iii) Willow Street, between Hamilton Street and Wharf Street, by 30 September 2028. |
Executive Summary
2. The interim bus hub has now been operating from Durham Street, between Spring and Wharf Streets, for a period of 21 months, longer than the previously agreed 18 months, and requires relocation to its long-term location.
3. The new long-term city centre bus stops are to be spread across the city centre in a way that allows public transport to be an attractive mode of transport, by allowing a much larger portion of the city centre to be within easy access of public transport, while still providing locations where passengers can move readily between bus services.
4. The super stop sites allow all services to utilise the location, including within long-term Public Transport Reference Case scenarios, providing connection between services, these require:
(a) wide footpaths to provide a high degree of service for customers waiting for a bus, and pedestrians walking along the street;
(b) sufficiently flat grade to enable accessibility for all users; and
(c) room for six bus bays (three in each direction).
5. Infill bus stops within the city centre are to be provided at key destinations, providing infill accessibility where a super stop location is unfeasible due to locality constraints, as such:
(a) these stops, upon implementation by Bay of Plenty Regional Council of a more frequent bus network, will exceed capacity and only be serviced by select routes; and
(b) limited waiting facilities will be provided at these stops – this will include architecturally designed shelters and seats for less mobile passengers.
6. Tauranga City Council staff have been proceeding with a business case through the NZTA business case process. Due to limitations associated with balancing public transport benefits with city centre constraints, it is possible that NZTA will not approve this business case. It is therefore proposed that Tauranga City Council may proceed without their associated co-funding (Funding Assistance Rate = 51%), as there is a commitment to relocate from the current temporary facility.
Summary of all proposed bus stop locations within the city centre
7. The following locations are a summary of the bus stops proposed within the city centre:
(a) Durham Street South super stop, between Elizabeth Street and Spring Street – three stops in each direction.
(b) Civic Centre split stop – a set of four stops consisting of one stop in each of these locations:
i. West side of Willow Street, north of Harington Street
ii. North side of Harington Street, west of The Strand
iii. South side of Hamilton Street, west of The Strand
iv. South side of Hamilton Street, west of Willow Street.
(c) Dive Crescent super stop, adjacent to the Cargo Shed – three stops in each direction.
(d) Durham Street, adjacent to Baycourt.
(e) An inter-regional stop is provided on the south side of Elizabeth Street, east of Durham Street.
Background
8. The old Willow Street central bus hub was removed to allow for the redevelopment of the Civic Precinct and eventual closure of the Willow Street (Wharf Street to Hamilton Street), to provide a large public space.
9. On 6 December 2021, Tauranga City Council made Resolution CO23/21/8:
That the Council:
(a) Receives the report, and
(i) Approves the relocation of the central bus hub from Willow Street to Durham Street between Spring and Wharf Streets (Option 1), for a period of no longer than 18 months from the date that the new hub opens;
(ii) Approves funding of $1.75M in the Annual Plan for relocation of the central bus hub;
(iii) Meets with the Tauranga members of the Bay of Plenty Regional Council Public Transport Committee, and appropriate staff, to discuss and resolve concerns relating to the implementation of the interchange at the location chosen (Option 1);
(b) Agrees that investigations into a long-term solution for public transport in the CBD commence immediately in collaboration with the Bay of Plenty Regional Council.
10. The interim bus hub on Durham Street, between Spring and Wharf Streets, was opened on 13 June 2021. On 13 December 2023, it will have been operating at that site for 18 months and requires relocation as directed by Tauranga City Council resolution CO23/21/8,
11. The City Centre Public Transport Hub Single Stage Business Case has been ongoing from late 2022, and has been presented by numerous setbacks relating to balancing outcomes within a very constrained city centre.
Strategic / Statutory Context
12. The Urban Form and Transport Initiative (UFTI)’s Connected Centres was endorsed by the SmartGrowth Partners. This programme is built upon a high-quality public transport network. The UFTI Connected Centres Programme includes an action to ‘Confirm locations for PT hubs and interchanges in the central corridor (in consideration of TNL connections decisions).1
13. A priority activity in the Transport System Plan (TSP) is to deliver a safe and accessible city centre public transport facility – this was re-confirmed through the recent TSP Refresh. This is to support the wider city centre redevelopment, mode shift, and environmental outcomes.
14. Tauranga City Council adopted the City Centre Action and Investment Plan (CCAIP) in August 2022, which detailed the city centre development plan over a ten-year period. It sought to combine the strategic outcomes, along with the spatial and transport/movement plans that were to be delivered. From a public transport perspective, it identified an agreed public transport ‘spine’ as (from the north) Dive Crescent, The Strand, Hamilton Street, Durham Street and Elizabeth Street.
15. The long-term solution for public transport in Tauranga has been defined through the Public Transport Reference Case and is currently being further developed through the City Centre Public Transport Business Case, and the network-wide Western Bay of Plenty Public Transport Services and Infrastructure (PTS&I) Business Case. Both business cases are built upon the recommendations of the Public Transport Reference Case, and are currently ongoing. The PTS&I Business Case is also incorporating the agreed Public Transport Spine with respect to city centre routing.
16. To maximise the commercial and residential development proposed within the city centre area, it is critical that public transport enhancements are made to provide travel options, and support congestion/parking constraints.
Options Analysis
17. The options available for Council in respect to city centre wide public transport facilities are:
(a) Do nothing and maintain the existing facilities.
(b) Adopt the recommendations of this report (the recommended option).
(c) Withhold a decision pending further work on the Bay of Plenty Regional Council Public Transport Service and Infrastructure Business Case, maintaining the status quo until a decision is reached.
(d) In regards to the Durham Street South stop location, there are two subset options:
i. adopt the location of Durham Street between Elizabeth Street and Spring Street, with final arrangements subject to further stakeholder engagement; or
ii. adopt Durham Street between Elizabeth Street and The University of Waikato within the current parking bays.
Super stop summary
18. The recommended option consists of two large bus stops, referred to as ‘super stops’.
19. The southern super stop will be at Durham Street South, with two possible arrangement options:
(a) Option 1a – an expanded Durham Street South would encompass the full length of Durham Street, between Elizabeth Street and Spring Street, and provisionally would consist of three stops in the area currently occupied by car parking, and three stops within the planted area, while attempting to address concerns around bus stop density and safety, and maintain as much public amenity as possible.
(b) Option 1b – a condensed Durham Street South encompassing the current concrete apron carparking between Elizabeth Street and the University of Waikato; or
20. Both Durham Street South options are preferred due to:
(a) Being located along the Public Transport Spine identified within the CCAIP.
(b) Providing six bus stops that can accommodate the expected increase in public transport services and passengers.
(c) Providing a high degree of access to key destinations in the southern part of the city centre.
(d) It is located in a high-use area, with active frontages that provide a high degree of passive surveillance and security.
(e) It will provide an improved user experience as it located in an area with wider footpaths, accommodating both waiting customers and pedestrians.
(f) This super stop will be located close to an inter-regional stop on Elizabeth Street, to enable connectivity between the local and inter-regional services.
21. The northern super stop will be at Dive Crescent (adjacent to the Cargo Shed) and is the preferred northern super stop location in the city centre, as:
(a) It is located along the Public Transport Spine noted within the CCAIP. However, it is not along the route for Otumoetai services, which use Willow Street north of Harington Street.
(b) It provides six bus stops that can accommodate the expected increase in public transport services and passengers.
(c) It provides accessibility to the waterfront and other adjacent locations.
(d) It is located on a key route into the city centre, providing for passive surveillance and security.
22. The CCAIP had indicated that there would be a Civic Centre super stop along Hamilton Street. Following further investigation, this has been altered to a pair of regular stops. This is due to the grade that exists towards the western end of a super stop in this location exceeding the maximum allowable ramp grade within the NZTA Pedestrian Planning and Design Guide (>8%). This would lead to unsafe situations and become challenging to use, in particular for people using prams, wheelchairs, or carrying luggage.
Southern super stop options
23. The suitability of sites has been considered within the City Centre Public Transport Business Case, with input from Waka Kotahi, Bay of Plenty Regional Council, Priority One, CCS Disability Action, Age Concern, University of Waikato, Grey Power, Western Bay of Plenty Disability Support Trust and Sustainable Bay of Plenty.
24. Discussions with key stakeholders along the proposed Durham Street South location have indicated significant concerns arising from Option 1b (refer to below table). These concerns are centred around bus (and bus user) intensity and safety within this space, leading to consideration Option 1a.
25. The next stage of this option consideration would be to undertake wider stakeholder engagement of possible wider (between Elizabeth and Spring Street) arrangement options, to develop a cohesive and workable bus stop facility.
26. The three options within the table below are noted as the City Centre South super stop options:
|
Option 1a: Expanded Durham St South (between Elizabeth St and Spring St) |
Option 1b: Durham St South (south of the University of Waikato) |
Option 2: Existing Location of Durham St North (Spring St to Wharf St) |
Access to key destinations |
High |
High |
Moderate |
Gradient |
Minimal gradient Proposed Grey St laneway will provide an accessible route |
Minimal gradient Proposed Grey St laneway will provide an accessible route |
Noticeable gradient for access to Willow St |
Footpath width |
4.3m |
4.3m |
3.5m |
Kerbside space |
An expanded Durham St South location has ample space for busses to operate independently, while minimising perceived intense bus consistency |
Three bus bays in each direction Stops operate independently |
Three bus bays in each direction Stops operate semi-independently |
Passive surveillance |
Active frontages and passive surveillance provided |
Active frontages and passive surveillance provided |
No active frontages or passive surveillance |
Impact on parking |
Loss of eight on-street car parks. Parking is reinstated at the interim location further north at Durham St (after the relocation), leading to a net gain of nine city centre car parks. |
Loss of 17 on-street car parks Loss of on-street motorcycle parking. Provision of a new loading bay Parking is reinstated at the interim location further north at Durham St (after the relocation), leading to a net zero effect of city centre parking numbers |
Loss of 18 on-street car parks This is no change from current interim situation |
Impacts on Investment |
Requires removal of significant planting and streetscape work undertaken 2018-2019 renewing disruption. |
No pavement work required as this location has been futureproofed through the Durham St upgrade.
|
Road pavement renewal and strengthening along |
Stakeholder Impacts |
Negative impacts associated with removal of recently installed public investment |
Adjacent stakeholders have raised concerns that the density of busses in this location would negatively impact future development in this area. |
Adjacent stakeholders have raised concerns with this location along with impacts associated with not allowing for future capacity. |
Summary |
Impact of investment and public perception significantly impacts option |
Staged move working with adjacent developments, however provides perceived impacts to future developments |
Not recommended as does not allow for long-term required capacity |
27. While Tauranga City Council has invested significantly in Durham Street, between Elizabeth and Spring Streets, it has been assessed as prudent to reconsider a split arrangement where planted space and bus facility can be spread to address key stakeholder concerns, noting that this requires signifant council investment.
28. Proceeding with Option 1a (expanded Durham Street South, between Elizabeth Street and Spring Street) provides the following outcomes:
(a) It allows further stakeholder engagement ensuring the bus facility ties into future development of the area.
(b) Enables streetscape to better tie into proposed developments and reduces concerns the facility will feel overwhelming.
(c) It provides six bus stops that can accommodate the expected increase in public transport services.
(d) It provides access to key destinations in the southern part of the city centre.
(e) It is located in an area with active frontages that provides a high degree of passive surveillance and security.
(f) It will provide an improved user experience as it located in an area with wide footpaths, accommodating both waiting customers and pedestrians.
(g) Likely produces negative impacts associated with removal of public realm installed 5-6 years ago at significant public expense.
29. Option 1b will consider detailed architectural design, minimising perceived negative intensity and safety impacts, could be implemented either all mid 2024 or in a staged approach this staged approach would include:
(a) Detailed work through of stakeholder concerns agreeing design mitigations,
(b) Provision of 1-2 bus stops on the Durham St South, eastern side, implemented middle 2024 in addition to the existing along the western side (providing for busses to utilise Durham St rather than Grey St),
(c) Upgrade of the existing facilities at the current location with architectural modular shelters able to be relocated at a later date in addition to pavement renewal work middle 2024,
(d) Full relocation to the Durham St South location coinciding with implementation of an enhanced bus service.
Infill bus stop summary
30. The location of super stops within the city centre necessitates the inclusion of targeted bus stops to ensure maximum coverage of access to the city centre by bus. These stops do not support the full service capacity of the Public Transport Reference Case.
31. Durham Street outside Baycourt – this pair (one for each direction) of stops will ensure ease of access to Baycourt and is expected to encourage public transport as a preferred mode to events at this venue:
(a) The Baycourt bus stops will not support all bus services running through the city centre. This is to ensure that the single stop (with one bus bay) does not lead to busses queuing to use these. The number of services using this stop will be monitored and made best use of by Bay of Plenty Regional Council as the bus operator.
32. Civic split stops – these four single stops are located to ensure public transport access to the Civic and Justice precincts:
(a) West side of Willow Street, north of Harington Street – this stop will service outbound services to Otumoetai.
(b) North side of Harington Street, west of The Strand – this stop will service outbound routes crossing the harbour bridge.
(c) South side of Hamilton Street, west of The Strand – this stop will service inbound routes crossing the harbour bridge.
(d) South side of Hamilton Street, west of Willow Street – this bus stop location will replace the existing bus stop on the east side of Willow Street, between Hamilton Street and Harrington Street and service city centre bound services from Otumoetai. This location will be implemented by 30 September 2028 with the Willow Street location this replaces being removed at this time.
33. The Civic split stop will provide for all bus services as currently run. Based on the Public Transport Reference Case, there will be an increase in future bus volumes that will necessitate restriction of these stops to selected services.
Financial Considerations
34. The financial cost to construct a Durham Street South super stop is expected to be between $1.5 million (Option 1b) to $3.5 million (Option 1a), subject to completion of a detailed design estimate (this includes streetscape changes associated with a spread-out facility, additional safety improvements, high-quality shelters including foundation, digital information signs, CCTV, and other supporting items). The current budgeted expenditure is based achieving 51% funding from NZTA; loan funding will be required to replace NZTA subsidy if this is not forthcoming.
Legal Implications / Risks
35. N/A
Consultation / Engagement
36. Key messages received during engagement has centred around five key considerations;
(a) Security, both personal and property, as previous city centre stops have been linked to undesirable social behaviours.
(b) Design of space, including the narrow feeling city centre streets have.
(c) Intensity of having up to six buses stopped at any one time within a condensed space.
(d) Loss of parking associated with allocating all spaces within a block to bus stops.
(e) A number of stakeholder have felt left out of the option development process.
37. As part of the City Centre Public Transport Business Case, stakeholder and public engagement occurred. This included businesses located on Durham St, however, did not include businesses on Elizabeth St.
38. Engagement recently commenced with property owners and businesses directly affected by the proposed Durham Street South super stop. This engagement has raised the possibility to expand the Durham Street facility to include the full length between Elizabeth Street and Spring Street, minimising the concerns related to intensity while reducing costs associated with utilising the currently streetscaped section.
39. A Consultation and Engagement Strategy is being prepared to inform users, businesses, property owners, and wider public of the proposed relocation of the bus hub. Consultation is required to place shelters outside neighbouring properties.
40. Based on the recent engagement the City Centre Transport Development Communications Plan will be updated to reflect concerns raised that stakeholders have regular opportunity to partake in engagement sessions, particularly those involved with increasing city centre vibrancy.
41. Based on the recommendations that are adopted, further engagement will centre around Durham Street South arrangement options, including architectural design to incorporate the facility into the streetscape and surrounding developments.
Significance
42. The Local Government Act 2002 requires an assessment of the significance of matters, issues, proposals and decisions in this report against Council’s Significance and Engagement Policy. Council acknowledges that in some instances a matter, issue, proposal or decision may have a high degree of importance to individuals, groups, or agencies affected by the report.
43. In making this assessment, consideration has been given to the likely impact, and likely consequences for:
(a) the current and future social, economic, environmental, or cultural well-being of the district or region;
(b) any persons who are likely to be particularly affected by, or interested in, the matter; and
(c) the capacity of the local authority to perform its role, and the financial and other costs of doing so.
44. In accordance with the considerations above, criteria and thresholds in the policy, it is considered that the matter is of medium significance.
Next Steps
45. If Council approves the recommended option, the programme to deliver the initial changes to Durham Street stops is planned as follows:
Action |
Date |
Council approve bus facility locations |
18 March 2024 |
Detailed design and consultation |
March 2024 – May 2024 |
Approval of Durham Street South bus stop arrangement |
29 April 2024 |
Procure physical works |
May 2024 |
Construction |
June – July 2024 |
1. City
Centre Movement Framework including Bus Facility Locations - A15465798 ⇩
Ordinary Council meeting Agenda |
18 March 2024 |
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: City Centre Public Transport Facilities
Attachment: City Centre Movement Framework including Bus Facility Locations
Page: 1
18 March 2024 |
11.2 2024-2034 Long-term Plan - Other topics
File Number: A15492837
Author: Josh Logan, Team Leader: Corporate Planning
Authoriser: Christine Jones, General Manager: Strategy, Growth & Governance
Purpose of the Report
1. Community engagement on the draft 2024-2034 Long-term Plan (LTP) has been completed. This report is provided for Council to consider proposed responses to other issues raised through consultation.
That the Council: (a) Receives the report "2024-2034 Long-term Plan - Other topics". (b) Approves staff comments on submissions relating to other topics in Attachment 1. (c) Authorises the Chief Executive and General Managers to make amendments to Council’s proposed response comments to each submission point in Attachment 1, to refine wording and style prior to responses being sent to submitters no later than one month after the adoption of the LTP.
|
Background
2. Public consultation for the LTP was undertaken for a month and ended on 15 December 2023. 2,202 submissions were received, with 119 of these submitters choosing to present at Hearings from 12 February until 14 February 2024. Many topics were covered, including items specifically identified for public feedback in the consultation document.
3. This report covers the other topics which were not specifically consulted on, or which were not covered by other reports on the agenda for the deliberations for the LTP on 4 March 2024.
4. For these other topics, Attachment 1 provides a summary of the points made by the submitter and a proposed Council response.
Strategic / Statutory Context
5. The LTP sets out our community outcomes, direction, budgets and work plans for the following 10 years.
Options Analysis
6. Council has the following options in regard to this report:
(a) Accept all of the responses as drafted and approve them for communication back to submitters.
(b) Formally amend some or all responses before approving them for communication back to submitters.
7. Further, if Council considers that any of the matters covered in Attachment 1 warrant a separate decision-making process, those matters should be identified and advice taken on the appropriate procedural route for that decision-making i.e. whether a new report is required and, if so, what the realistic timeframes for that decision-making may be.
Consultation / Engagement
8. A formal submission process was undertaken for the LTP using the Special Consultative Procedure under the Local Government Act 2002.
Significance
9. The Local Government Act 2002 requires an assessment of the significance of matters, issues, proposals and decisions in this report against Council’s Significance and Engagement Policy. Council acknowledges that in some instances a matter, issue, proposal or decision may have a high degree of importance to individuals, groups, or agencies affected by the report.
10. In making this assessment, consideration has been given to the likely impact, and likely consequences for:
(a) the current and future social, economic, environmental, or cultural well-being of the district or region
(b) any persons who are likely to be particularly affected by, or interested in, the 2024-2034 LTP.
(c) the capacity of the local authority to perform its role, and the financial and other costs of doing so.
11. In accordance with the considerations above, criteria and thresholds in the policy, it is considered that the LTP is of high significance. However, the decision sought through this report, to approve or amend commentary response to individual submitters, is considered to be of low significance.
ENGAGEMENT
12. Taking into consideration the above assessment, that the decision required through this report is of low significance, officers are of the opinion that no further engagement is required prior to Council making a decision.
Next Steps
13. All submitters will be sent a letter or an email advising where they can find a summary of all of the key decisions once the LTP has been adopted on 22nd April 2024. All individualised response letters or emails will be sent within one month of adoption of the LTP.
1. 2024-2034
LTP Responses to other topics - A15645397 (Separate Attachments 1)
18 March 2024 |
11.3 Transportation Projects Waka Kotahi Funding Considerations
File Number: A15557294
Author: Kelvin Hill, Manager: Water Infrastructure Outcomes
Tom McEntyre, Principal Investment Advisor: Transport
Authoriser: Nic Johansson, Head of Transport
Purpose of the Report
1. The purpose of this report is to present a summary of potential risk to NZTA/TCC co-funded transport projects due to delayed release of the National Land Transport Fund (NLTF), which is not expected until 31 Aug 2024. This release date is now later than the usual July release due to delayed release of the Government Policy Statement on Land Transport (GPS-LT) which was released on 04 March 24.
2. The NLTF, when released, confirms the level of subsidy investment available to TCC from NZTA, and in which activity classes, over the National Land Transport Period (NLTP) - a three-year funding triennium from July 2024 to June 2027.
3. This report seeks guidance on whether the included projects should proceed during the period between now and the release of the NLTF or be paused to protect from co-funding risk.
4. Continuation of projects, if NLTF funding cannot be sustained, would be at 100% TCC funding. NZTA cannot confirm and retrospective funding to off-set this once the NLTF is confirmed (less the prior agreement for CRS2 pre-implementation phase).
5. Attachment A to this document sets out the 11 projects considered to be at a degree of risk. The projects are listed in recommended priority order, the first 2 have been endorsed by Council as the highest ranked projects. The next 2 projects are considered essential and recommended to be sustained through this period in either option.
That the Council: (a) Receives the report "Transportation Projects Waka Kotahi Funding Considerations". (b) That approval of up to $4million dollars of local shared funding can be budgeted to progress the four identified priority projects, providing this amount is offset elsewhere within the capital program. (c) That delegation be given to General Manger Infrastructure to manage this capital budget process.
|
Executive Summary
6. The GPS-LT released on 04 March 24 is likely to cause late delivery of the NLTF. NZTA have advised this is due for release on 31 Aug 2024.
7. This has the potential to place at risk continued funding that is critical for sustaining current stages, or for progression to further stages, of current TCC transport projects. This could cause the TCC delivery programme to stall in part while awaiting funding confirmation from the NLTF.
Background
8. Currently the TCC Transport Team are delivering a range of projects that are co-funded funded by NZTA. With the recent change in central government, government spending has been reviewed through an updated draft GPS-LT.
9. The projects included in Attachment A to this document align with the Smart Growth, Urban Form and Transport Initiative (UFTI) programme, and Transport System Plan (TSP), and are planned and designed through the NZTA business case approach.
ISSUES
10. The NLTP is likely to be available in August/September 2024, along with the confirmed NLTF co-investment which will allow TCC to progress these project phases. Once this available, should there be prolonged delay in releasing the NLTP/NLTF by Government, this means there is a risk that many projects would need to stop work where no funding approval has been obtained.
11. Funding to continue the planning, design, and implementation of critical transport infrastructure is essential in preparation for the future growth of the city. NZTA have signaled that retrospective funding will not be made available to assist in reducing the cost to TCC in covering any funding gap.
12. The projects included are also prioritised within the Transport System Plan and in alignment with spatial plans which provide the city with clear direction in managing transport requirements for the future. Many of the potentially affected projects are also within the ‘Top 5’ Major Projects – which remain a clear priority for planning, design, and delivery.
13. Additional information relating specifically to Grenada Street will be presented in a separate report in greater detail. This will include information on the safety, parking, intersection signals, and bus-stops within this section of the network.
Options
1. The two broad options available to TCC are; (A) to defer projects until the NLTF is confirmed, or (B) proceed with current programme by using alternate non-NZTA funding.
2. A project-by-project funding breakdown is provided in the attachment to this summary report, including additional project specific comment.
3. Broad option description is as follows;
Option |
Description |
Pros |
Cons |
Option A: Defer decision pending release of the GPS-LT and conformation of NLTP/NLTF. |
Pause or slow planning, design, or delivery stages until NZTA/TCC co-funding can be confirmed by central government through the NLTP, and NLTF (September 2024). |
51% FAR subsidy from NZTA via NLTF for project approved through the NLTP.
Preserves a greater proportion of IFF funds to offset TCC local share of co-funding (49%). |
Incurs planning, design, or delivery delay for TCC and community.
Reputational and relational damage with stakeholders and contractors who have committed to the works.
Project costs will escalate in the future, resulting in higher future total delivery costs to both TCC and NZTA. |
Option B: Proceed with Project Execution. |
Proceed with planning, design, and delivery stages are currently planned or approved accepting risk of GPS-LT and NLTP misalignment. |
Assists in ensuring TCC complies with IFF funding drawdown profile, thereby minimising financial inefficiency in the IFF. Utilising some IFF funding may reduce potential penalties if funding is not spent on eligible projects.
Progresses strategic network improvements faster.
Leverages the existing consultation/engagement supporting the project and enable award of the tendered construction contract. |
Requires TCC to fully fund the implementation which is currently unbudgeted.
Utilising IFF funding on this project may is highly likely to result in reduced IFF funding availability for other future eligible projects. |
Next Steps
14. It is recommended the next
relevant steps are:;
(a) Continue planning based on LTP decisions and on-going RLTP process in lieu of NLTF with options to de-prioritise progression of selected projects if further delay to funding decisions are confirmed by NZTA.
(b) Confirm TCC ability to use non-NZTA funding sources to continue planning, design, and delivery phases of selected projects.
15. Additional reporting and briefs will need to be provided once the final edition of the GPS-LT is confirmed post-engagement and consultation period.
16. A more detailed summary of impacted projects to facilitate the $4million local shared funding will be provided at the meeting.
1. TCC
NZTA Funding of Projects - A15645009 ⇩
Ordinary Council meeting Agenda |
18 March 2024 |
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Transportation Projects Waka Kotahi Funding Considerations
Attachment: TCC NZTA Funding of Projects
Page: 1
18 March 2024 |
11.4 Transport Resolutions Report No.50
File Number: A15590134
Author: Will Hyde, Senior Transportation Engineer
Authoriser: Nic Johansson, Head of Transport
Purpose of the Report
1. To obtain a resolution from the Commission to introduce, amend or remove various traffic controls in the Attachments to the Traffic and Parking Bylaw (2023).
That the Council: (a) Receives the report "Transport Resolutions Report No.50". (b) Resolves to adopt the proposed traffic and parking controls as per Appendix A relating to minor changes for general safety, operational or amenity purposes, to become effective on or after 19 March 2024 subject to appropriate signs and road markings being installed.
|
Executive Summary
2. The Traffic and Parking Bylaw 2012 includes Attachments which list various traffic and parking restrictions. Council can amend the Attachments by Council Resolution.
3. This report sets out amendments to the following Attachments to the Bylaw:
(a) Attachment 6.2: Heavy Motor Vehicles
(b) Attachment 7.1: No Parking Behind Kerb
(c) Attachment 7.7 Mobility Parking
(d) Attachment 7.8: Motorcycle Parking
(e) Attachment 7.9: Parking Time Restrictions
(f) Attachment 7.11: Parking Areas (Leased Zone)
(g) Attachment 7.16: Loading Zones with Time Restriction
4. Appendix A sets out proposed changes for general safety and operational reasons, principally requests from the public or other stakeholders for numerous small changes to parking controls which traffic engineering staff have deemed to be appropriate.
5. All proposed amendments will become operational on 13 February 2024 or when the appropriate signs and markings are put in place.
Background
6. The amendments set out in Appendix A are changes proposed to reflect and support operational and safety needs on the road network.
7. The proposed amendments are minor changes to parking or movement restrictions across the city which have arisen through requests from the public, transportation staff or other stakeholders; changes resulting from approved developments; plus other minor changes deemed necessary by the Network Safety and Sustainability team.
Strategic / Statutory Context
8. The amendments achieve the vision and strategic transport priorities to help make our network safer and easier for people to get around the city.
Options Analysis
9. For the proposed changes related to general operations the reasons for each proposal are described in Appendix A. In each case the problem identified is expected to continue if the proposed amendment is not adopted.
Financial Considerations
10. Negligible – the signs and markings costs associated with general operational changes can be accommodated within existing project or operational budgets.
Legal Implications / Risks
11. The bylaw amendment is needed to allow enforcement of changes deemed necessary for safety and amenity purposes. Council has an obligation to address known safety issues on the road network.
Consultation / Engagement
12. The amendments proposed in Appendix A have been assessed as being of a minor nature.
13. Consultation is generally not required for minor stopping and parking amendments, or other minor amendments required to support operational or safety improvements. Where consultation or engagement has been undertaken, details are provided in Appendix A.
Significance
14. The Local Government Act 2002 requires an assessment of the significance of matters, issues, proposals and decisions in this report against Council’s Significance and Engagement Policy. Council acknowledges that in some instances a matter, issue, proposal or decision may have a high degree of importance to individuals, groups, or agencies affected by the report.
15. In making this assessment, consideration has been given to the likely impact, and likely consequences for:
(a) the current and future social, economic, environmental, or cultural well-being of the district or region
(b) any persons who are likely to be particularly affected by, or interested in, the decision.
(c) the capacity of the local authority to perform its role, and the financial and other costs of doing so.
16. In accordance with the considerations above, criteria and thresholds in the policy, it is considered that the decision is of low significance.
ENGAGEMENT
17. Taking into consideration the above assessment, that the decision is of low significance, officers are of the opinion that no further engagement is required prior to Council making a decision.
1. Appendix
A - T&P Bylaw Amendment 50 - A15643302 ⇩
18 March 2024 |
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Transport Resolutions Report No.50
Attachment: Appendix A - T&P Bylaw Amendment 50
Page: 1
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Transport Resolutions Report No.50
Attachment: Appendix A - T&P Bylaw Amendment 50
Page: 2
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Transport Resolutions Report No.50
Attachment: Appendix A - T&P Bylaw Amendment 50
Page: 3
18 March 2024 |
11.5 Revocation of Speed Limit Bylaw (2009)
File Number: A15591914
Author: Will Hyde, Senior Transportation Engineer
Authoriser: Nic Johansson, Head of Transport
Purpose of the Report
1. To authorise revocation of the Speed Limit Bylaw (2009)
That the Council: (a) Receives the report "Revocation of Speed Limit Bylaw (2009)". (b) Resolves to approve revocation of the Speed Limit Bylaw (2009)
|
Executive Summary
2. This report relates only to the method for recording speed limits, and does not relate to setting or changing speed limits.
3. The National Speed Limit Register (NSLR) provides an online, map-based, central source of speed limits for roads in New Zealand. The NSLR forms part of the Register of Land Transport Records under the Land Transport (NZTA) Legislation Amendment Act 2020.
4. The intention of the Land Transport (NZTA) Legislation Amendment Act 2020 is to create a single source of data for certain land transport decisions, which includes the setting of speed limits.
5. The NSLR is the register (single source) of speed limit data under this Act.
6. Once a road controlling authority has transitioned its speed limit data to the register, any bylaw pertaining to speed limits should be revoked.
7. The speed limit data from TCC’s Speed Limit Bylaw (2009) has been migrated to the NSLR.
8. To avoid the potential for confusion by retaining an active speed bylaw which effectively duplicates the data in the NSLR, the Speed Limit Bylaw (2009) needs to be revoked. The content of the revoked bylaw is required to be retained for a minimum of seven years, but should in any case remain available in perpetuity as a reference source.
Background
9. A Waka Kotahi guidance document relating to revoking speed limit bylaws is appended for reference.
10. Amendments made to the Land Transport Act 1998 in the Land Transport (NZTA) Legislation Amendment Act 2020 established a register of land transport records.
11. The register is intended to be the single source of correct information for certain land transport decisions. Waka Kotahi / NZ Transport Agency is the Registrar of the register.
12. Speed limits are the first category of decisions to be included on the register, and the data is recorded in the National Speed Limit Register (NSLR). The effect of these regulations is that the NSLR will indicate the correct applicable speed limit for a road instead of bylaws maintained by individual RCAs (road-controlling authorities).
13. The benefits of the NSLR are:
(a) better speed limit management leading to improved network performance
(b) providing a single source of truth on speed limits nationwide
(c) greater credibility and public trust
(d) improved accuracy of speed limit sign setting
(e) road controlling authorities can easily update and share road speed limit data in a standard format with each other, Waka Kotahi and the public with improved efficiency as individual RCA registers will not have to be maintained.
14. Bylaws previously created by RCAs are no longer the source of speed limit data once that data has been migrated to the NSLR.
15. Transportation staff have worked with Waka Kotahi to migrate and validate data from the Speed Limit Bylaw (2009) into the NSLR.
16. Council can now resolve to revoke the bylaw.
Strategic / Statutory Context
17. Transition to the NSLR as the source of speed limit data is required under the Land Transport (NZTA) Legislation Amendment Act 2020.
18. The NSLR is now the single source of speed limit data, superseding any previous bylaws. The Speed Limit Bylaw (2009) is therefore no longer required.
Financial Considerations
19. Speed limit data has already been migrated to the NSLR by Waka Kotahi and validated by TCC staff.
20. This change in how speed limits are recorded does not have significant ongoing costs. Any costs are expected to be absorbed into existing operational budgets.
Legal Implications / Risks
21. The Speed Limit Bylaw (2009) has been superseded by the NSLR. The data contained within the bylaw is now contained within the NSLR, and so the bylaw is no longer the legal instrument for the speed limits.
22. Copies of the revoked bylaw will be retained and will be available for future reference if required.
23. It is assessed that there are no legal risks associated with this revocation.
Consultation / Engagement
24. Because the sole reason for the revocation is that the speed limit has been migrated to the NSLR (that is, a “land transport record” for the speed limit has been created in the NSLR), then there is no requirement to consult under section 156 of the Local Government Act 2002 or section 22AB of the Land Transport Act 1998. This is because of section 168AAA(2) of the Land Transport Act 1998 and regulation 13 of the Land Transport (Register of Land Transport Records—Speed Limits) Regulations 2022.
25. It is proposed that the TCC web page which currently provides public access to the Speed Limit Bylaw (2009) be updated to provide a brief explanatory note about this revocation and the change to the NSLR, and to provide a link to the NSLR.
26. Advisory notices will be advertised in the local press.
27. Any public enquiries about speed limits or the speed limit bylaw are, and will continue to be, referred to the NSLR where appropriate.
Significance
28. The Local Government Act 2002 requires an assessment of the significance of matters, issues, proposals and decisions in this report against Council’s Significance and Engagement Policy. Council acknowledges that in some instances a matter, issue, proposal or decision may have a high degree of importance to individuals, groups, or agencies affected by the report.
29. In making this assessment, consideration has been given to the likely impact, and likely consequences for:
(a) the current and future social, economic, environmental, or cultural well-being of the district or region
(b) any persons who are likely to be particularly affected by, or interested in, the decision.
(c) the capacity of the local authority to perform its role, and the financial and other costs of doing so.
30. In accordance with the considerations above, criteria and thresholds in the policy, it is considered that the decision is of low significance.
ENGAGEMENT
31. Taking into consideration the above assessment, that the decision is of low significance, officers are of the opinion that no further engagement is required prior to Council making a decision.
Next Steps
32. The Council bylaws website will be updated to reflect the decision and direct users to the NSLR.
33. Council staff will process the necessary changes to bylaw documentation.
1. Waka
Kotahi guide: process to revoke speed limit bylaws - A15643226 ⇩
Ordinary Council meeting Agenda |
18 March 2024 |
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Revocation of Speed Limit Bylaw (2009)
Attachment: Waka Kotahi guide: process to revoke speed limit bylaws
Page: 1
18 March 2024 |
11.6 Parking Management Plan Update
File Number: A15600108
Author: Reece Wilkinson, Parking Strategy Manager
Authoriser: Nic Johansson, Head of Transport
Purpose of the Report
1. To provide an update on the current situation for parking in the City Centre and Mt Maunganui, seeking a deferral to the implementation of parking management plans.
That the Council: (a) Receives the report "Parking Management Plan Update". (b) Defers the implementation of the following parking projects until March 2025: (i) Extension of paid parking area in the City Centre (ii) Mount Maunganui Parking Management Plan (iii) Or until requirements for an earlier review are met. (c) Notes that staff will report back to Council in March 2025 with updates on the current environment and recommendations on implementation of the Parking Strategy
|
Executive Summary
2. Tauranga is currently experiencing challenges related to the provision of car parking. This is especially evident in the city centre and at Mt Maunganui. Challenges are largely related to availability of parking as well as compliance with time limits.
3. The Tauranga Parking Strategy was adopted by Council in 2021 and applies across the city. The strategy is supported by local Parking Management Plans.
4. There are 5 key outcomes outlined in the Tauranga Parking Strategy:
· Improving vibrant centres and access to centres
· Enabling multi-modal transport system
· Enabling more attractive compact urban form
· Supporting access for all
· Ensuring value for money and best use of resources
5. The City Centre Parking Management Plan was implemented in 2022 with the re-introduction of paid parking in the City Centre. Implementation was scheduled to continue in November 2023 with an expansion of the paid parking areas.
6. Mt Maunganui Parking Management Plan was scheduled to begin with public consultation in November 2023.
7. At the 27 November 2023 meeting, Council resolved to defer further work on both Parking Management Plans due to concerns raised by the community about parking in both areas. Council resolved to revisit the matter in March 2024.
8. It is recommended that further work on both parking management plans is deferred a further 12 months until March 2025. This is due to:
· impending changes to the city centre that are expected to impact parking demand
9. Continued parking pressures at peak times at Mt Maunganui that require further investigations prior to a parking management plan being developed.
10. We intend to undertake extensive conversations with Mt Maunganui businesses to both gather data and to smoothly implement minor works such as updating time limits to better suit locals. This will provide better information and allow adequate time to plan for a parking management plan in 2025.
11. We will continue to monitor occupancy for the city centre and time limit compliance in Mount Maunganui over this time. We will seek approval from council to review Parking Management Plans earlier than anticipated should:
· occupancy constraints remain or compound in the city centre fringe following the completion of major projects, and/or:
· time limit compliance continue to be an issue at Mt Maunganui
Background
12. Parking management is a key issue that affects residents, workers, businesses and tourists in Tauranga.
13. The Tauranga Parking Strategy was adopted by Council in 2021 and applies across the city.
14. The Parking Strategy was developed to guide the provision of carparking across the city and to guide how it was provided and the aspects such as recovery of the costs for the provision of parking. In addition, it linked how parking and parking provision influences aspects such as mode choice and housing intensification.
15. Some challenges faced in the wider Tauranga area outlined in the Parking Strategy are:
· Strong growth and increasing demand for parking
· Availability of parking spaces
· Cost of providing parking for any and all users.
16. he Strategy is to be supported by local Parking Management Plans, which outline specific processes for management and enforcement of parking in local areas.
17. The Tauranga Central City Parking Management Plan was adopted in October 2022, and was followed by the re-introduction of paid parking in the City Centre in December 2022. An expansion of the area where paid parking applied in the city centre was due to occur in November 2023.
18. At the 11 September 2023 Council meeting, Council approved engagement for the development of the Mount Maunganui Parking Management Plan. Initial engagement was due to be undertaken with the affected community in late 2023.
19. At the 27 November 2023 meeting, Council resolved to put both plans on hold, revisit in March 2024 to discuss more holistic initiatives that take into account the compounding challenges throughout the city causing concern for the community.
central city parking management plan and paid parking
20. The Tauranga Central City Parking Management Plan was adopted in October 2022. Prior to adoption, several initiatives had been trialled to manage parking in the city centre, most recently providing two hours of free parking.
21. From 1 December 2022, the two-hour free parking trial ended and paid on-street parking in the city centre was re-introduced. The initial area for charges to be applied was from Harington Street to Second Ave, with a planned expansion to city fringe areas in November 2023.
22. At the 16 October 2023 Council meeting, Council decided to pause the planned expansion of paid parking.
23. Challenges with parking were expected to continue to early 2024 (covered in the November 2023 report) and they continue to do so. Parking demand is expected to be impacted by a number of factors in the city centre for the remainder of 2024, including:
(a) the implementation of the Enabling City Centre Movement Pilot,
(b) completion of the Harrington Street Parking Building,
(c) 160-176 Devonport Rd completion
(d) Te Manawataki o Te Papa
(e) the completion of TCC offices at 90 Devonport Road.
(f) Private developments like Craigs investment partners.
24. Currently parking transaction numbers in the city centre is holding steady and staff continue to monitor for any changes.
Staff recommend that no further changes to paid parking in the city centre are implemented until the effect of these influential projects can be seen. Parking demand is expected to change dramatically in parts of the city over the next year which will require the adjustment of the PMP whether implemented or not. This is likely to be especially evident following Tauranga City Council‘s relocation to new offices at 90 Devonport Road. Holding off will allow the public some certainty while some major changes take place.
mount maunganui parking management plan
25. At the 11 September 2023 Council meeting, Council approved engagement for the development of the Mount Maunganui Parking Management Plan. Initial engagement was due to be undertaken with the affected community from 13 November – 15 December 2023.
26. The purpose of this engagement was to begin initial discussions about how a Parking Management Plan could be implemented within the Mt Maunganui area. No specific plans or details were proposed, and it was simply a request to begin conversations with affected parties, especially local businesses, and residents. A draft plan would then have been presented to Council in March 2024.
27. The initial community response to any potential move towards the implementation of a Parking Management Plan has been relatively negative. There is a high level of community concern about the impact that paid parking may have for residents and visitors, and especially for businesses and workers.
28. It was proposed that no further work be undertaken until March 2024. The challenges for the Mount are expected to continue but the public feedback has been clear. It is expected that occupancy issues in the area will continue throughout 2024 with a slight drop off over winter. Staff are proposing to delay further work for the Mount Parking Management Plan until March 2025.
29. While it is understood that difficulties will continue for some in the Mount, staff will continue to work with business owners and the community on minor changes where possible. Surveys of parking usage will continue in the Mount throughout the year providing a clear image of the situation. Staff will also work closely with the regulatory team to ensure existing time limits are enforced as often as practicable and that these time limits are fit for purpose. TCC’s focus remains around the town centre and Maunganui Rd ensuring there is space for customers to park during peak times.
30. While working with stakeholders in the Mount staff will also work on educating the public on parking as a lever in our transport system. This includes explaining the benefits of higher turnover and further parking controls to businesses and the community. The data collected throughout this time will help drive that discussion. It will allow the community to partake in future discussions around parking management plans with more confidence and knowledge.
31. Staff will continue to monitor compliance with time limitation parking in the area. Currently 100-150 cases of non-compliance with the time limits have been recorded each day surveys are conducted, with the first week of March 2024 seeing 336 cases of non-compliance by comparison 1016 parking tickets were issued over the last 12 months in Mount Maunganui.
Non-Compliance over the last week of February and first week of March (2 days of survey data).
Strategic / Statutory Context
32. The Tauranga Parking Strategy was approved in 2021. There are no strategic issues related to the deferment of any projects, and the strategy remains relevant. The Tauranga Parking Strategy remains a necessary tool for managing increasing parking demand in Tauranga.
33. Alignment with Government Policy Statement
34. On 4 March 2024, the Government released the Draft Government Policy statement (GPS) on Land Transport. The GPS includes four strategic priorities:
· Economic Growth and Productivity
· Increased maintenance and resilience
· Safety
· Value for money
35. The draft GPS also signals an intent to review fines for traffic offences including consideration of indexing the value of infringements to inflation.
36. The current outcomes of the Parking Strategy have natural alignment to the strategic priorities in the draft GPS.
Options Analysis
37. Staff consider there are two potential options to consider:
38. Option 1 – continue to implement planned projects within the previously agreed timeframes (status quo)
Option Description |
Positives |
Negatives |
Continue with planned parking projects as previously agreed: a. extension of paid parking in the city centre b. engage with the community on potential paid parking in Mt Maunganui
|
· Projects delivered with previously agreed timeframes. · Issues with parking have not changed – there is still a need to reflect the true cost of parking through charges
|
· Strong community resistance to increased parking charges. · The volume and pace of change is increasing community concerns about parking charges. · Many of the surrounding issues (lack of other parking options, especially in the city centre) will not be resolved as expected within previously agreed timeframes |
This option is not recommended.
39. Option 2 – Defer all projects (recommended)
Option Description |
Positives |
Negatives |
Defer all three projects. Staff will evaluate how the Parking Management Strategy may best be implemented and report next steps to Council in March 2025. |
· Allows additional time for other projects in the city centre to be completed and create increased parking capacity. · Increases community confidence that council are taking concerns around parking on board. · Allows staff additional time to determine how to implement the Parking Strategy in a holistic manner |
· Current issues with parking will not change · there is still a need to reflect the true cost of parking through charges |
Financial Considerations
40. There continues to be a cost incurred for providing free parking. On-street parking is expensive to maintain and limits the ability for transport corridors to focus on moving people efficiently.
41. Currently Tauranga rate payers subsidise free parking through their rates. The increasing maintenance costs of the transport network is applicable nationwide and does apply to the road network’s parking spaces.

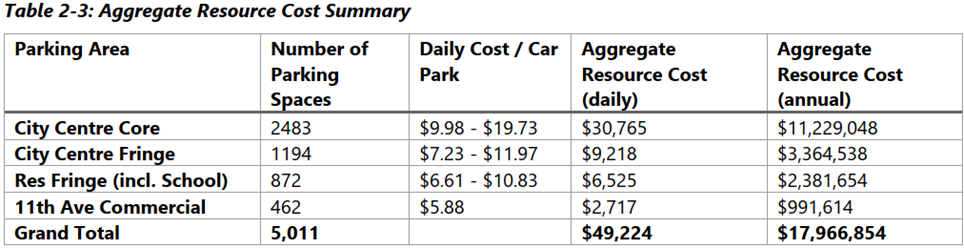

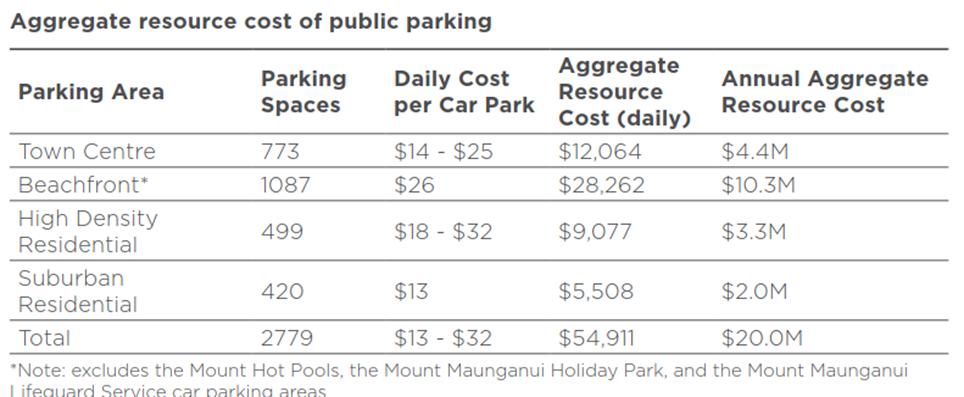

42. The proposed deferment of projects will result in costs associated with free parking continuing to be met through rates, and revenue from existing paid parking in the city centre continuing to be collected. Costs of parking for the City Centre and Mt Maunganui are outlined below.
Mt Maunganui
43. The planned extension of paid parking in the city centre was expected to generate $1,250 in revenue per day. The deferral of this project will result in this revenue not being collected.
Legal Implications / Risks
44. There are no risks associated with the deferment of parking initiatives.
Consultation / Engagement
45. The Draft Parking Strategy was prepared back in 2021, and consultation took place in September and October 2021. As it was a city-wide strategy, consultation took place on high-level topics and principles rather than how these were to be implemented on specific streets. The feedback received led to several updates in the Strategy and was subsequently endorsed by Council on 15 November 2021.
Significance
46. The Local Government Act 2002 requires an assessment of the significance of matters, issues, proposals and decisions in this report against Council’s Significance and Engagement Policy. Council acknowledges that in some instances a matter, issue, proposal or decision may have a high degree of importance to individuals, groups, or agencies affected by the report.
47. In making this assessment, consideration has been given to the likely impact, and likely consequences for:
(a) the current and future social, economic, environmental, or cultural well-being of the district or region
(b) any persons who are likely to be particularly affected by, or interested in, the matter.
(c) the capacity of the local authority to perform its role, and the financial and other costs of doing so.
48. In accordance with the considerations above, criteria and thresholds in the policy, it is considered that the matter is of medium significance.
ENGAGEMENT
49. Taking into consideration the above assessment, that the matter is of medium significance, officers are of the opinion that no further engagement is required prior to Council making a decision.
Next Steps
50. We will investigate options for the future implementation of the Parking Management Plans. A report on recommended future actions will be presented to council in March 2025.
51. Staff will seek approval from council to review Parking Management Plans earlier than anticipated if the following occurs:
· Mt Maunganui – If We do not see improvement with time limit compliance as enforcement continues and the area is surveyed over the next 12 months
· City Centre – We will wait until completion of some major projects which will impact demand on city centre parking. Staff will continue to monitor occupancy throughout the 12 months and if occupancy rates reach 85% or more in the city fringe (as per requirements in the City Centre Parking Management Plan), we will seek approval for the completion of paid parking implementation on the city fringe.
Nil
18 March 2024 |
11.7 Waiari Kaitiaki Advisory Group Representatives
File Number: A15643324
Author: Coral Hair, Manager: Democracy and Governance Services
Anahera Dinsdale, Governance Advisor
Authoriser: Christine Jones, General Manager: Strategy, Growth & Governance
Purpose of the Report
1. The purpose of this report is to endorse and make appointments to the Waiāri Kaitiaki Advisory Group for the Tapuika Iwi Authority and Te Kapu o Waitaha representatives.
That the Council: (a) Receives the report "Waiari Kaitiaki Advisory Group Representatives". (b) Endorses and appoints Raponi Wilson as the Tapuika iwi Authority representative and Luke Whare as the Te Kapu o Waitaha representative on the Waiāri Kaitiaki Advisory Group.
|
Background
2. The Waiāri Kaitiaki Advisory Group (WKAG) was established by consent conditions to provide advice to Tauranga City Council (TCC) and Western Bay of Plenty District Council (WBOPDC) as the joint consent holders in relation to matters covered under Resource Consent #65637, which authorises the take and use of water from the Waiāri Stream for municipal supply.
3. Membership of WKAG, as set out in the resource consent, requires representation from the Tapuika Iwi Authority and Te Kapu o Waitaha.
4. Each iwi/hapū selects their representative and the Council endorses and appoints those representatives to the WKAG.
5. The Tapuika iwi Authority and Te Kapu o Waitaha have advised the Council that they have a change to their representatives. Endorsement and approval for the appointment of Raponi Wilson and Luke Whare is recommended.
6. The WKAG at its meeting on 6 March 2024 acknowledged the work of the previous representatives, Jo’el Komene, Tapuika Iwi Authority and Mokoera Te Amo, Te Kapu o Waitaha.
Strategic / Statutory Context
7. The WKAG is informal in nature and is not established as a committee, subcommittee or other subordinate decision-making body of Council under clause 30 (1) of Schedule 7 of the Local Government Act 2002 (LGA) and does not have any delegated decision-making powers.
Options Analysis
8. The Council has the option to:
(a) endorse and make the appointment of the nominated representatives (recommended) or
(b) not endorse the appointments of the nominated representatives.
Financial Considerations
9. There are no financial impacts from this decision as the remuneration for these representatives are included in the budgets for democracy services.
Legal Implications / Risks
10. There are no legal implication or risks from this decision.
Significance
11. The Local Government Act 2002 requires an assessment of the significance of matters, issues, proposals and decisions in this report against Council’s Significance and Engagement Policy. Council acknowledges that in some instances a matter, issue, proposal or decision may have a high degree of importance to individuals, groups, or agencies affected by the report.
12. In making this assessment, consideration has been given to the likely impact, and likely consequences for:
(a) the current and future social, economic, environmental, or cultural well-being of the district or region
(b) any persons who are likely to be particularly affected by, or interested in, the decision.
(c) the capacity of the local authority to perform its role, and the financial and other costs of doing so.
13. In accordance with the considerations above, criteria and thresholds in the policy, it is considered that the decision is of low significance.
ENGAGEMENT
14. Taking into consideration the above assessment, that the decision is of low significance, officers are of the opinion that no further engagement is required prior to Council making a decision.
Next Steps
15. Advise the decision.
16. Update the Terms of Reference for the WKAG.
Nil
18 March 2024 |
11.8 Update to 2024/25 Development Contribution Charges
File Number: A15648628
Author: Ben Corbett, Team Leader: Growth Funding
Authoriser: Christine Jones, General Manager: Strategy, Growth & Governance
Purpose of the Report
1. To summarise the impact of Long-term Plan 24-34 deliberations on the proposed development contributions charges.
2. To present to Council the development contribution charges which will be incorporated into the Development Contributions Policy 2024/25 for adoption in April 2024.
That the Council: (a) Receives the report "Update to 2024/25 Development Contribution Charges". (b) Notes that the final development contributions charges are based on the decisions made through the Long-Term Plan 2024-34 and Development Contributions Policy 2024/25 deliberations process. |
Executive Summary
3. Staff have updated the draft development contributions charges following Long Term Plan 2024-34 (LTP) and Development Contributions Policy 24/25 (DCP) deliberations earlier this month.
4. Most development contributions (DC) charges have not changed materially compared to the draft DCP published in November 2023.
5. Two catchments have had larger changes:
(a) Wairakei B has decreased by 7.2% as the cost of debt funding capital expenditure has decreased as certain capital expenditure has been delayed through the LTP (meaning debt is not on TCC’s balance sheet for as long); and
(b) Te Papa Infill catchment now has a north and south component,
(i) Total DCs for residential development in the northern sub-catchment have decreased by 18.1% primarily due to the removal of reserve contributions from this area; and
(ii) Total DCs for residential development in the southern sub-catchment have increased by 5.4% due to the increase in Cameron Road Stage 2 capital expenditure budgets and associated finance charges.
(c) Total DCs for non-residential development in the Te Papa Infill catchment have increased by 11.8% also due to the rise in costs of the Cameron Road Stage 2 project.
(d) Updated DCs will be incorporated into the final DCP for adoption in April 2024.
Background
6. Council adopted the draft Development Contributions Policy on 16 October 2023 (Adoption of draft Development Contributions Policy 2024/25) and public consultation was undertaken through November and December 2023. Council considered the feedback from public consultation on 4 March 2024 as part of Long-term Plan 24-34 deliberations (2024/25 Development Contributions Policy deliberations).
7. Following deliberations, staff updated the proposed charges to reflect the outcomes of Council decision-making.
Strategic / Statutory Context
8. Attachment A shows the operative charges, the charges proposed in the draft DCP and the updated charges following deliberations.
9. The table below shows the charges which have changed by 3% or more since consultation. The key drivers of the change are summarised below. All other catchments have changed by less than 3% since the draft DCP, with most changing by less than 1%.
Catchment |
Oct ’23 Draft DC ($) |
March ’24 Final DC ($) |
Variance (%) |
Citywide (3-bedroom) |
34,477 |
31,835 |
-7.7 |
Wairakei B (per/H) |
436,686 |
405.351 |
-7.2 |
Te Papa Infill – south residential (per/Lot) including Tauranga Infill DCs |
12,283 |
12,950 |
+5.4 |
Te Papa Infill – north residential (per/Lot) including Tauranga Infill DCs |
12,283 |
10,055 |
-18.1 |
Te Papa Infill non-residential (per 100sqm of gross floor area including Tauranga Infill DCs |
7,145 |
7,986 |
+11.8 |
10. A sub-catchment has been created within the Te Papa Infill catchment relating to charges for the Reserves activity. Only properties within the Te Papa Infill catchment to the south of 15th Ave will pay reserves DCs.
11. The key changes that have caused changes to the draft DCs are summarised below.
Catchment |
Key driver of change |
Citywide |
The decrease in citywide development contribution charges has primarily been driven by the rephasing of waters capital expenditure within the Long-Term Plan. Later delivery of certain projects impacts each of the components of the DC charge: reducing the total capex where projects are no longer funded in the 2024/25 DCP, increasing inflation expectations where projects have been pushed back and decreasing the cost of holding debt by shortening repayment periods. |
Wairakei B |
Wairakei B fees have decreased compared to the amounts consulted on in the draft DCP. The decrease is largely driven by updates to the Kaituna Overflow stormwater project in Te Tumu. This project budget has increased a small amount since consultation, but the primary change has been the rephasing of delivery through the Long Term Plan. The bulk of the capital expenditure is now due to be incurred from FY33. This change has increased the inflation projections for this project but substantially decreased the cost of capital projection. This is because more DCs will be collected in advance of the expenditure than originally anticipated thereby lowering interest costs. The costs of the wastewater charge have also decreased due to updated funding allocations for the Wairakei rising main projects. |
Te Papa Infill catchment |
The total transport capital expenditure funded from DCs in this catchment has increased by approximately $2m. This is caused by an increase in capital budgets for Cameron Road Stage 2 since consultation. This increases the amount of capital expenditure collected from each dwelling developed and the associated inflation and cost of capital component of DC charges. The total reserves capital expenditure funded from DCs in this catchment has not changed. Since consultation, the full cost of reserves investment has been moved to the south of the catchment (as discussed above). Further, the growth in dwellings has been updated to align with Long Term Plan 2024-34 projections. This has increased the expected growth from consulted levels. Taken together, the updated fees for reserves have not changed materially (a $5 downwards movement). |
Options Analysis
12. Council can either choose to incorporate the updated DC charges into the DCP for adoption, or not. Staff recommend incorporating the updated fees.
Advantages |
Disadvantages |
· Ensures the DCP aligns with TCC’s Long-term Plan, as required by the Local Government Act 2002 · Minimises risk and scale of under-collection of DCs. · Improves the equitable allocation of growth capital expenditure on the community |
· There are no disadvantages to refining the DC charges from those proposed in the draft, noting the draft charges themselves are an increase on existing charges. |
Financial Considerations
13. The financial impact of the matters discussed in this report is limited. This is because the proposed changes are relatively minor refinements to the draft DCP. This decision sits with the broader decision to adopt a new DCP for 2024/25. The decision to adopt a new DCP entails a broader range of financial considerations which have been discussed at length in reports to Council in October 2023 and March 2024.
Legal Implications / Risks
14. The legal implications and risks of this decision have been discussed above.
Consultation / Engagement
15. The DCP has been consulted on as part of the LTP special consultative process. Submissions received were considered as part of the LTP deliberations process.
Significance
16. The Local Government Act 2002 requires an assessment of the significance of matters, issues, proposals and decisions in this report against Council’s Significance and Engagement Policy. Council acknowledges that in some instances a matter, issue, proposal or decision may have a high degree of importance to individuals, groups, or agencies affected by the report.
17. In making this assessment, consideration has been given to the likely impact, and likely consequences for:
(a) the current and future social, economic, environmental, or cultural well-being of the district or region
(b) any persons who are likely to be particularly affected by, or interested in, the matter.
(c) the capacity of the local authority to perform its role, and the financial and other costs of doing so.
18. In accordance with the considerations above, criteria and thresholds in the policy, it is considered that the matter is of low significance.
ENGAGEMENT
19. Taking into consideration the above assessment and the previous consultation undertaken in November and December 2023, officers are of the opinion that no further engagement is required prior to Council making a decision.
Next Steps
20. Staff will update the draft DCP to reflect Council’s resolutions. The updated DCP will be brought back to Council on 20 April 2024 for consideration for adoption.
21. If adopted, the new DCP will be operative from 1 July 2024.
1. Table
of updated development contributions by catchment - A15648665 ⇩
Ordinary Council meeting Agenda |
18 March 2024 |
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Update to 2024/25 Development Contribution Charges
Attachment: Table of updated development contributions by catchment
Page: 1
This page is a placeholder for a single page of a PDF attachment. It will be replaced by the actual PDF page when the PDF version of this document is generated.
Report: Update to 2024/25 Development Contribution Charges
Attachment: Table of updated development contributions by catchment
Page: 2
18 March 2024 |
File Number: A15643274
Author: Nic Johansson, Head of Transport
Barbara Dempsey, General Manager: Community Services
Paul Davidson, Chief Financial Officer
Christine Jones, General Manager: Strategy, Growth & Governance
Alastair McNeil, General Manager: Corporate Services
Sarah Omundsen, General Manager: Regulatory and Compliance
Gareth Wallis, General Manager: City Development & Partnerships
Authoriser: Marty Grenfell, Chief Executive
Purpose of the Report
1. To provide updates on key projects and activities.
That the Council: (a) Receives the report "Executive Report ".
|
Infrastructure
Sustainability & Waste
Tauranga City Council continues to reduce its climate impact
2. We are actively reducing our climate impact, as demonstrated by a 28% reduction in City Waters' carbon emissions and a 33% reduction in overall emissions (Scope 1 & 2) from FY2019 to FY2023. Key initiatives include diverting 50% of biosolids to vermicomposting, upgrading streetlights to LED, expanding solar panel capacity, transitioning the fleet to EVs and hybrids, and making HVAC and lighting upgrades. Tauranga City Council received Toitū's Carbon Reduce certification on 28 February 2024, which validates our commitment.
3. City Waters' emission reduction efforts focus on wastewater treatment, with plans to enhance energy efficiency and install an N2O analyser for nitrogen emissions monitoring. A baseline for embodied emissions in capital projects is established, with ongoing work to integrate carbon impact assessments into project delivery. We are aiming for net-zero emissions by 2050, translating to an annual average reduction of 4.2%. This aligns with the Paris Agreement and New Zealand's Zero Carbon Act. City Waters is excluded, pending a separate roadmap scheduled for completion by year-end. Potential initiatives for achieving the net-zero target include dimming streetlights, installing solar panels, phasing-out natural gas use, and continuing energy efficiency initiatives.
Cruise boat waste reduction project
4. The community waste programme team has been working on a project with Tourism Bay of Plenty and the Port of Tauranga to educate and promote recycling and a litter-free environment in Mount Maunganui over the summer, in conjunction with the cruise boat season. The project started in December 2023 and was completed at the end of February 2024. A contractor and specialised bin station collecting recycling, glass and rubbish were present for a total of 17 selected days (when cruise boats were in the port and when other events were on in the Mount). The team engaged with 618 cruise boat passengers and 183 people who were on holiday in our city, with mostly plastic bottles and glass collected. Final results will be presented to Tourism BOP and the Port of Tauranga on the success of the project.
Kerbside education
5. The Community Waste programmes and partnerships team is undertaking a number of events in February and March to educate and engage with residents around the Ministry for the Environment‘s changes to kerbside standardisation. Tauranga was already leading the way prior to these national changes, so the main change for our community is the removal of aerosols from recycling collections. The team attended Bark in the Park on 24 February and Childrens Day on 3 March; and has a Sustainable Backyards Month recycling talk scheduled for 18 March.
Transport
6. Totara St concrete pavement rehabilitation is now completed, with the new traffic management plan utilised keeping traffic impact to a minimum. The new section of pavement will last around 40 years, three times longer than if it were sealed using traditional asphalt surfacing methods.
7. Co-operative traffic management with NZTA following the discovery of a tomo on SH29A - TTOC and the TMC worked together to assist traffic movements around the city, with proactive monitoring of the network reducing much of the congestion expected as a result of the closure of the affected section of the state highway.
Waters
Water Watchers – Summer Campaign on wise water usage over summer months
8. 30 Service requests have been received since the summer water savings campaign started on 1 December. Complaints have mainly involved the use of sprinklers and water blasters.
9. The team has processed 126 Smart Water Plans. These plans are granted for a range of projects, including pool-filling, water use during construction and events.

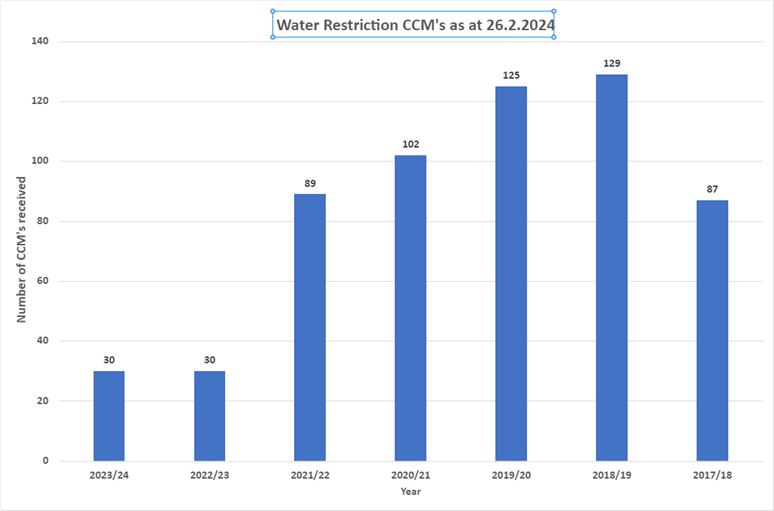

10. On 1 March, the following changes were made to the year-round Water Waters plan. Watering times have changed and usage restrictions have been relaxed so that our community can:
· Throughout March & April sprinklers are allowed for one hour between 4pm and 7pm. You can continue watering anytime with a handheld hose
· Smart Water Plans are NO LONGER required for filling pools
· Customers can use water blasters again for cleaning around the home
· Water Watchers billboards came down on 1 March, but Water Watchers communications (press/radio/social) will continue through Autumn-Spring. Information can be found on Council’s website.
Water Fluoridation – Court Decision Update
11. In July 2022, The Ministry of Heath directed that Tauranga City Council was required to fluoridate the City’s drinking water supplies. There was a subsequent challenge to this ruling and in November 2023, the High Court issued a judgement finding that the Director-General of Health made an error of law by not explicitly considering the NZ Bill of Rights Act. This finding did not change the original direction order.
12. The latest communication from the Ministry is that an assessment against the NZ BIll of Rights Act, specific to Tauranga City, will be undertaken. The Ministry will continue to support local authorities as they implement their directions.
Community Services
The items below are categorised in the most relevant community outcome, but many also contribute to other outcomes.
Tauranga Mataraunui – an inclusive city
13. Te Ao Mārama – Tauranga City Libraries are taking part in a nationwide youth rainbow photography challenge in support of School Pride month, culminating in the photographic works being displayed in nationwide displays.
14. Te Ao Mārama – Greerton Library sees the start of the Just Wanna Have Fun programme aimed at reducing social isolation for seniors. Adult digital literacy classes began in February, with evening sessions on scam spotting, cloud storage, Chat GPT and AI, and maximizing digital workspaces. digital skills classes for tweens have also started, along with a regular coding club for children.
15. Artworks including 19th century paintings from the Library Archive are part of the Tauranga Art Gallery Tauranga Moana Waterscapes: 1800s – Present, which runs through to June. The community can view these in the exhibition curated by Ellie Smith, alongside artworks from the Tauranga Art Gallery Collection, the Civic Art Collection and contemporary local artists.
16. Late last year, Dusty Waddell announced his intention to sell his surf and beach culture collection and following numerous public calls for it to remain in Tauranga, the museum team has secured it for the city. Amassed by Dusty over several decades, it is arguably the best collection of its kind in the country. It includes locally- and nationally-made surfboards, skateboards, textiles and ephemera connected to important makers and individuals. This acquisition has intergenerational relevance and connects to a story that resonates with and excites many local communities.
17. The Venues & Events and Pou Takawaenga teams have been working with local kapa haka groups Tūtara Kauika Ki Rangataua and Te Kapa Haka o Ngāti Ranginui to ensure respectful and authentic engagement for major events in Tauranga. This was demonstrated recently at the South Africa versus BLACKCAPS cricket test, with a pōhiri, call-to-field and an on-field kapa haka performance on Waitangi Day broadcast by TVNZ. An unpaid social media post of the performance gained significant traction with 1,400 engagements of the My Tauranga Facebook.
BLACKCAPS cricketer Neil Wagner cemented Tauranga’s reputation as a great host city through media coverage in the lead up to the test match;
“Tauranga does a great job of hosting international teams and showcasing what a special part of the world this is – and I know the BLACKCAPS and our fellow internationals really enjoy playing here.”
Members of Te Kapa Haka o Ngati Ranginui being interviewed by TVNZ following the call-to-field performance on Day 1 of the test at Bay Oval.
18. Tauranga recently hosted Oceans, New Zealand’s largest Junior Surf Life Saving championships. With over 700 competitors from 46 Surf Life Saving clubs across Aotearoa, the event received support from Tauranga City Council and the Tauranga Western Bay Community Event Fund. This event is part of a series of surf life saving events the Venues & Events team are working with, including the recent Eastern Regional Championships and the forthcoming Surf Life Saving Nationals in March.
19. The recent Waitangi Day Festival and Asian Food Festival at The Historic Village each attracted approximately 4,000 visitors, reinforcing the Village’s role as a vibrant platform for community engagement and cultural celebration.
20. The Historic Village marketing campaigns have resulted in significant improvements in its online presence. Comparing January 2023 with January 2024, there has been a 49% (2,369 to 3,552) increase in total Historic Village website traffic and a significant 267% (1,517 to 5,577) increase in visits to the website home page.
21. Venue and Events marketing has resulted in a notable increase in website traffic to My Tauranga - the city events website. In January 2024, there was a 128% increase in website traffic compared to January 2023.
22. The Emergency Management team was involved in the Bark in the Park event in February. Emergency preparedness is just as important for pets and animals as it is for humans and this event is a perfect opportunity for us to talk to pet owners. We even had our own ’Stan the Dog‘ onsite to spread the word.
Tauranga Taurikura – A city that values, protects and enhances our environment
23. Our Urban Forest team had its application for Tauranga to be recognised in the 2023 Tree Cities of the World accepted by the Arbor Day Foundation. The Arbor Day Foundation is part of the Food and Agriculture Organization of the United Nations (FAO) and this initiative is an international effort to recognise cities and towns committed to ensuring that their urban forests and trees are properly maintained, sustainably managed, and are duly celebrated. To be recognised as a Tree City, a community must meet five core standards that illustrate a commitment to caring for its trees and forest – Tauranga is now only one of four New Zealand cities that have this recognition.
24. On 27 February, the Urban Forest team celebrated the launch of Rakau, the new Tree Asset Management application for managing the city’s urban forest.
The application replaces the previous tree app, which was out-of-date and no longer fit-for-purpose. The new app is based on the work done to support City Operations with a field solution for the new business unit. The Urban Forest team has worked hard alongside Council Platform managers to develop an application which works in the field and with Council asset systems. This new application will give the team more clarity about the quality of the city’s tree asset, reducing risk and making the team more agile. Additionally, data captured in the app will support decision-making around the development of tree canopy across the city, meeting actions under the Nature and Biodiversity Action & Investment Plan (AIP).
25. Tutarawānanga-Yatton park (Destination Park) gardens rejuvenation, featuring a blend of cottage/native gardens and tree arboretum, a new sealed walkway, and upgraded BBQ and shade areas has sparked positive feedback from the community.
26. Tauranga Museum held a workshop with Te Paerangi, the mana whenua group associated with the Takitimu Northern Link project. Their visit to the Taonga Māori collection was to view archaeological material deposited in the collection and learn about the process artefacts undergo when being processed, in conjunction with iwi and hapū, Tauranga Museum and the Ministry of Culture and Heritage Te Manatū Taonga.
Tauranga - Tātai Whenua – A well planned city
27. The final Tauranga Youth Space Partnership workshop was delivered on 21 February. Attended by 36 sector leaders/workers and four rangatahi, the workshop series received positive feedback, with extensive commentary about the strength of the community engagement and purposeful collaboration of Council. The next steps are to open-up a nomination process for the ‘Tauranga Youth Space Strategic Working Group.
28. Mount Maunganui Holiday Park has retained the 4-star plus rating for the property and achieved the Gold Sustainable Tourism Business Award. A Gold Award recognises the best sustainable tourism businesses in New Zealand. The park has also had a bumper summer season, with visitor numbers up 8.5% (1,914) on the previous year. Over December and January, the park hosted more than 24,000 visitors.
29. The City Operations horticulture team recently cleared out two gardens to improve visibility at a tricky site on the corner of Hewletts Road and Totara Street. Our traffic management partner did a great job at keeping us safe at very busy intersection. As a result, traffic, cyclists and pedestrians now have a clear view of the roadside.
30. The Horticulture team has also been systematically upgrading Papamoa street gardens, to get them back into specification. With a huge number of gardens within traffic management areas, a targeted project was completed to tidy-up and reduce the ongoing maintenance of the splitter islands. Splitter islands require additional traffic management controls and the gardens in this area haven’t been renewed since installation. These will be replanted or resurfaced in Autumn. The joint effort pulled together staff from the Structures and Natural Vegetation teams to upgrade 30 splitter islands in three days.
31. We hosted Commissioners Selwood, Rolleston and Wasley at our City Operations Tauriko Depot on 31 January. The team had a great time showing the Commissioners the depot and sharing their passion for maintaining our city.
32. We recently completed the installation of athletics throwing circles at Gordon Spratt Reserve. In partnership with the Papamoa Athletics Club, which has more than 300 members ranging from 3 to 14 years old, we co-funded the renewal of two shotput circles and one discus circle with safety cage. The work was well-received by the Athletic community, with Tatiana Kaumoana (NZ Senior Woman’s Discuss Champion) and Harrison McGregor (Top 3 ranked Shotput Champion) turning up to try out the new equipment and impressing the children. Build it and they will come!
33. Detailed design for the new Library Community Hub was completed and signed-off in February. Engagement at events and through group presentations is receiving positive feedback about the design and the need for this facility in the city centre.
34. Work continues in preparation for the implementation of the Public Art Framework. A stocktake of current public art has been completed and the new public art panel will be established by the end of April. Proposals for new commissions will be called following the establishment of the panel, in advance of the new funding policy going live on 1 July.
35. The Contact Centre recently ran a day of refresher training for ex-staff across the organisation who may be called upon to help-out with resourcing in a significant business continuity or emergency event. This is a group of approximately 15 staff who received systems and Knowledgebase training.
36. The LIM management team and staff involved in natural hazards recently engaged with the Department of Internal Affairs (DIA) regarding the drafting of regulations relating to the new LIM legislation. This legislation will come into force on 1 July 2025. Discussions related to options for the best framework to provide natural hazard information to LIM applicants. This information can often be complex, but the intent is to ensure it is as understandable as possible. The LIM and natural hazards teams have designed a draft natural hazard framework to present this type of information in LIMs and have shared this with DIA.
Tauranga Ara Rau – A city that we can move around easily
37. The Mount Maunganui main beach toilet block area had a well-deserved birthday present, with the City Operations Walkway and Reserves Structures team clearing a couple of feet of sand and re-establishing the boardwalk area.
Tauranga a te kura – A city that supports business and education
38. The Natural Environment team recently spent the morning talking with Toi Ohomai students undertaking Certificate in Conservation (operations) study. As all three Council representatives completed the same course, this was a valuable chance to connect with the institute and students about where their learning and experiences can take them. The team is looking to partner with Toi Ohomai to provide these students with first-hand experience in several current and future projects.
39. February saw the finale party which celebrates the achievements of the children who finished the Kia Kaha te Pānui reading challenge, which over a thousand children participated in (that’s 3,000 conversations about children’s reading). We estimate 1,200 attended the party and enjoyed activities provided by Council and community providers. The challenge itself encourages children to continue reading through the holidays. Feedback included:
“Just to reiterate how impressed I was, how much the kids loved it, and how lovely the staff were. We had a different staff member for each check-in and every one was enthusiastic and engaged with the kids. Thank you!”
“Thanks so much to all staff involved for another fantastic summer challenge. I know a lot of hard work and effort goes into this and it really shows. I especially want to thank all the librarians for all the time they spent sitting down and listening to the kids talk about their books. They asked great questions and really engaged with the kids. Thanks for a fantastic summer at the library!!”
40. Children’s Day - the museum team was part of the Te Manawataki o Te Papa onsite stand during Children’s Day on 3 March. A children’s history hunt was designed for children under the age of 14 and the museum showcased ‘Hands on Tauranga’ objects for families to interact with.
41. Another busy start to the year for Hands on Tauranga. Outreach to schools is fully-booked for the term and we continue to receive positive feedback from teachers, students and whānau, such as:
Megan is a natural storyteller, and is engaging and so knowledgeable, Our kids were lucky enough to have her visit today in preparation for our visit on Friday to The Elms. What a fantastic resource!
XX came home one day last week after you had been in and it's all he could talk about - he LOVED it, especially seeing and holding the artefacts. By the sounds of it, all the kids really enjoyed it!
42. Hands on Tauranga object loans to schools are tracking well, with many teachers taking advantage of the service this term.
43. Our Heritage Collection Programme Specialist recently ran a professional development day for the new volunteer educators and guides at The Elms. This was very well received.
44. The Venue & Events team worked with event organisers Duco, who successfully delivered the sold-out Hot Springs Spas T20 Black Clash on 20 January, with 10,000 attending at Bay Oval. The event was supported by the Council’s Major Event Fund, delivering an amazing event experience for our community and attracting visitation. The benefit of this event is also its strong broadcast coverage, with extensive coverage of Tauranga showcased throughout the TV broadcast, encouraging future visits to the city. This match drew an impressive audience of 1.085 million viewers on TV1, constituting a substantial 22% of the New Zealand population. It was the third-largest viewership in 12 months, behind only the 2023 election and the Coronation of King Charles III.
Chief Financial Officer
Tauranga Airport
Airport Operations
45. There were 2633 flights operated by Air New Zealand during November, December and January, up from 2587 in 2022/23, carrying 140,200 passengers compared to 126,599 passengers in 2022/23, an 11% increase. January saw a 14% year-on-year increase.
46. Flights operated with an average loading of 90%, meaning many people wishing to travel by air are either not being able to travel at a time that suits, or are not able to travel by air at all. Airport management is in ongoing dialogue with Air NZ about the very high load factors, which is a problem being experienced across the regions. Air NZ does not have any more capacity to offer at this stage, and probably not for the next two years, due to a number of the jet fleet having to be out-of-service, four at a time, for urgent non-scheduled maintenance.
Airport Development
47. The replacement of the runway lighting, cabling and navigation aids, which are now owned by the Airport, is now scheduled to be completed in May. The delay has been caused by supply issues.
48. 100 new car parks were opened mid-February, enabling work to commence on the new northern car parks and the tie-in of new to old. This work is scheduled for completion at the end of April, but is partially dependent on BOPRC consents for work on the Aircraft Apron area.
49. The Fire Station project is on track for completion in mid-March.
Strategy, Growth & Governance
Democracy & Governance
Election – 20 July 2024
50. 90 people registered for the Candidate Information Evening and over 120 people attended the evening on Monday, 19 February 2024 at the Holy Trinity Church Hall90 people registered for the Candidate Information Evening and over 120 people attended the evening on Monday, 19 February 2024 at the Holy Trinity Church Hall. Governance expert Dr Jim Mather in the photo below gave a presentation titled “What is great governance?”. He joined the Commissioners, Warwick Lampp (Electoral Officer), Andrew Turner (ex-Deputy Mayor of Christchurch City Council) Tu O’Brien, (Rangitāiki Māori ward councillor, Whakatāne District Council), Matire Duncan (Chair Te Rangapū Mana Whenua o Tauranga Moana), and a panel of James Denyer (Mayor, Western Bay of Plenty District Council), Mary Dillon (Envirohub), Nigel Tutt (Priority One) and Richard Kluit (Matua Residents Association) and Marty Grenfell (Chief Executive) was the MC and concluded the evening on the governance and management relationship.
51. Voter registration in Tauranga is sitting at 89.37%, as at 31 January, with 110,707 enrolled out of an estimated 123,000 eligible voters. This percentage varies depending on age bands, with 18-24 year olds sitting at 75.1% and over 70’s at 96.46%. This information is updated monthly on the Electoral Commission’s website and the Council’s election page links to this website.
52. Electoral Officer Warwick Lampp commented that Tauranga City has benefitted from two national enrolment campaigns by the Electoral Commission for the 2022 local government elections and the 2023 central government elections, which has resulted in a high number of eligible electors being enrolled.
53. Council’s electoral campaign includes a variety of tactics to attract a diverse range of voters, including our harder-to-reach communities, encouraging them to enrol, inspiring them to stand, and most importantly to vote. We’ll use social media, media, short videos, informative interviews with previous councillors and targeted advertising throughout the campaign.
54. Community Development staff attended the orientation week events for the University of Waikato and Toi Ohomai (Te Pukenga), to encourage enrolments among students, and also attended community meetings to raise awareness about the election.
55. Non-resident ratepayers received a flyer with their February 2024 rates notices and letters have been sent out asking current ratepayer electors to confirm they are still eligible to vote as a ratepayer elector. This is a legal requirement each triennial election.
56. Further information on the elections is available on the Council’s election webpage https://www.tauranga.govt.nz/council/about-your-council/elections-2024
Takawaenga
57. Takawaenga is supporting the Democracy team‘s drive for diverse candidates and increased voter participation.
58. Te Rangapū Mana Whenua o Tauranga Moana has confirmed its priorities for the coming year, as follows:
· Māori representation in decision-making, as per the Local Government Act
· ongoing support for papakāinga
· prioritising the protection of the environment in the face of growth pressures, and
· strengthening relationships through two-way conversations.
59. The Kaumatua Forum has also confirmed its support of the above priorities.
60. LTP Submissions have highlighted the ongoing pressure on Māori responsiveness to bureaucratic processes. The solutions proposed have focused on developing capability and capacity. The first can be supported through training and communications, the second through proactive resourcing to resolve response rates and availability.
61. Takawaenga will need ongoing support to enable Māori engagement to be fairly-resourced as the city grows. We will continue to look for cost-effective ways to maintain a genuine and authentic relationship with tangata whenua that helps to create the best possible community-wide outcomes.
Corporate Services
Performance, Monitoring & Assurance
62. Performance, Monitoring & Assurance has worked on the following three dashboards / visual reports:
· Service Request Dashboard: in the final stages of signoff, shows the status and volume of service requests coming through our CCM (Customer Communication Management) system. This provides valuable insights on the volume and type of requests coming through, and management of active requests within teams across council.
· TTOC works closely with Police by mapping incidents over the summer period. The police often contact TTOC to help in locating and tracking incidents using the team’s extensive CCTV system. The GIS team is working on the possibility of creating a live feed from TTOC into the GIS system, to provide further insights.
· The GIS team has also been working on the development of a 3D model of the city. Updates over the past few weeks have seen the model incorporate city plan zones. Of note is the availability of information on council assets, including the height, age and species of the trees below:
People, Performance & Culture, Health & Safety
63. Staff turnover is one measure we use to determine employee engagement, with employee surveys (My Team Pulse) being the primary data source. The next council-wide My Team Pulse is scheduled for March. Teams in Community Services, Corporate Services and Infrastructure will receive the survey on 11 March, with the remaining groups on 13 March. The team is working with people leaders to support the debrief process, with additional support planned for new people leaders to help orientate them to the ISL dashboard and interpret the results. Further pulses are scheduled for June and September
Digital Services
64. The Digital Services team took part in a volunteering day on 7 February, involving a community effort to clean-up and remove rubbish from the Waikareao Estuary. Groups of 5 or 6 people were given a zone to work in and not only enjoyed themselves, but collected 150kg of waste. Downer provided an after-event BBQ.
65. Artificial Intelligence (AI) - over the last two weeks, we have seen a rise in the number of AI services and tools being (or about to be) imbedded in the common tools we use, such as Adobe Reader and web browsers. This poses a risk to the Council being able to meet its privacy obligations. The Digital Service teams are looking at how we can put in place lighter review processes to minimise the risk posed by these services and tools, as we do not have the capacity to run full security and privacy reviews on every service/tool currently in use.
66. Security Operations Update - our Security Operations Provider (PWC) is investigating and closing an average of 300 cases (suspected incidents) per month and escalating to the TCC team and average of 11 validated threats for further investigation. This significantly reduces the amount of time our internal team needs to spend cutting through the noise, and allows them to focus on genuine threats, as well as investing time in improving our overall security position. PWC gives us the visibility to see what is going on with a security lens across our environment, and with 24/7 monitoring, we are able to respond as the event happens.
Community Relations
67. Media - December saw the Media Impact Score (MIS) rise almost a point to 2.8, the highest level in almost two years. Coverage was overwhelmingly focused on recreation & environment themes and covering the opening of a number of projects led by Spaces and Places. In January the MIS dropped to 2.0. Negative coverage was centred around political criticism of the long-term plan and commissioners' commitment to continue setting the plan, as set out in their Terms of Reference.
68. Social Media - the organic posts with the largest reach in January were:
· Road closures for the Sikh Parade – 72k audience reach / 3.7k post engagement - 75 comments and 98% positive reactions.
· Mount Maunganui roundabout - Smiley face Poll - 22k audience reach / 5.1k post engagement - 266 Comments and 100% positive reactions.
69. The Community Relations team plans to produce more content and quick polls like this which capture the imagination of the community and provide simple ways for people to have their say.
Regulatory & Compliance
Building Consents
70. Building Services received 103 Building Consent and Amendment applications in January, for a total of 1201 applications year-to-date (YTD). While this year is slightly up compared with January 2023, it is around half of the average January volumes in 2019-2022. The YTD figure is 7% less than the same period in 2022, but 30-40% down compared with 2019 – 2021.
71. We granted 135 consents and amendments in January, for a total of 1174 YTD. The volume of consents granted is also down compared with previous years, reflecting the reduced number of applications received. We refused one application in January for a total of 53 applications refused YTD.
72. The proportion of consents granted within statutory timeframes dropped to 78% in January. Every consent that exceeds the 20 working day timeframe is investigated, and the reason for not meeting the timeframe is recorded. This month, the reduced compliance rate was influenced by the granting of a number of very old consents; an error in Objective Build which affected a small number of consents; and the non-availability of some of our specialist staff and contractors (particularly structural engineers and development engineers) over the summer break. The issue with Objective Build effectively delayed the receipt of Request for Information responses from customers and understandably caused some frustration for our staff and customers. However, we are satisfied that this issue has now been fixed and we have not seen any recurrence.
73. Over the past three months, we have put a particular focus on getting our backlog of historic applications out. We had 94 applications in progress that were already over day 20 at the start of October. By the end of January, that had reduced to only 22 of those applications still in progress. Further, if you look at the consents granted in January that were received in the three months prior to granting, 96% of these were granted within statutory timeframes. These figures are significantly up on previous results.
74. Inspection wait times for standard (45-minute) inspections have remained low, generally around 24 hours, whereas for our most complex inspection types (for instance R3 Finals) the lead time has hovered around three or four days for most of January. Inspection numbers remain roughly 20% down on previous years, with around 400 inspections completed most weeks. Because wait times are low, there is reduced demand for our remote and weekend inspections.
75. We issued 83 code compliance certificates (CCCs) in January, for a total of 984 YTD. The CCCs issued related to the construction of 20 new residential units. Our compliance with statutory timeframes has remained consistently high, with 98% being issued within 20 working days.
76. The number of new dwellings consented and granted in January was significantly below the forecast demand, with 29 units consented and 20 receiving CCC compared with a forecast demand of 93 per month. The rolling 12-month total, covering the period February 2023 to January 2024, is 655 units consented and 849 units receiving CCC which is 58% and 76% of the forecast demand, respectively.
77. We received confirmation that the last of our non-compliances from our October IANZ assessment was closed on 2 February. As a result, our accreditation has been confirmed for another two years. The IANZ assessor also noted: “It was a pleasure to work with you, and congratulations to you and your team for all the hard work and being positive and collaborative”
78. The number of building compliance investigations commenced has increased slightly. We received 29 complaints in January compared with 22 in January 2023. However, anecdotally, our team has noted that there appears to be more building work proceeding without building consent than previously experienced. This is often a trend observed during periods where the building industry is struggling and individuals attempt to cut corners more frequently. Prompt and effective response to these complaints is particularly important.
79. Our Pool Safety Compliance Officers inspected 76 swimming pools during January. Five of these were found to be non-compliant but were able to be remedied by the end of January. Eight further properties were visited, but the pools were unable to be accessed.
80. Our Building Warrant of Fitness programme continues to perform well. 105 BWOF were due in January and 82 were received on time and demonstrated compliance. In addition to the BWOF process, 33 onsite audits were completed and 27 of those passed. Of the 23 BWOFs not received on time and 6 failed onsite audits, only 7 required the issuing of Notices to Fix in order to achieve compliance, whereas the rest were able to be resolved in a timely manner without formal enforcement.
Environmental Regulation
Alcohol Licensing
81. Between 1 and 31 January, the Alcohol Licensing Team forwarded 119 various alcohol licensing applications to the District Licensing Committee for consideration and determination. A breakdown of the applications is provided in the table below:
Applications forward to the District Licensing Committee |
||
Application Type |
Number |
Year to Date |
OFF Licence (New) |
1 |
3 |
OFF Licence (Renewal) |
8 |
26 |
ON Licence (New) |
2 |
19 |
ON Licence (Renewal) |
5 |
51 |
Club Licence (New) |
|
|
Club Licence (Renewal) |
1 |
9 |
Temporary Authorities (ON & OFF) |
4 |
27 |
Manager (New) |
48 |
228 |
Manager (Renewal) |
42 |
163 |
Special Licence |
8 |
281 |
Total: |
119 |
807 |
82. The team also completed 15 inspections within this period, ensuring that licensed premises were being operated and managed as required under legislation. Year-to-date, the team has inspected 116 licensed premises. These inspections are both scheduled and unscheduled. Two of these involved after-hours inspections of two large events: “One Love” held over two separate days at two separate locations; and the recent “Black Clash” cricket game at Bay Oval. These events attracted an estimated 12,000+ and 10,000+ patrons respectively. According to the licensing inspectors who monitored these events from an alcohol management perspective, they were very well-managed.
83. Three infringement notices have been issued to licensed premises for having no duty manager present onsite during a premises visit. This is in direct contravention to the conditions of the alcohol licence.
Enforcement |
||
|
Number |
YTD |
Infringements |
3 |
13 |
ARLA Suspensions |
0 |
6 |
ARLA Cancellations |
0 |
0 |
Total: |
0 |
19 |
District Licensing Committee Hearings
84. During this latest period, two applications were referred to hearings for determination by the District Licensing Committee (DLC). These applications were for:
· A new on-licence for a bar called “Absolute Vibes” in Mount Maunganui, which was opposed by the inspectorate; and
· A renewal of an off-licence for ‘Fresh Choice Papamoa’, which was opposed by the Medical Officer of Health.
85. The first hearing for “Absolute Vibes” was held, and although the inspector outlined her concerns around the owner’s experience to manage such a high-risk venue, the District Licensing Committee decided to grant the licence with some stringent conditions. The second hearing did not go ahead due to the withdrawal of opposition by the Medical Officer of Health.
District Licensing Committee Hearings Held |
||
Number |
YTD |
|
On Licence |
1 |
7 |
Off Licence |
1 |
4 |
Club Licence |
|
|
Manager |
|
7 |
Temporary Authority |
|
3 |
Special Licence |
|
|
Total |
2 |
21 |
Environmental Health
86. Verification, registration and service request information is provided below.
|
January 2024 |
YTD |
|
Verifications of Food businesses |
37 |
371 |
|
Of the 371 verifications conducted in the year to date, 12 received an ‘unacceptable outcome’. An unacceptable outcome means that the business had a number of non-conformance’s (or a non-compliance) with requirement/s that need to be resolved, and the business’s verification frequency will increase until more compliance is achieved. When a food business receives an unacceptable outcome, they must gain two acceptable outcomes before their verification frequency can be decreased.
|
|||
Registrations |
January 2024 |
YTD |
|
Food Registrations - New |
11 |
143 |
|
Food Registrations - Renew |
38 |
410 |
|
Health Registrations – New |
1 |
7 |
|
Health Registrations - Renew |
1 |
151 |
These are generally renewed August, September, October |
Registrations |
January 2024 |
YTD |
|
Food Registrations - New |
11 |
143 |
|
Food Registrations - Renew |
38 |
410 |
|
Health Registrations – New |
1 |
7 |
|
Health Registrations - Renew |
1 |
151 |
These are generally renewed August, September, October |
Matters of Interest
87. After a great start to the year, verifications are now slightly under target due to losing two verifiers and an administration technician in the last few months. While we have a new verifier and administration officer (both starting in March), we expect that verification targets will be affected in the coming months. We are investigating whether we can find a contractor to assist with these, as our current contractor does not have the capacity to take on further verifications this year.
88. The Ministry for Primary Industries has a proposal out for consultation in which they propose to charge levies to all domestic food businesses each year to cover some of the costs of their agencies activities.
89. It is proposed that every domestic food business will pay a levy of $57.50 per year, increasing to $115.00 per year over 3 years. The proposed levies will be in addition to the fees these businesses currently pay Council for the delivery of registration and verification services.
90. In addition, MPI proposes that Councils collect this money from food businesses on MPI’s behalf. Staff will be preparing submissions in relation to these changes.
Animal Services
91. Actions taken in relation to Animal Services complaints received for January and YTD are provided below:
|
Warnings / Notices |
Abatement Notices |
Dangerous Menacing Classifications |
Infringements Issued |
Prosecutions Commenced |
Jan 2024 |
Barking - 55 |
|
Dangerous - 0 |
|
|
Roaming - 28 |
0 |
Menacing - 7 |
24 |
1 |
|
Aggression - 10 |
|
Section 62 Muzzle - 1 |
|
|
|
YTD |
Barking 263 |
|
Dangerous - 1 |
|
|
Roaming 117 |
15 |
Menacing - 18 |
590 |
3 |
|
Aggression 37 |
|
Section 62 Muzzle - 15 |
|
|
92. The number of registered dogs (YTD) has increased by 483 compared to 31 January 2023. We are projected to exceed 16,000 ‘known dogs’ in the city by 30 June.
Year To Date |
Jan 2023 |
Jan 2024 |
% Of All Dogs Registered |
93.8 |
95.1 |
% Compliance Rate |
96.4 |
99.5 |
93. As officers visit known unregistered dogs, they are finding that up to 35% of these animals are either no longer alive or are no longer at the last known address. The ‘compliance rate’ is the total of known dogs that are either registered or have received an infringement for failing to register.
94. In January, the most significant matter dealt with was a search warrant executed at a Papamoa property, with support from Police and SPCA. This was the result of a large number of complaints from the neighbouring community and saw Council’s largest-ever seizure of dogs from a single property. 13 German shepherds were removed for multiple breaches of the Dog Control Act, including:
· 12 Unregistered dogs
· Failure to microchip
· Breach of a barking abatement notice
· False statement on a dog registration form
· Keeping more than two dogs per occupier of property
1. All the dogs were under-weight and had health issues. The SPCA also removed 40 cats from the property. Council is considering enforcement action.:
|
January 2024 |
YTD |
Bus Lanes |
358 |
7237 |
Parking |
4666 |
36635 |
Freedom Camping |
166 |
503 |
Environmental Planning
96. 436 applications for resource consents and other associated approvals have been received so far in the 2023/24 financial year to 31 January. Application numbers are currently 24% higher than at the same time in 2022/23, with the number of applications received in January being notably higher than previous years. The majority of applications (63%) relate to resource consents for land use or subdivision.
97. In the 2023/24 financial year to date, Council has issued decisions in relation to 388 applications, 254 of which were for resource consents. Timeframe compliance for new applications (i.e. applications received since 1 July 2023) is currently 86%.
98. As noted in the previous report, ongoing process improvements have resulted in time spent processing resource consents being much more accurately captured, resulting in an approximately 66% increase in the average cost for resource consents. This is an important step for ensuring planning services operate on a “user pays” basis. However, the associated increase in costs has also resulted in an increase in the number of objections to fees and charges for resource consents.
99. In the financial year to date, Staff have conducted development contribution assessments for 813 building consents, totalling $11.4 million in contributions; and 229 resource consents, totalling $5 million in contributions. Council continues to receive a number of requests for deferrals for payment of development contributions. There are currently 49 deferral agreements in place, dating back to 2021, with an approximate value of $7 million (noting that deferred payments are subject to the LGFA interest rate).
100. Staff are currently progressing an improvement for how water services are considered in planning processes, which will allow development engineers to easily view capacity information for our water, wastewater, and stormwater networks. This ensures that the appropriate internal teams are consulted throughout the resource consent process, while also streamlining the review process to decrease the time required for review
Environmental Monitoring
101. Staff have responded to 196 RMA incidents and monitored 521 resource consents in the financial year to date.
102. A total of 3629 noise complaints have been received in the financial year to date, with 973 requiring a response.
103. Staff continue to see a high number of noise complaints through the beginning of 2024, which is in line with expectations around summer activities.
104. Council is currently in the process of rolling-out a significant upgrade to the platform used to manage environmental monitoring and enforcement, which will see the function transition into SAP. This will provide improvements for the management of Council’s Compliance Monitoring and Enforcement functions under the RMA, by ensuring it is integrated with the consent process, while also allowing greater insights into trends and observations from compliance monitoring.
Notable applications/incidents:
105. On 27 February, Council made a decision in relation to an application for a housing development by Wolfbrook on Ridge St, Otumoetai. The proposed development drew significant interest from local residents, with concerns being raised in relation to density and character. Following thorough consideration, it was decided that the thresholds for limited or public notification were not met and the application was approved on a non-notified basis. Staff have proactively communicated this outcome with residents and provided full information in relation to the decision making process.
106. An application from Structure Properties Ltd to develop a site on Hinau Road, constructing an eight-storey building with a proposed height of RL 34.0m, providing up to 65 residential apartments, was publicly notified on 9 February, with the opportunity for submissions closing on 8 March. Given the scale of the proposed development, this was expected to generate significant public interest.
107. As noted in previous reports, the EPA has appointed a panel to consider the Sanderson Group’s Pitau Road project, which has been referred via the COVID-19 Recovery (Fast-track Consenting) Act 2020. The panel consists of Mike Doesburg (Chair), Paora Stanley and Gavin Kemble. Relevant local authorities, iwi authorities and treaty settlement entities must be invited to comment on the application, as well as owners and occupiers of land adjacent to the land on which the project is to be undertaken. Comments are due by 20 March.
108. On 9 January 2024, independent hearing commissioners made a decision in relation to an application from Higgins Group Holdings Ltd for a Regional Council resource consent in relation to the air discharge from its Mount Maunganui facility. The commissioners approved the application for a short term, and subject to Higgins installing a higher stack, reflecting a view that the discharge is only acceptable with some additional mitigation and for a shorter timeframe before more significant and fundamental upgrades would be required. The decision included clearly-defined requirements for Higgins to apply for and obtain a resource consent from TCC for the increased stack height within six months of the decision, or to cease operations. The corresponding application was received on Friday 16 February and is currently being processed by staff.
109. A proposal for the 115 unit “Karaka Pines” retirement village in Papamoa was recently notified on a limited basis, with Nga Potiki the only affected party notified. This development, as proposed, will require a pump station to be upgraded and planning and city waters staff are working together to understand relevant timelines for decision-making.
110. Council is currently processing an application from Kainga Ora for earthworks in relation to its future Tauriko West development. The application is being processed by an independent consultant, jointly with the Regional Council consents.
Key Account Management
111. Our Key Account Management function continues to support the delivery of excellent regulatory outcomes (primarily operating across the Environmental Planning and Building Services teams, while working closely with Infrastructure), providing a single point of contact for engagement and communication with applicants and their teams.
112. We have recently introduced a new service called Engineering Concept Consultation. The purpose of this service is for developers to engage with Council asset managers to discuss challenges and opportunities with proposed projects. It enables those developers to inform the design of their projects in a manner that can be consented when they make an application. Both services are cost-recovered and accessed through our website.
113. Key projects/customers include the Civic Precinct redevelopment, The Strand, Memorial Park, 2 Devonport Road, 90 Devonport Road, Haumoana private hospital, Northern Quarter, Ministry of Education, Fosters Construction, Wolfbrook Residential Limited, Ministry of Justice, Group Home Builders, Spaces and Places capital project delivery, Mike Greer Homes, Pukaingaturu B18 Trust, Pitau Street project, Kainga Ora for Ferncliffe Farm, Barrett Homes, Northern Quarter, Classic Developments, Tasman Tourism Limited, Total Fitouts BOP, and Te Whatu Ora. We continue to receive strong interest in this service and continue to grow our portfolio of customers in this area.
City Development & Partnerships
City Partnerships
114. A grant of $7.324 million has been confirmed by the Local Government Flood Resilience Co-Investment Fund for the two landslides in Maungatapu (as a result of Cyclone Gabrielle).
115. We hosted a workshop, which included representatives from Tourism Bay of Plenty, Priority One and the Tauranga Business Chamber, to test support for a new city partners’ programme to replace the previous Project Tauranga programme.
116. We are currently recruiting across a range of channels for a new Tauranga Art Gallery Trust trustee, with applications open until 20 March. More information is available at www.tauranga.govt.nz/cco
117. CCO half yearly reports are due on 29 February and will be presented to the 8 April Council meeting.
118. The City Partnerships Specialist is supporting the Jazz Festival working group with its promotion of Jazz Fest through the ‘It’s on in our City Centre’ campaign. This includes a schedule of musicians to play in Wharf Street over the three weekends prior to Jazz Fest.
119. Our City Safety and Engagement Advisor continues to work closely with various agencies and stakeholders in response to recent antisocial behaviour, particularly around the Edgewater Sails area.
120. City Partnerships Specialists are working with the Tauranga Business Chamber and Downtown Tauranga to roll-out four workshops for city centre businesses, including one focusing on safety and security in April, to be attended by NZ Police. Other workshops planned include “Strategic planning and digital marketing” in March, as well as “Financials and commercial leasing” in May. These have been created following feedback through the Business Navigator Programme and funded through the City Centre Development Incentive Fund, with no cost for attending businesses.
121. Meetings have been held with the University of Waikato to discuss city centre transport plans and how these align with campus development.
122. Speaking engagements and walking tours continue to promote the vision for the city centre. Upcoming events include Tauranga Property Investors Association and University of Waikato student population.
Library and Community Hub
123. Certificate of Acceptance has been issued for the temporary sheet piling completed along the Wharf Street boundary.
124. The inground services and structure “Building Consent 2” was lodged in December and we anticipate it will be approved in April.
125. Building Consent 3, which includes architectural, structure and building services, will be lodged in early-March.
126. Rammed Aggregate Piles (RAPs) are underway and at the current pace, the 900+ piles will be completed in mid-March.
127. The detailed design package has been issued to complete the QS for tender estimate and the contractor to commence pricing. The QS will undertake an assessment of the final tender received as part of the assurance process.

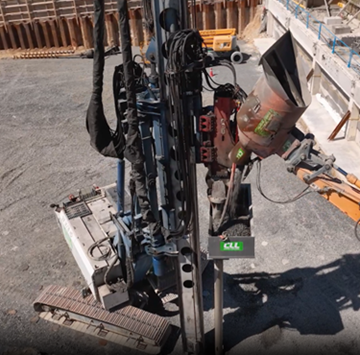

Piling rig in action on the Library and Community Hub site.
Civic Whare / Exhibition Centre / Museum (CWEM)
128. Developed design documentation is currently under review for feedback into detailed design. The 100% detailed design is due on 30 May 2024.
129. Refinement of the façade, as a result of value-engineering work, is now being incorporated into the developed design package.
130. Currently developing early procurement and enabling works packages for the project to mitigate supply chain risks, particularly relating to façade, structure, and ground improvement works.
Tauranga Art Gallery
131. Building Consent documentation is being prepared and peer reviewed. We are expecting to submit the consent by mid-March for the original scope of works plus the seismic upgrade.
132. Critical asset management items are currently with the design team to provide proposals and this scope has been signed-off by the Tauranga Art Gallery Trust.
IT and Security
133. We are in the process of standing up the digital delivery team for 90 Devonport Road and aligning the required delivery activities with the build programme.
134. We have developed a high-level view of opportunities to include technology across the Waterfront and public realm projects. This includes provisions for projecting, programmable lighting, sensory audio, and event services, along with digital signage/display and kiosk opportunities. This work balances enabling future digital development with providing technology upfront, enabling flexibility of delivery over time.
Northern Seawall Renewal, Shared Pathway and Park North Replacement
Seawall
135. Compaction testing has been completed for the Tranche 1 promenade subgrade. Excavation works for the gardens, footpaths and boardwalk areas for Tranche 2 is in progress. Work on the seawall component of Tranche 2 is progressing well with the underwater works completed. Silt curtains for Tranche 3 were installed and excavation of the seabed is almost complete.
Construction of the seawall, footpath, boardwalk and gardens.
Playground
136. The 100% developed design for the waterfront playground has been completed, with cost estimate due on 1 March and the detailed design due 4 March 2024.
137. The Request for Proposals for the specialised feature tower and associated play equipment closed on 7 February with final tender evaluation underway.
Central Plaza
138. Landscaping detailed design was received on 23 February and is currently being reviewed. Detailed design for the amenity block is due 19 April. The project team is finalising the interior specifications with the TCC Facilities and Spaces & Places Teams.
Te Hononga ki Te Awanui (Harbour Link) Stage 1: Boardwalk and Underpass
139. Works on the Boardwalk are progressing well, with the construction of the northern abutment now completed ahead of schedule. The southern abutment top level is currently being filled and is scheduled for completion by 1 March. Piling has commenced from the southern end of the boardwalk with three 24-metre-long piles having been successfully installed with another 28 piles scheduled to be completed by 19 April.
140. Installation of the underpass decking has commenced with the patterned Corten Steel ceiling to be installed sooner than programmed.
141. The project is on track for September completion.
Completed northern abutment. Installed piles. Underpass decking surface.
142. Site works are progressing well, with the balance tank completed and stormwater system being installed. Engagement with nearby food and beverage operators and the Tauranga Art Gallery is continuing to reduce disruption during construction.
Masonic Park.
143. Crossroads is scheduled to commence removal and construction of the new fence in March, with planting to commence when weather conditions become more favourable in late-April/early-May.
144. We are exploring options to drive posts into the ground to avoid any potential disturbance to contaminated soil.
145. A resource consent has been approved to commence removal of contaminated soil from the southern tip. We are awaiting approval of the building consent exemption for the gangway abutment. The revised project completion is the end of May.
146. Piles for the pontoon are scheduled to commence in late-March.
90 Devonport Road (Civic Administration Building fit out)
147. Construction of the base build has passed the halfway stage with the commencement of the internal interconnecting stairs installation.
148. Further consents have been granted this month for the Main Contractor Hard Fitout (MCHF), Subdivisional Hard Fitout (SHF), and the amendment for the interconnecting stairs.
149. An open tender RFP for the building furniture requirements is being finalised and will be advertised on GETS in early-March.
Internal interconnecting stairs. Façade installation from Devonport Road.
483 Cameron Road Indoor Courts
150. The purchase and design works commenced in January, with the purchase becoming unconditional on 31 January and settlement on 1 June.
151. Construction is due to commence in early-June and be completed in late-September.
Elizabeth Street East/Tunks Reserve

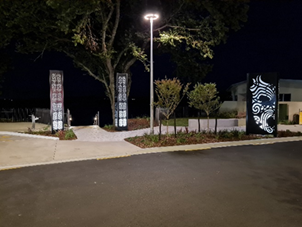

152. Lighting of the site, including the stairs and pou, has been completed to create a well-lit, safe and attractive environment at night.
Tunks Reserve in the evening.
Memorial Park Aquatic Centre
153. The preferred concept option has been refined and is currently being re-priced for the Business Case in March.
160-176 Devonport Road / Second Avenue Temporary Carpark
154. Further asbestos has been found imbedded in the concrete slab, delaying the handover to the civil contractor. The three-month Civil Works Contract to establish the car park will commence following clearance and will include the relocation of the Masonic Park bus shelter and Midnight Sun artwork, providing amenity to Devonport Road and a cycle parking shelter.
City Centre car parking occupancy data
155. Elizabeth Street:
· High demand on Tuesdays and Wednesdays in November, reaching 85% at peak.
· Demand has steadily dropped since, in line with work habits.
· Peak demand in January on Tuesdays barely getting past 50% occupancy.
156. Spring Street Information
· Steady and low demand in the Spring Street parking building over the past 3 months.
· Highest weekend use of any building over January reaching over 30% occupancy.
· Wednesday is the busiest day, as opposed to Tuesday for January.
157. City Centre Information
· Demand remains lower in 2024 and isn‘t expected to pick-up until March. A drop in demand over the summer period is expected.
· There has been no impact on parking demand with the closure of the Waterfront Carpark.
· Busiest day of 2023 was 12/06/23.
· Occupancy in the city centre parking zone hovers between 60% and 70% in peak times (Tue-Wed-Thu).
158. City Centre portfolio governance has been established to take a place-based approach to minimising disruption and maximising efficiencies across the city centre projects and activities. Work includes visualising and reporting on the full portfolio of projects and activities occurring across the city centre, so we can collaborate and communicate with stakeholders on a more agile basis.
159. The City Centre Signage and Wayfinding Masterplan is in development with mapping underway and concept designs in review. This project will allow us to take a more holistic approach to navigation, signage and wayfinding across the city centre and other projects. The project has a focus on pedestrian wayfinding to key destinations, and opportunities for telling stories across our city centre spaces.
160. Placemaking improvements for the city centre are in development, with a consultant selected to scope and deliver a programme of amenity lighting improvements to improve the perception of safety and provide for moments of ‘surprise and delight’ along key walking routes, with a focus on encouraging visitors to utilise carparking buildings.
161. Aspirations to improve the playful nature of the city have progressed with a plan for delivery of ‘play-along-the-way’ on key city centre routes to and from carparking buildings to the new Waterfront playground moving into implementation.
162. Design for the Red Square sanctuary space is in development and includes provision to install the first commission of the city’s new public art trust FONT, which has selected Peata Larkin as their first artist.
Communications and Engagement
163. We continue to share the journey of our city centre transformation with the wider community, using various channels such as media stories, social media, Weekly Bulletin, City News, the Council website, and by utilising partner channels such as Downtown Tauranga and Priority One. We have also been rolling out It’s On! project signs to raise awareness on-the-ground, so people walking past can read more about the development and understand what is coming.
New project
signs up on the waterfront.
Newspaper advertorial in Bay of Plenty Times and Weekend Sun highlighting completed city centre projects and additional developments underway.
164. Positive city centre media coverage so far this year has included:
· NZ’s largest timber office building taking shape in Tauranga CBD: We hosted Sam Kelway, TVNZ reporter, for an inside look at our future office block. The story aired on TVNZ 6pm News on 30 January and was shared online and pushed through the 1News Facebook page.
· Tauranga CBD retailers praise efforts to tackle shoplifting, anti-social behavior: An article featured in Bay of Plenty Times on 4 March highlighting the positive difference Paul Mason, city safety and engagement advisor, has made to improving safety in the city centre.
· Pohutakawa move: The careful relocation of a pohutakawa tree from Tauranga waterfront was shared on Tauranga City Council Facebook page and was picked up by The Breeze on 15 February, with the presenters discussing the safe tree relocation and the exciting transformation of the city centre.
· "We've got some sunny years ahead" – Sam Uffindell: A positive organic story on SunLive, on 28 February with local MP San Uffindell supporting the transformation of the city centre.
· A media release giving an overview of what to expect at Children’s Day was issued on 9 February and coverage appeared on Sunlive.
· A media release about the construction zone opening at Te Manawataki o Te Papa was issued on 27 February and coverage appeared on Sunlive as well as an interview with Gareth Wallis on The Breeze. The ‘Kidstruction Zone’ was also shared on Facebook, garnering significant engagement and positive sentiment.
Nil
18 March 2024 |
Resolution to exclude the public
