|
|
|
|
AGENDA
Ordinary Council meeting Tuesday, 26 August 2025 |
|
|
I hereby give notice that an Ordinary meeting of Council will be held on: |
|
|
Date: |
Tuesday, 26 August 2025 |
|
Time: |
9.30am |
|
Location: |
Tauranga City Council Chambers Level 1 - 90 Devonport Road Tauranga |
|
Please note that this meeting will be livestreamed and the recording will be publicly available on Tauranga City Council's website: www.tauranga.govt.nz. |
|
|
Marty Grenfell Chief Executive |
|
Membership
|
Mayor Mahé Drysdale |
|
|
Deputy Chair |
Deputy Mayor Jen Scoular |
|
Members |
Cr Hautapu Baker Cr Glen Crowther Cr Rick Curach Cr Steve Morris Cr Marten Rozeboom Cr Kevin Schuler Cr Rod Taylor Cr Hēmi Rolleston |
|
Quorum |
Half of the members present, where the number of members (including vacancies) is even; and a majority of the members present, where the number of members (including vacancies) is odd. |
|
Meeting frequency |
Three weekly or as required |
· To ensure the effective and efficient governance of the City.
· To enable leadership of the City including advocacy and facilitation on behalf of the community.
· To review and monitor the performance of the Chief Executive.
Scope
· Oversee the work of all committees and subcommittees.
· Exercise all non-delegable and non-delegated functions and powers of the Council.
· The powers Council is legally prohibited from delegating include:
○ Power to make a rate.
○ Power to make a bylaw.
○ Power to borrow money, or purchase or dispose of assets, other than in accordance with the long-term plan.
○ Power to adopt a long-term plan, annual plan, or annual report
○ Power to appoint a chief executive.
○ Power to adopt policies required to be adopted and consulted on under the Local Government Act 2002 in association with the long-term plan or developed for the purpose of the local governance statement.
○ All final decisions required to be made by resolution of the territorial authority/Council pursuant to relevant legislation (for example: the approval of the City Plan or City Plan changes as per section 34A Resource Management Act 1991).
· Council has chosen not to delegate the following:
○ Power to compulsorily acquire land under the Public Works Act 1981.
· Make those decisions which are required by legislation to be made by resolution of the local authority.
· Authorise all expenditure not delegated to officers, Committees or other subordinate decision‑making bodies of Council.
· Make appointments of members to the council-controlled organisation Boards of Directors/Trustees and representatives of Council to external organisations.
· Undertake statutory duties in regard to Council-controlled organisations, including reviewing statements of intent, with the exception of the Local Government Funding Agency where such roles are delegated to the City Delivery Committee. (Note that monitoring of all Council-controlled organisations’ performance is undertaken by the City Delivery Committee. This also includes Priority One reporting.)
· Consider all matters related to Local Water Done Well.
· Consider any matters referred from any of the Standing or Special Committees, Joint Committees, Chief Executive or General Managers.
· Review and monitor the Chief Executive’s performance.
· Develop Long Term Plans and Annual Plans including hearings, deliberations and adoption.
Procedural matters
· Delegation of Council powers to Council’s committees and other subordinate decision-making bodies.
· Adoption of Standing Orders.
· Receipt of Joint Committee minutes.
· Approval of Special Orders.
· Employment of Chief Executive.
· Other Delegations of Council’s powers, duties and responsibilities.
Regulatory matters
Administration, monitoring and enforcement of all regulatory matters that have not otherwise been delegated or that are referred to Council for determination (by a committee, subordinate decision‑making body, Chief Executive or relevant General Manager).
|
26 August 2025 |
Order of Business
5 Confidential business to be transferred into the open
6 Change to the order of business
7.1 Minutes of the Council meeting held on 5 August 2025
8 Declaration of conflicts of interest
9 Deputations, presentations, petitions
10 Recommendations from other committees
11.1 Local Water Done Well - Water Services Delivery Plan and Commitment Agreement
11.2 Cameron Road Stage 2 Concept Options
11.3 Concept Design for NZ Institute for Marine Futures
13.1 Public Excluded Minutes of the Council meeting held on 5 August 2025
13.2 Digital Programme FY25/26
Confidential Attachment 3 11.3 - Concept Design for NZ Institute for Marine Futures
1 Opening karakia
2 Apologies
5 Confidential business to be transferred into the open
6 Change to the order of business
|
26 August 2025 |
7 Confirmation of minutes
7.1 Minutes of the Council meeting held on 5 August 2025
File Number: A18687068
Author: Clare Sullivan, Team Leader: Governance Services
Authoriser: Christine Jones, General Manager: Strategy, Growth & Governance
|
That the Minutes of the Council meeting held on 5 August 2025 be confirmed as a true and correct record.
|
1. Minutes of the Council meeting held on 5 August 2025
|
5 August 2025 |
|
|
|
MINUTES Ordinary Council meeting Tuesday, 5 August 2025 |
Order of Business
1 Opening karakia
2 Apologies
3 Public forum
3.1 Genevieve Whitson - Downtown Tauranga
4 Acceptance of late items
5 Confidential business to be transferred into the open
6 Change to the order of business
7 Confirmation of minutes
7.1 Minutes of the Council meeting held on 14 July 2025
7.2 Minutes of the Council meeting held on 22 July 2025
8 Declaration of conflicts of interest
9 Deputations, presentations, petitions
Nil
10 Recommendations from other committees
Nil
11 Business
11.1 Status update on actions from prior Council meetings
11.2 Local Water Done Well - Preferred Delivery Model (Update Report)
11.3 Local Water Done Well - Preferred Water Services Delivery Model
11.4 City Centre Street Project - Public Engagement
11.5 Temporary Road Closures - Annual Events 2025 - 2026
11.6 Council-Controlled Organisations - Final Statements of Intent 2025/28
11.7 Corrected Attachment to Report: Local Water Done Well - Preferred Water Service Delivery Model - Affordability, Lowest Income Groups
11.8 City Centre Parking - Parking Permits
12 Discussion of late items
13 Public excluded session
13.1 Public Excluded Minutes of the Council meeting held on 10 June 2025
13.2 Public Excluded Minutes of the Council meeting held on 26 June 2025
13.3 Clarification on Council-Controlled Organisation Board appointment
13.4 Bay of Plenty Housing Equity Fund - Appointment of members to the Board
13.5 Harington Street carpark litigation - settlement recommendations
Confidential Attachment 2 11.1 - Status update on actions from prior Council meetings
14 Closing karakia
MINUTES OF Tauranga City Council
Ordinary Council meeting
HELD AT THE Tauranga City Council Chambers, Level 1 - 90 Devonport Road, Tauranga
ON Tuesday, 5 August 2025 AT 9.30am
|
MEMBERS PRESENT: |
Mayor Mahé Drysdale, Deputy Mayor Jen Scoular, Cr Hautapu Baker, Cr Glen Crowther, Cr Rick Curach, Cr Steve Morris, Cr Marten Rozeboom, Cr Kevin Schuler, Cr Rod Taylor, Cr Hēmi Rolleston |
|
IN ATTENDANCE: |
Marty Grenfell (Chief Executive), Nic Johansson (General Manager: Infrastructure), Christine Jones (General Manager: Strategy, Growth & Governance), Alastair McNeill (General Manager: Corporate Services), Kathryn Sharplin (Manager: Finance), Stephen Burton (Transformation Lead: Water Services), Fiona Nalder (Principal Strategic Advisor), Cathy Davidson (Manager: Directorate Services), Charles Lane (Team Leader: Commercial Legal), Stacey Mareroa-Roberts (Manager: Strategic Māori Engagement), Sam Fellows (Managers; City Partnerships), Emily McLean (Programme Lead: City Development), Clare Dowthwaite (Senior Engagement Advisor), Jenna Quay (Event Facilitation Manager), Andrew Hough (General Counsel), Caroline Lim (CCO Specialist), Shawn Geard (City Centre Infrastructure Lead), Clare Sullivan (Team Leader: Governance Services), Anahera Dinsdale (Governance Advisor) |
|
EXTERNAL: |
Jaron Shaw and Cameron Walker, Department of Internal Affairs |
Timestamps are included beside each of the items and relate to the recording of the meeting held on 5 August 2025 at Council Website.
1 Opening karakia
Cr Baker opened the meeting with a Karakia
2 Apologies
Nil
3 Public forum
Timestamp: :5
|
· Genevieve Whitson from Downtown Tauranga represented the Board and provided feedback on the waterfront Central Plaza project. · She noted on behalf of businesses in the area the lack of communication about the progress of work opposite Masonic Park which was restricting access to the playground. They would like to see this project completed in the next few months. · Downtown Tauranga reiterated their support for the City Centre Streetscape Project.
|
4 Acceptance of late items
|
Resolution CO/25/22/1 Moved: Cr Kevin Schuler Seconded: Deputy Mayor Jen Scoular That the Council: Accepts the following late item/s for consideration at the meeting: • Item 11.7 City Centre Parking – Parking Permits The above item was not included in the original agenda because it was not available at the time the agenda was issued, and discussion could not be delayed until the next scheduled meeting of the Committee because a decision was required in regard to this item. Carried |
5 Confidential business to be transferred into the open
Nil
6 Change to the order of business
Nil
7 Confirmation of minutes
Timestamp: :13
|
Resolution CO/25/22/2 Moved: Cr Rod Taylor Seconded: Mayor Mahé Drysdale That the Minutes of the Council meeting held on 14 July 2025 be confirmed as a true and correct record subject to corrections to speakers names and the date the minutes were authorised. Carried |
|
Motion Moved: Cr Marten Rozeboom Seconded: Cr Kevin Schuler That the Minutes of the Council meeting held on 22 July 2025 be confirmed as a true and correct record.
|
8 Declaration of conflicts of interest
Nil
9 Deputations, presentations, petitions
10 Recommendations from other committees
11 Business
Timestamp: :15
|
Actions That staff provide information from other Councils as to how they track ownership of community assets in relation Bay Venues
|
|
Resolution CO/25/22/3 Moved: Cr Kevin Schuler Seconded: Cr Rick Curach That the Council: (a) Receives the report "Status update on actions from prior Council meetings".
(a) Attachment 2 can be transferred into the open when the report that generated the action is no longer confidential. Carried |
Timestamp: :18
|
11.2 Local Water Done Well - Preferred Delivery Model (Update Report) |
|
Staff Christine Jones, General Manager Strategy, Growth & Governance Kathryn Sharplin, Manager; Finance
External Jaron Shaw and Cameron Walker, Department of Internal Affairs
Action That Councillors be provided with information on when staff and/or the Chief Executive heard from Thames Coromandel District Council that they indicated a willingness to enter into a multi-council CCO.
|
|
Resolution CO/25/22/4 Moved: Mayor Mahé Drysdale Seconded: Cr Hautapu Baker That the Council: (a) Receives the report "Local Water Done Well - Preferred Water Services Delivery Model" Update Report . Carried |
Timestamp: :18
|
11.3 Local Water Done Well - Preferred Water Services Delivery Model |
|
Staff: Christine Jones, General Manager Strategy, Growth & Governance Kathryn Sharplin, Manager; Finance
External Jaron Shaw and Cameron Walker, Department of Internal Affairs
At 10.57 am the meeting adjourned. At 11.10 the meeting reconvened.
At 12.31 pm, Cr Hautapu Baker withdrew from the meeting. At 12.36 pm, Cr Hautapu Baker re-entered the meeting.
At 12.43 pm the meeting adjourned. At 1.18pm the meeting reconvened. |
|
Resolution CO/25/22/5 Moved: Cr Hēmi Rolleston Seconded: Cr Glen Crowther That the Council: (a) Receives the report "Local Water Done Well - Preferred Water Services Delivery Model" Update Report . (b) Acknowledges receipt of the Tangata Whenua Position Paper on Local Waters Done Well, and thanks Tangata Whenua for their consideration of the matter and providing a clear collective view within a constrained timeframe. (c) In recognition of the partnership with Tangata Whenua, undertakes to consider each of the matters in the Tangata Whenua Position Paper and form a view on what is practical, achievable and acceptable to Tauranga City Council (both in terms of process and outcomes). (d) Notes that some matters raised by Tangata Whenua are whole-of-Council strategic relationship matters which need to be addressed regardless of the water service delivery model chosen, and other matters are more appropriately considered through the Due Diligence and other processes associated with a Water Organisation where Tauranga City Council will also need to take into account the views of any partner Council/s. (e) Undertakes to provide a response to Tangata Whenua in respect of the matters raised. Carried |
|
Resolution CO/25/22/6 Moved: Deputy Mayor Jen Scoular Seconded: Cr Hēmi Rolleston That the Council: (f) Based on the information and data currently available, and to ensure full engagement is undertaken with Councils across the region, and with iwi, approves the water services delivery model be delivered via an in-house business unit, with the intention of transitioning into a Water Services Council Controlled Organisation (WSCCO) for water and wastewater services, at the latest by 1 July 2028, with an option for Council to also include stormwater services. (g) In the meantime, notes a Water Service Delivery Plan (WSDP) will be prepared for the duration to deliver through an in-house model. (h) To welcome Western BOP District Council, Thames-Coromandel District Council, Rotorua Lakes Council, Kawerau District Council, Whakatane District Council, Opotiki District Council and Taupo District Council for open and inclusive discussions and participate in data and information sharing to explore the future of Bay of Plenty waters.
For: Deputy Mayor Jen Scoular, Cr Hautapu Baker, Cr Glen Crowther, Cr Rick Curach Cr Steve Morris, and Hēmi Rolleston Against: Mayor Mahé Drysdale, Cr Marten Rozeboom, Cr Kevin Schuler and Cr Rod Taylor, CARRIED |
|
Attachments 1 Tabled Document - Tangata Whenua Position Paper on LWDW 31 July 2025 |
Timestamp: 4:25
|
Staff Emily McLean, Programme Lead: City Development Shawn Geard, City Centre Infrastructure Lead Clare Dowthwaite, Senior Engagement Advisor
|
|
Resolution CO/25/22/7 Moved: Cr Glen Crowther Seconded: Cr Hautapu Baker That the Council: (a) Receives the report "City Centre Street Project - Public Engagement". (b) Approves community engagement on: (i) the City Centre Movement Framework, and (ii) the Draft City Centre Streetscape Implementation Plan. (c) Notes that final versions of both the City Centre Movement Plan and City Centre Streetscape Implementation Plan will be presented to council for approval by the end of 2025. Carried |
Timestamp: 4:45
|
Staff Nic Johannson, General Manager: Infrastructure Jenna Quay, Event Facilitation Manager
|
|
Resolution CO/25/22/8 Moved: Cr Hautapu Baker Seconded: Cr Rod Taylor That the Council: (a) Receives the report "Temporary Road Closures - Annual Events 2025 - 2026". (b) Pursuant to Clause 11(e) of the Tenth Schedule of the Local Government Act 1974, grants approval to close the roads listed in Attachment A of this report to ordinary vehicular traffic on the dates and during the hours stated for the purposes of facilitating safe and successful operations during the identified events in Attachment A. Carried |
Timestamp: 4:48
|
11.6 Council-Controlled Organisations - Final Statements of Intent 2025/28 |
|
Staff Sam Fellows, Manager City Partnerships Caroline Lim, CCO Specialist
At 2.24pm, Deputy Mayor Jen Scoular withdrew from the meeting. At 2.26pm, Deputy Mayor Jen Scoular re-entered the meeting. Deputy Mayor Scoular was not present for the vote on item 11.6 |
|
Resolution CO/25/22/9 Moved: Cr Steve Morris Seconded: Cr Rod Taylor That the Council: (a) Receives the report "Council-Controlled Organisations - Final Statements of Intent 2025/28". (b) Receives the final Statement of Intent 2025/28 for Bay Venues Limited, Tauranga Art Gallery Trust, Tourism Bay of Plenty, Te Manawataki o Te Papa Limited, Te Manawataki o Te Papa Charitable Trust, and Bay of Plenty Local Authority Shared Services Limited, (Attachments 1 to 6). (c) Receives Attachment 7 – Tourism Bay of Plenty’s letter to Mayor Mahé Drysdale regarding its final Statement of Intent. (d) Notes that as joint shareholder of Tourism Bay of Plenty, Western Bay of Plenty District Council received Tourism Bay of Plenty’s final Statement of Intent 2025/28 at their 26 June 2025 Council meeting. Carried |
|
The attachment was tabled.
|
|
Attachments 1 Updated Attachment to Report: Local Water Done Well - Preferred Water Service Delivery Model - Low income affordability- correction |
Timestamp: 4:58
|
Staff Nic Johannson, General Manager: Infrastructure Shawn Geard, City Centre Infrastructure Lead
|
|
Resolution CO/25/22/10 Moved: Cr Rod Taylor Seconded: Cr Kevin Schuler That the Council: (a) Receives the report "City Centre Parking - Parking Permits". (b) Proceeds with a parking permit payment option for the zone “City fringe paid” (Attachment 1 – City Centre Parking Map) (i) Existing residents of properties within the zone are able to apply for a 80% discount voucher, to be issued one voucher per rated property (ii) General fees for this permit are to be set at: (1) One Month: $150 (2) Six Month: $750 (3) 12 Month: $1500 Carried |
12 Discussion of late items
Nil
13 Public excluded session
Resolution to exclude the public
|
Resolution CO/25/22/11 Moved: Cr Glen Crowther Seconded: Cr Marten Rozeboom At 3.11 pm the Council resolved that the public be excluded from the following parts of the proceedings of this meeting. The general subject matter of each matter to be considered while the public is excluded, the reason for passing this resolution in relation to each matter, and the specific grounds under section 48 of the Local Government Official Information and Meetings Act 1987 for the passing of this resolution are as follows:
Carried |
14 Closing karakia
The meeting resumed in open at 4.38 pm
Cr Hautapu Baker closed the meeting with a karakia at 4.39 pm.
The minutes of this meeting were confirmed as a true and correct record at the Ordinary Council meeting held on 26 August 2025.
...........................................................
Mayor Mahé Drysdale
CHAIR
|
26 August 2025 |
9 Deputations, presentations, petitions

1. Petition

Rob Coe - A18684513 ⇩ ![]()

2. petition_signatures_jobs_490489822_20250701222811
- A18691744 ⇩ ![]()
3. petition_comments_jobs_490489822_20250701222829
- A18691747 ⇩
|
26 August 2025 |
11 Business
11.1 Local Water Done Well - Water Services Delivery Plan and Commitment Agreement
File Number: A18690149
Author: Clare Sullivan, Team Leader: Governance Services
Authoriser: Christine Jones, General Manager: Strategy, Partnerships & Growth
Background
1. The report accompanying this agenda item, ‘Local Water Done Well - Water Services Delivery Plan and Commitment Agreement’, will be circulated separately prior to the meeting.
|
26 August 2025 |

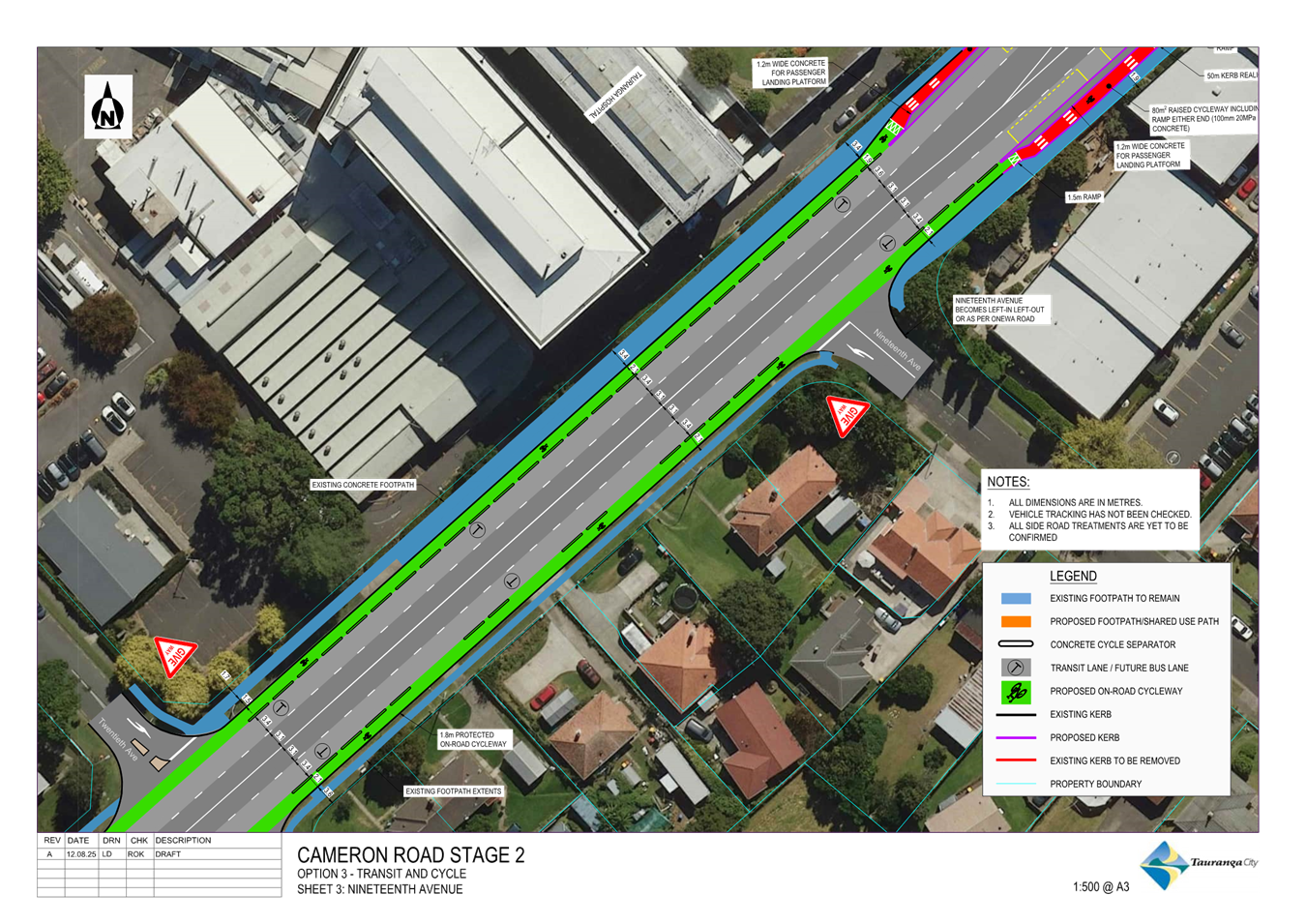

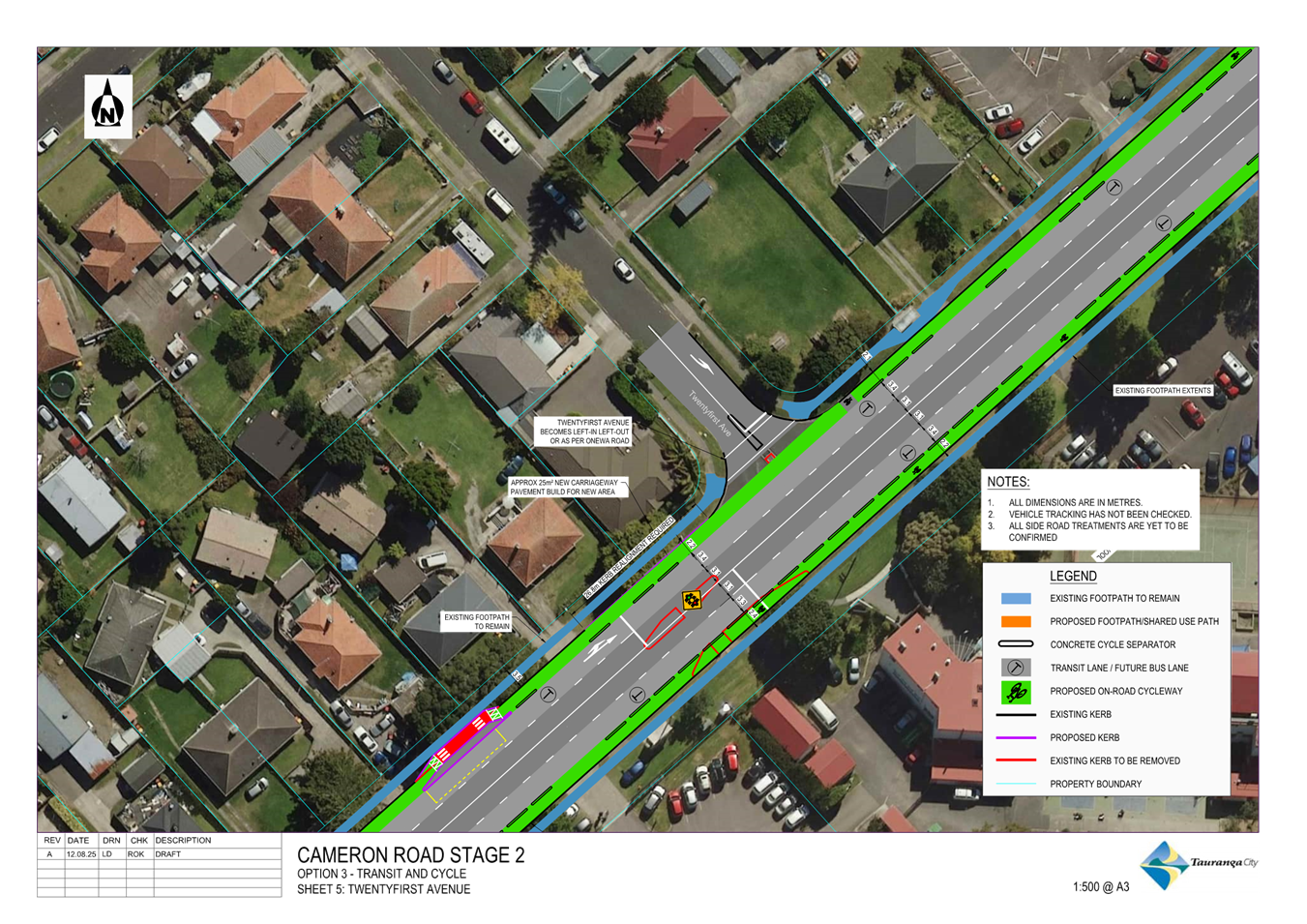

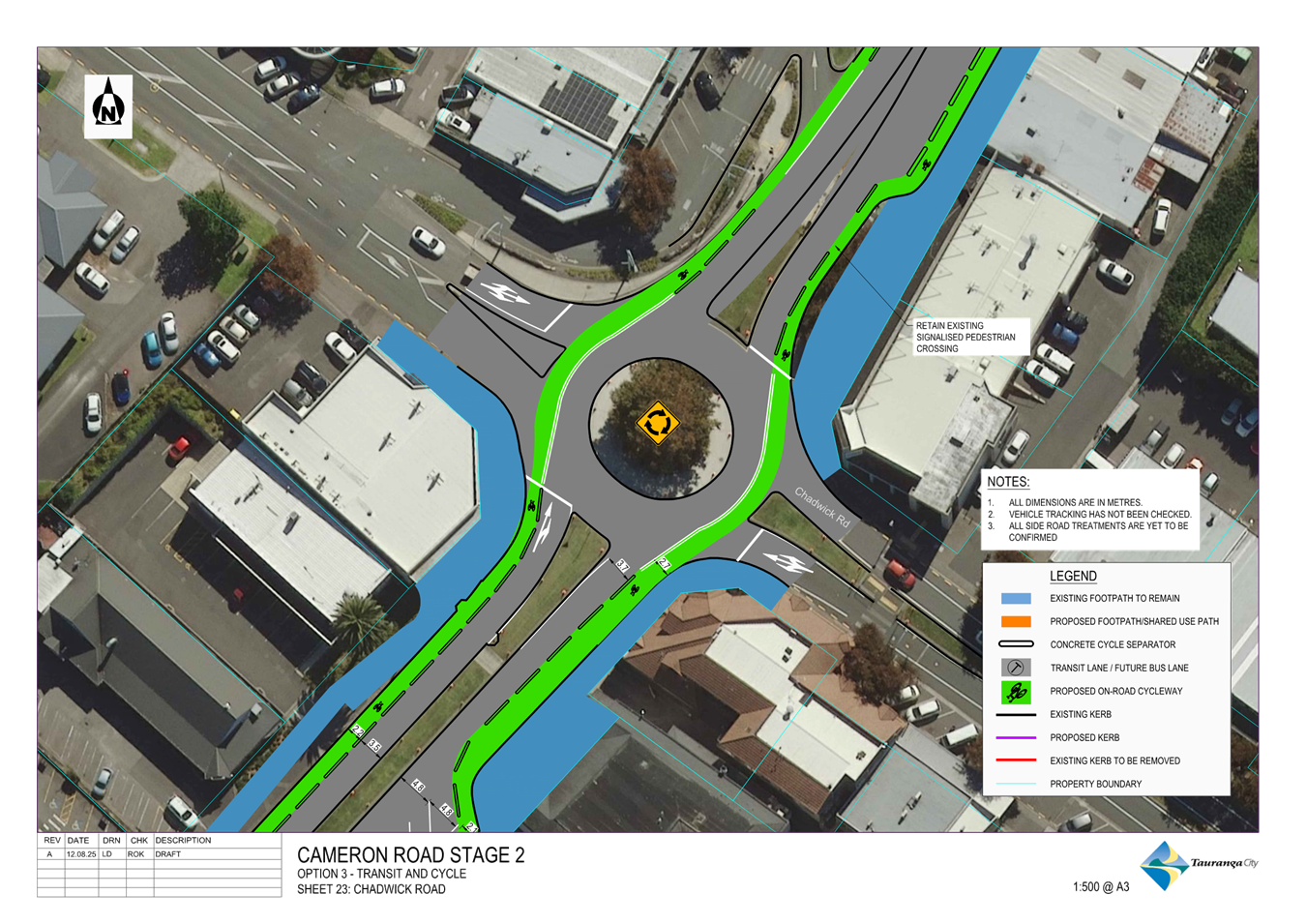

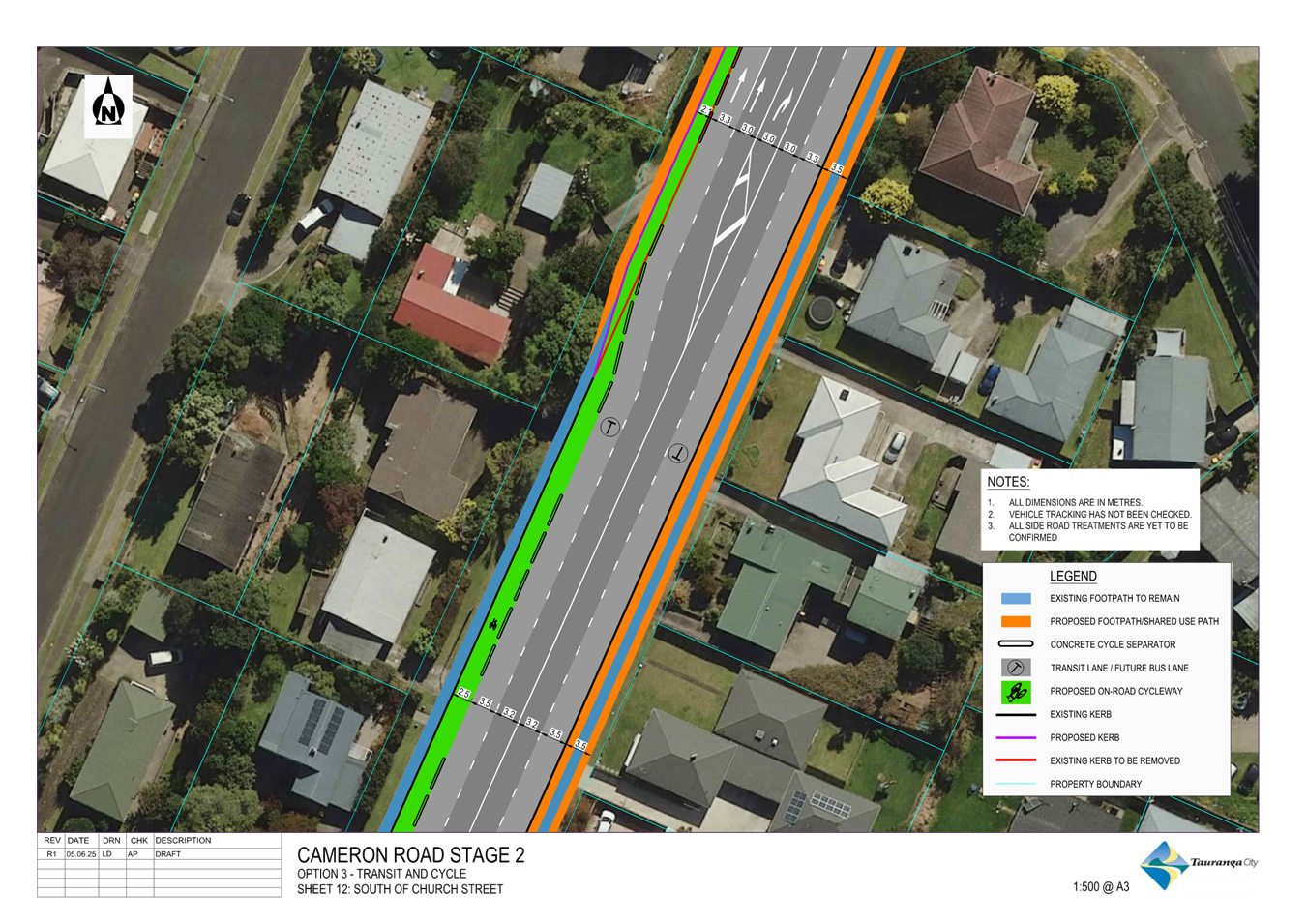

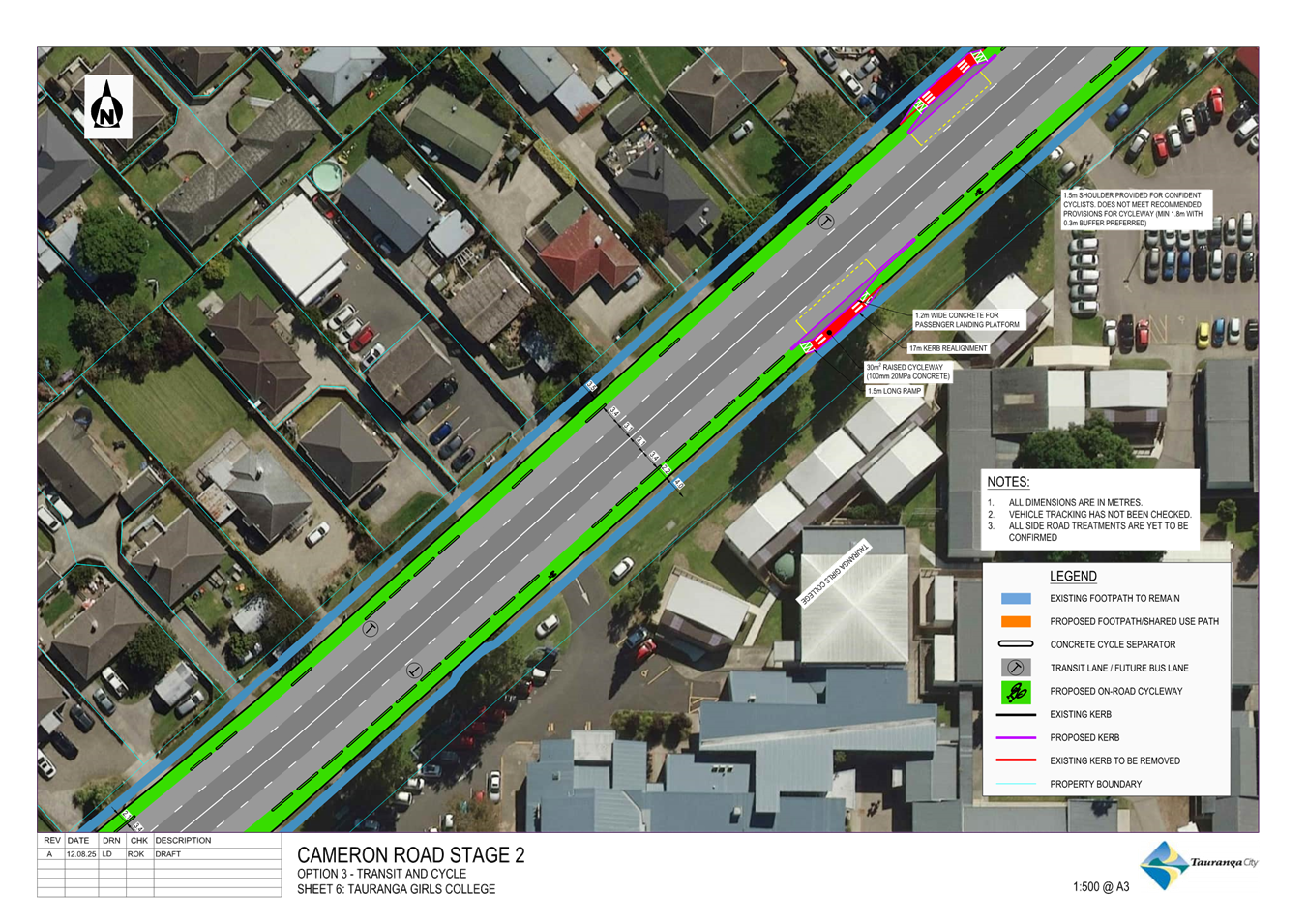

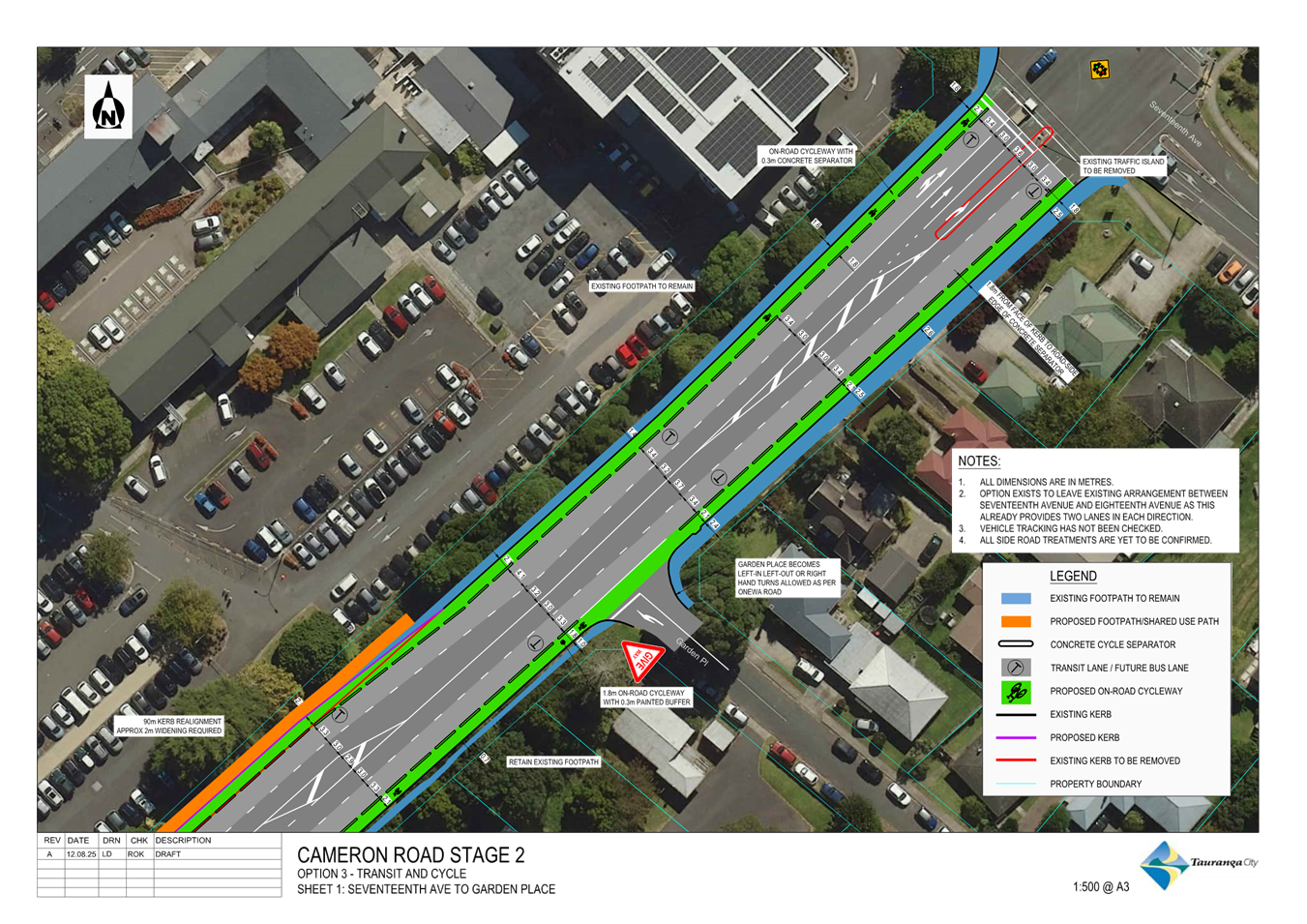

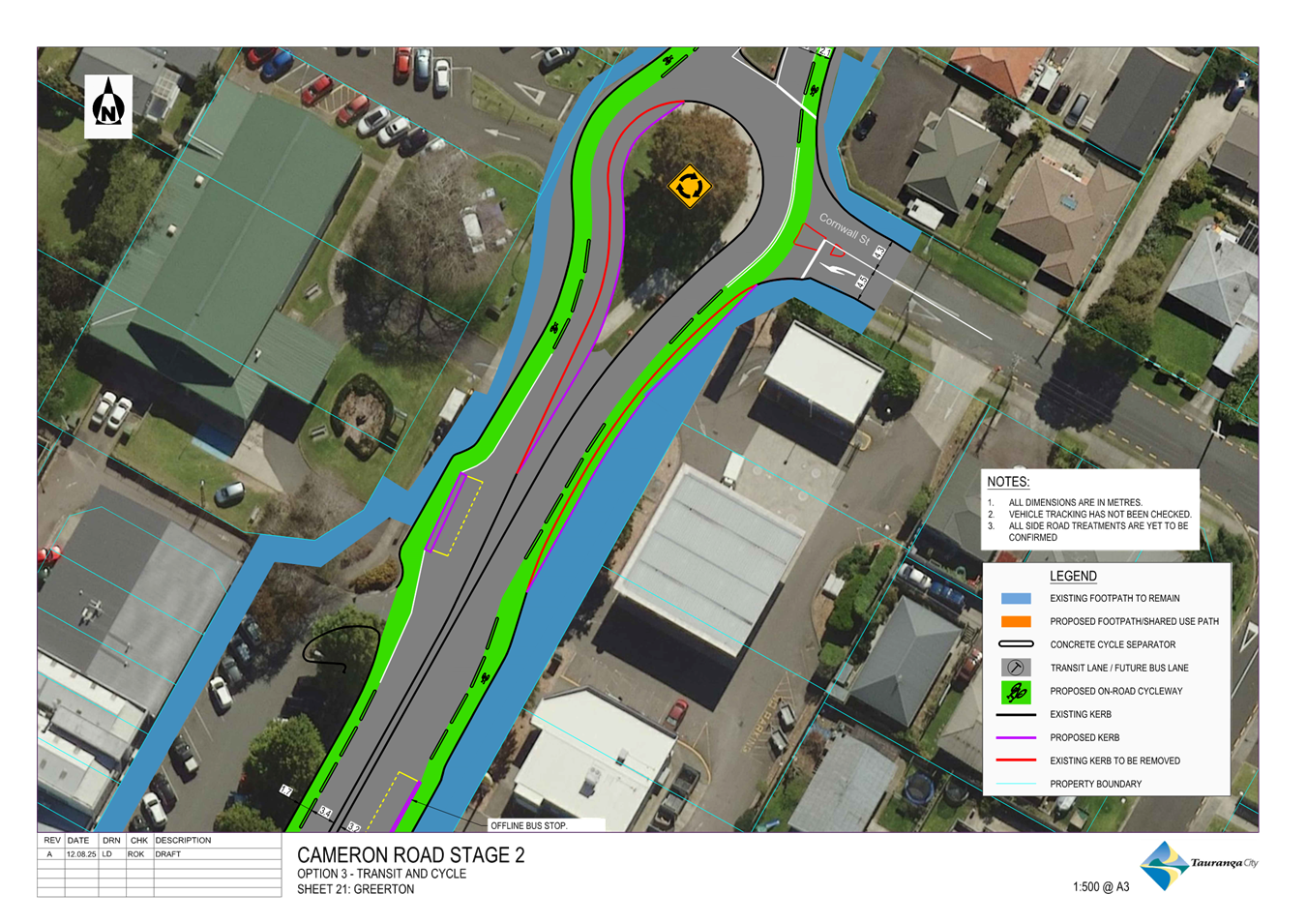

11.2 Cameron Road Stage 2 Concept Options
File Number: A17123440
Author: Richard O Kane, Senior Project Manager
Chris Barton, Programme Director: Major Projects
Authoriser: Nic Johansson, General Manager: Infrastructure
Purpose of the Report
1. To seek confirmation Council is committed to delivering the Cameron Road Stage 2 project by 30 June 2030 in alignment with the timeframes in the current Infrastructure Acceleration Fund (IAF) funding agreement and seek endorsement to progress to community engagement on concept options.
|
That the Council: (a) Receives the report "Cameron Road Stage 2 Concept Options"; (b) Confirms intent and commitment to deliver of the Cameron Road Stage 2 upgrade project from 17th Avenue to Maleme Street by 30 June 2030 to support housing intensification in the Te Papa peninsula area at or above the level described in the existing Te Papa IAF funding agreement timeframes; and (c) Endorse to progress to community engagement to seek feedback on the concept design for the Cameron Road Stage 2 corridor and options through Greerton village, subject to re-confirmation of current IAF funding availability resulting in a funding stack of $185.5m comprised of: · Transport Components - $98.8m § $56.4m Crown grant via the Infrastructure Acceleration Fund (IAF) § $20m via Transport System Plan Infrastructure Funding and Financing Levy (IFF) § $22.4m of Developer Contributions (DC’s) · Waters Components - $86.7m as budgeted in the 2024-34 Long Term Plan (LTP)
|
Executive Summary

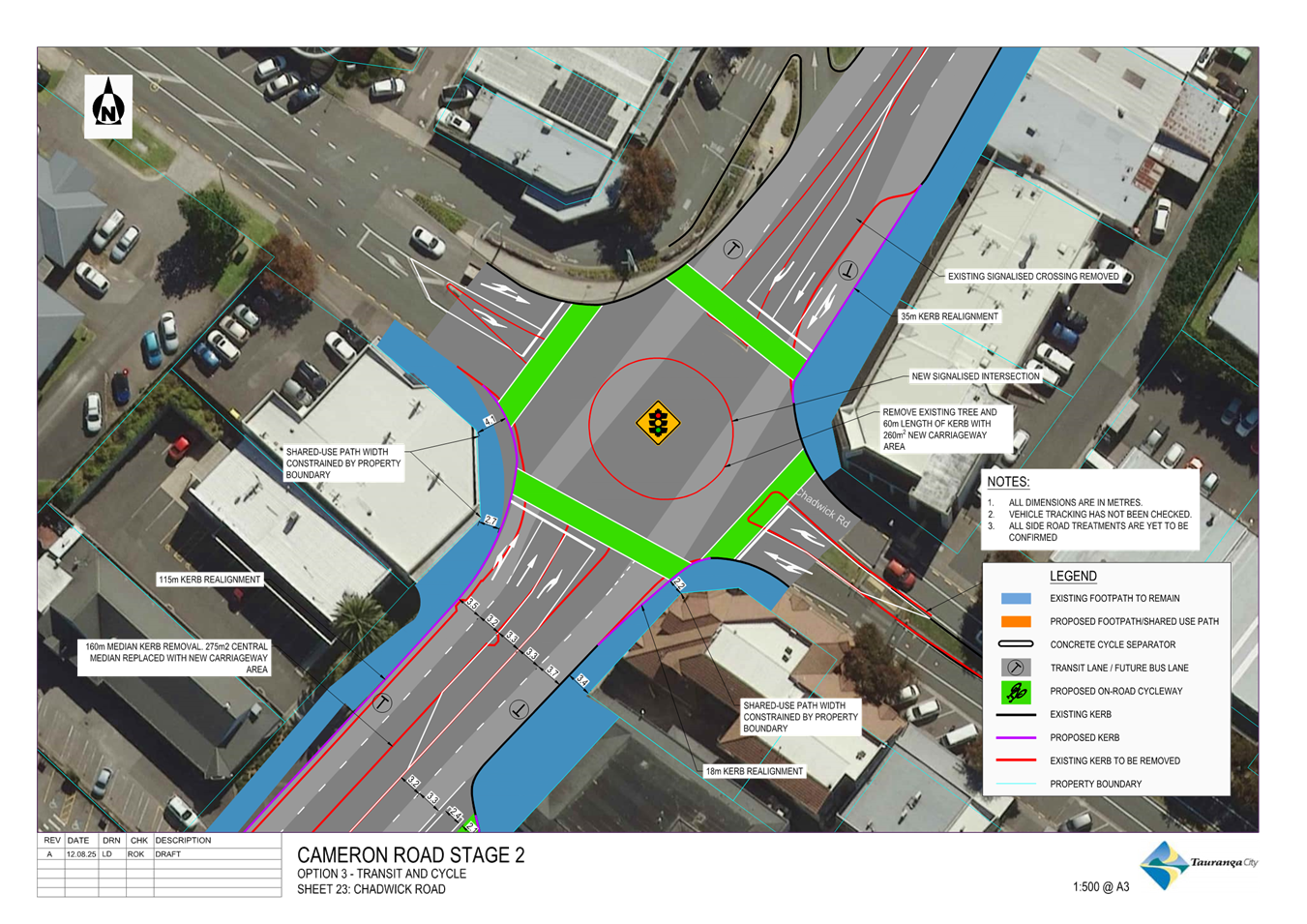

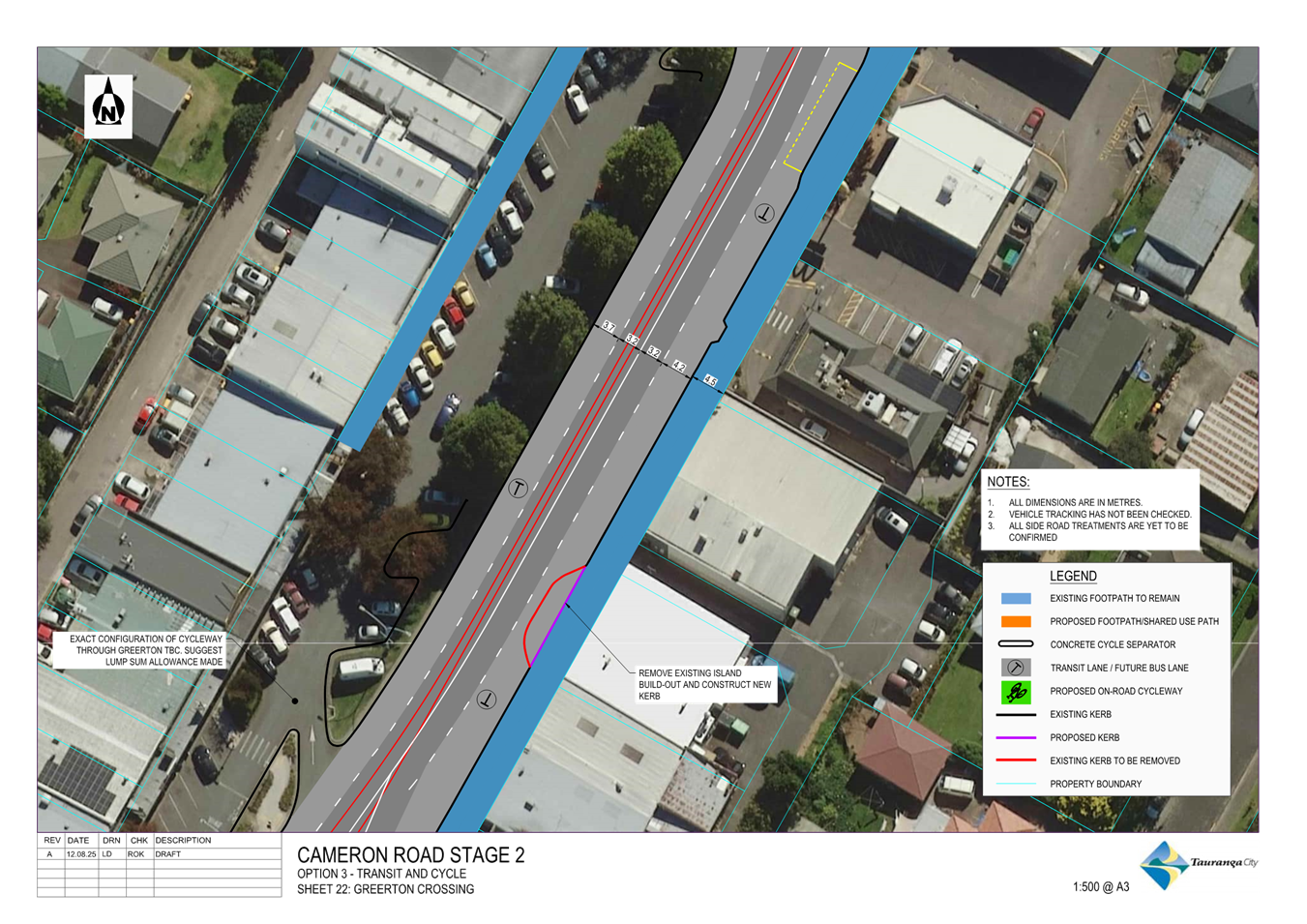

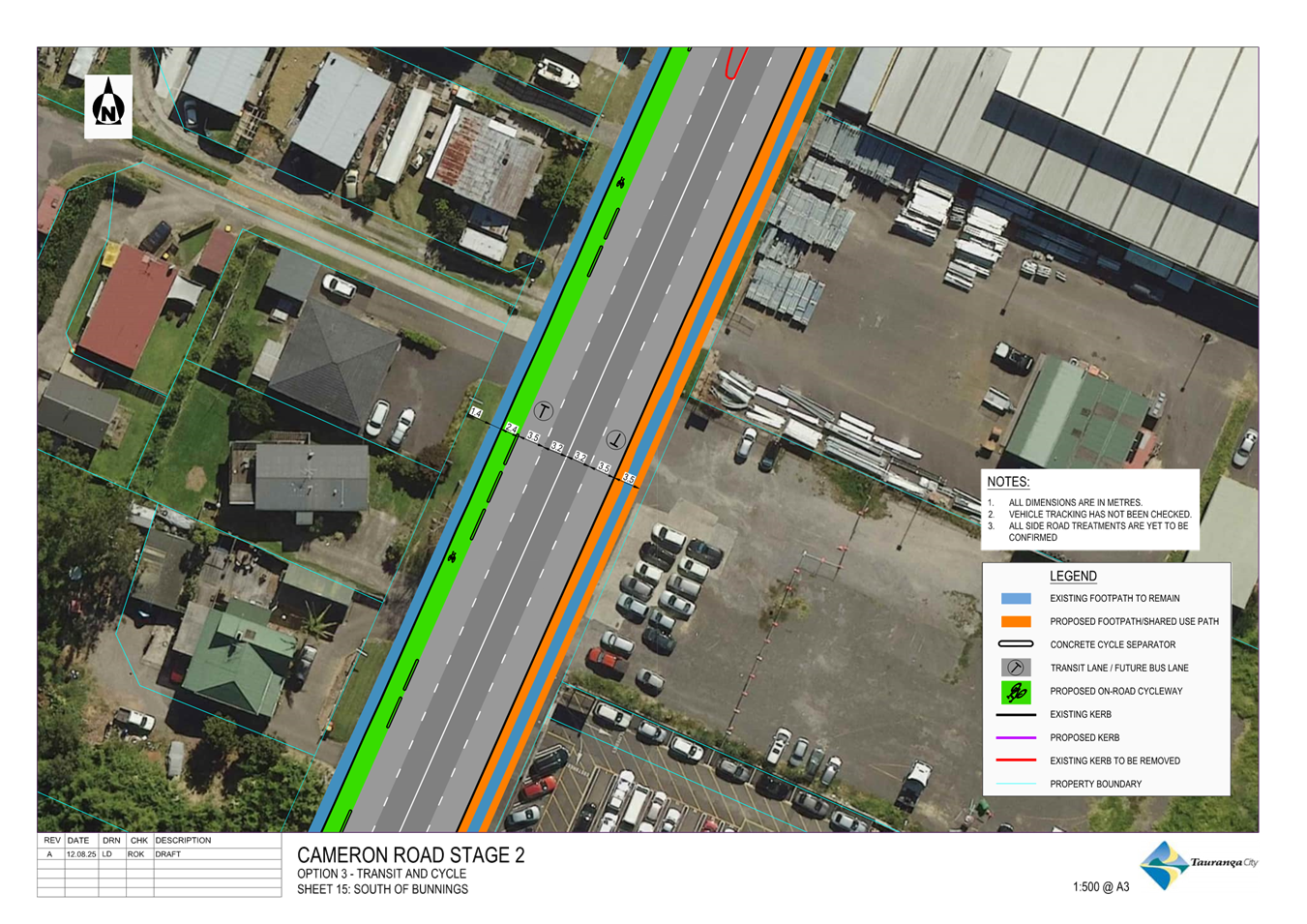

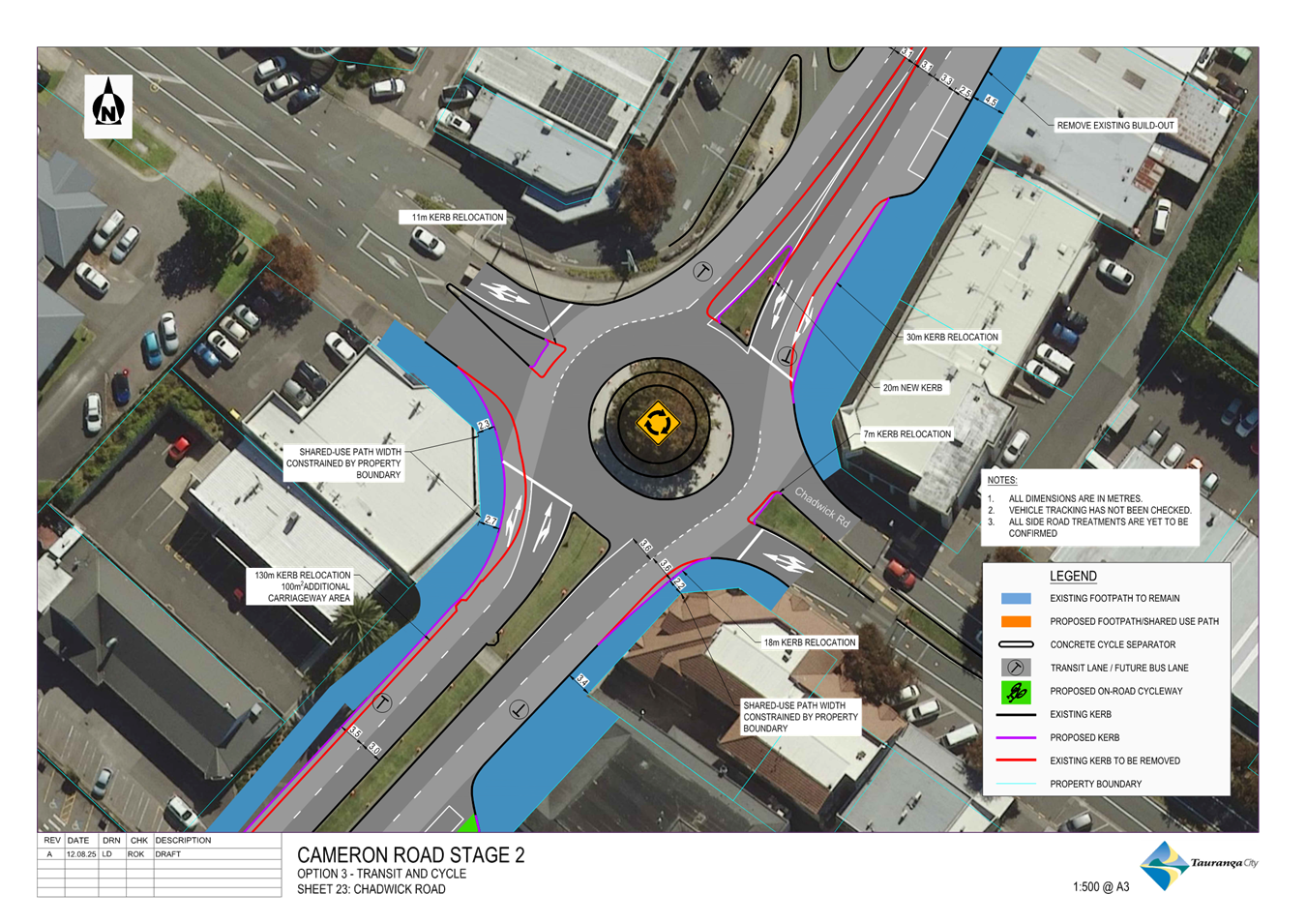

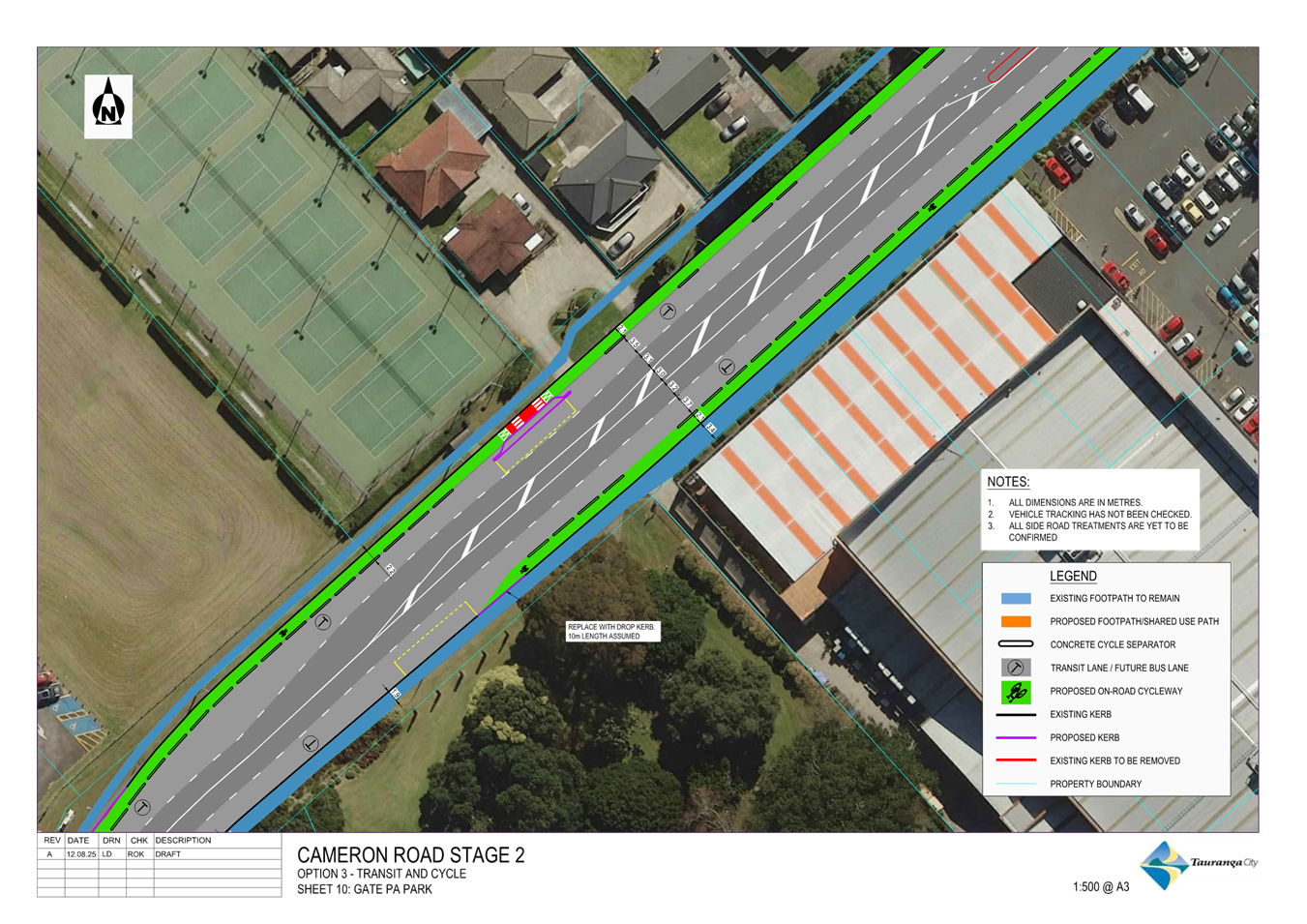

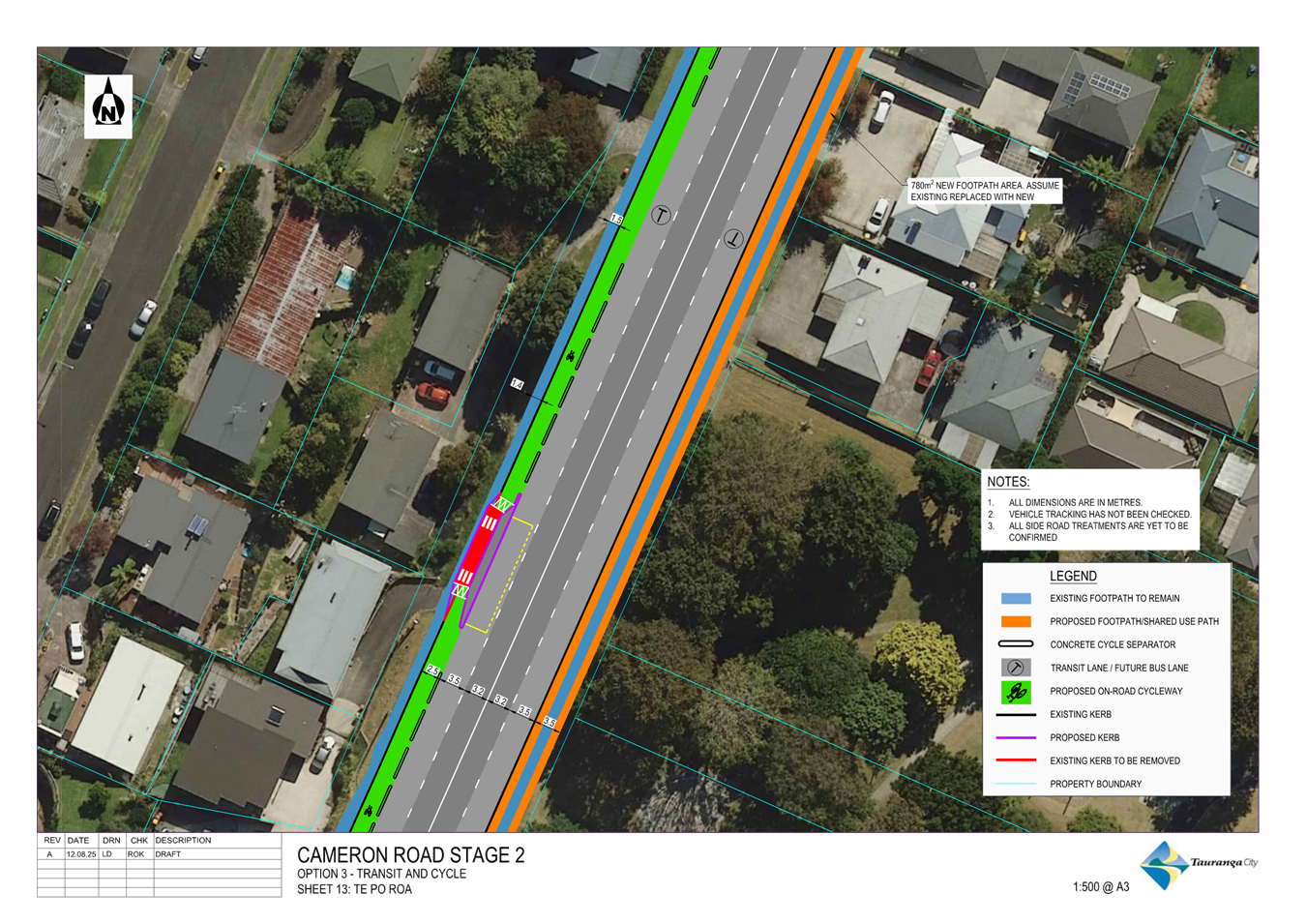

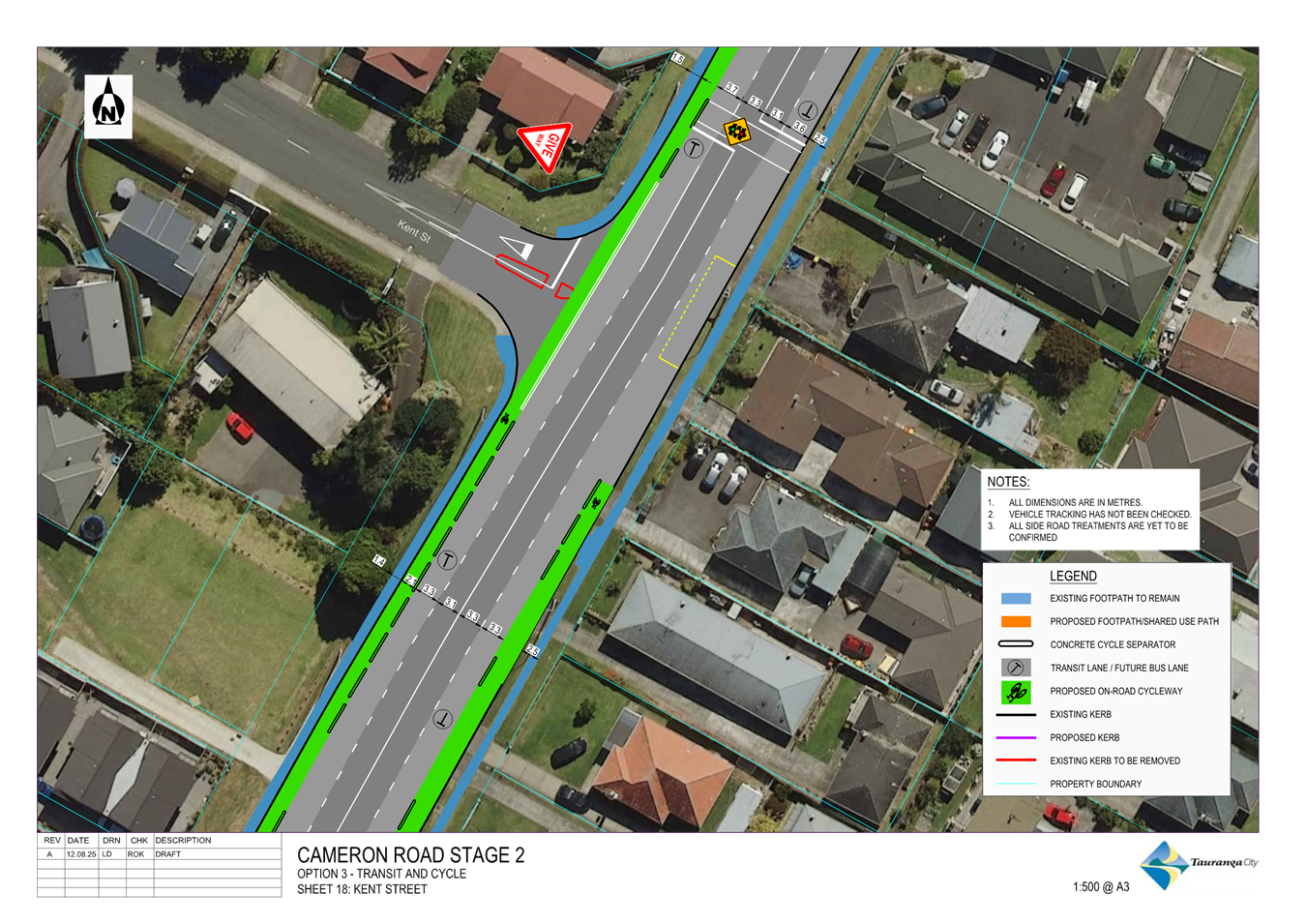

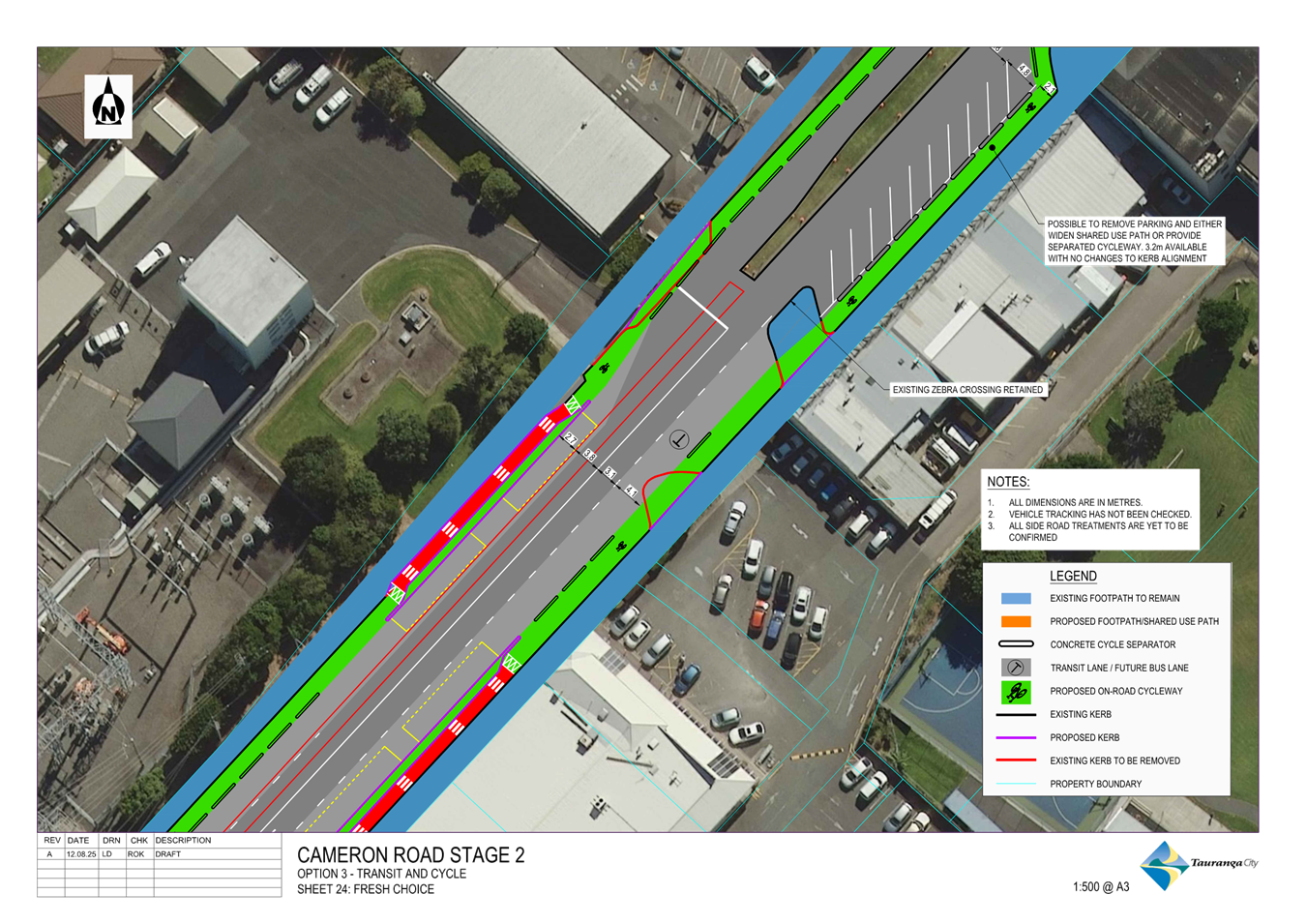

2. The Cameron Road Stage 2 (CRS2) project is planned to upgrade the arterial corridor between Seventeenth Avenue and Maleme Street to enable planned housing intensification along the Te Papa peninsula and support continued growth of the Western Corridor. It is a key strategic link between the completed CRS1 project and the proposed SH29/SH29A RoNS project, with a key function of supporting the people movement function of Cameron Road.

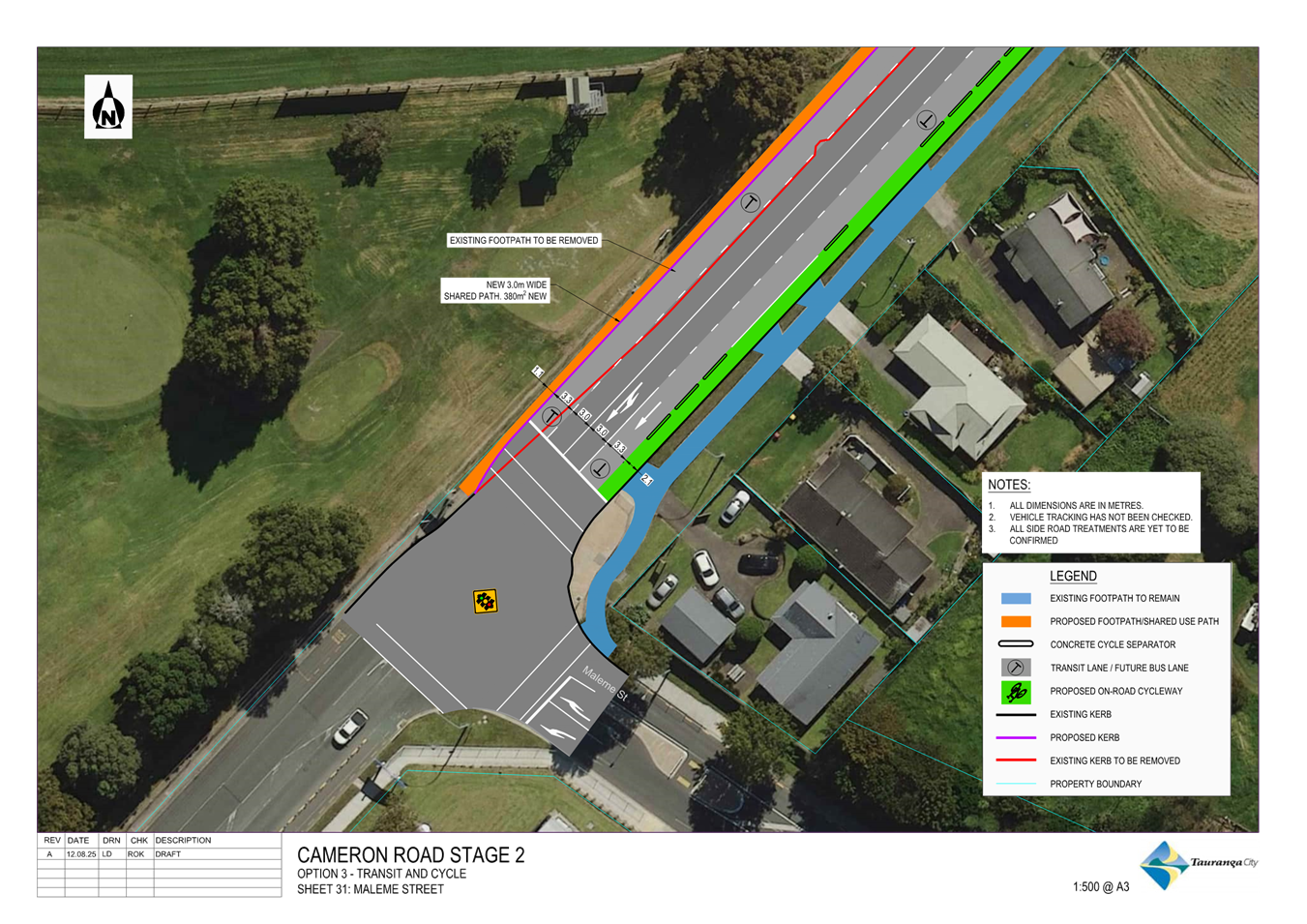

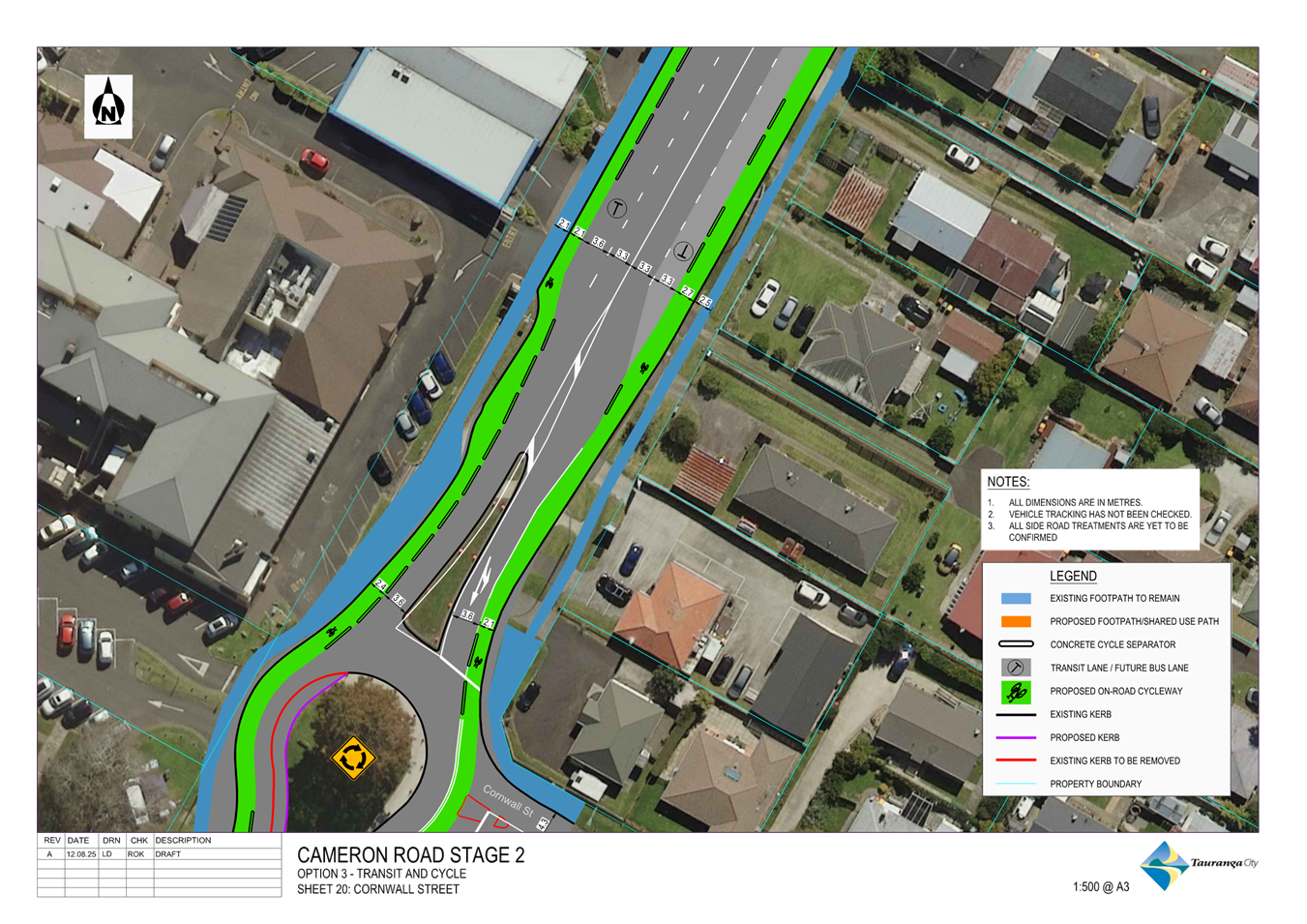

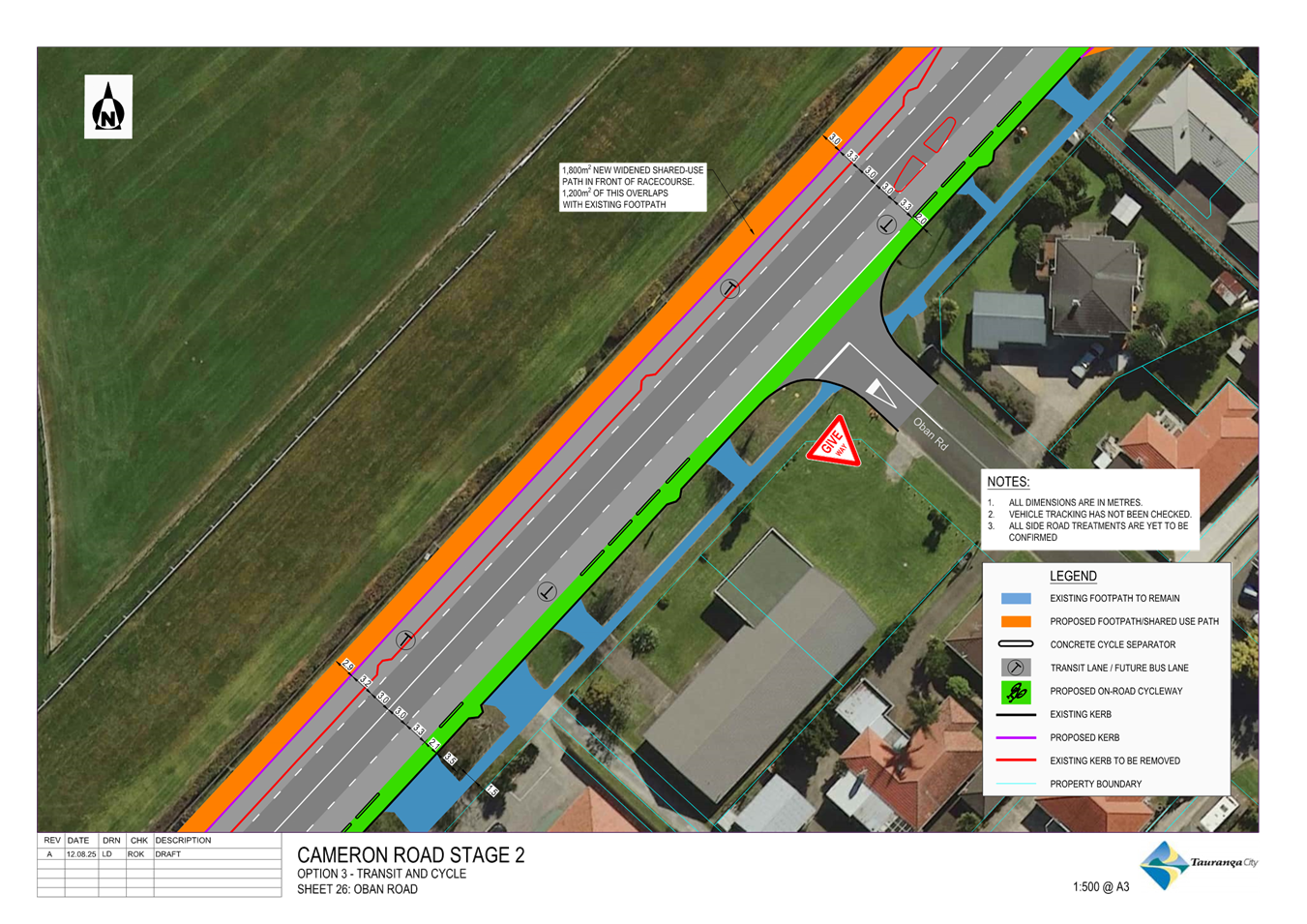

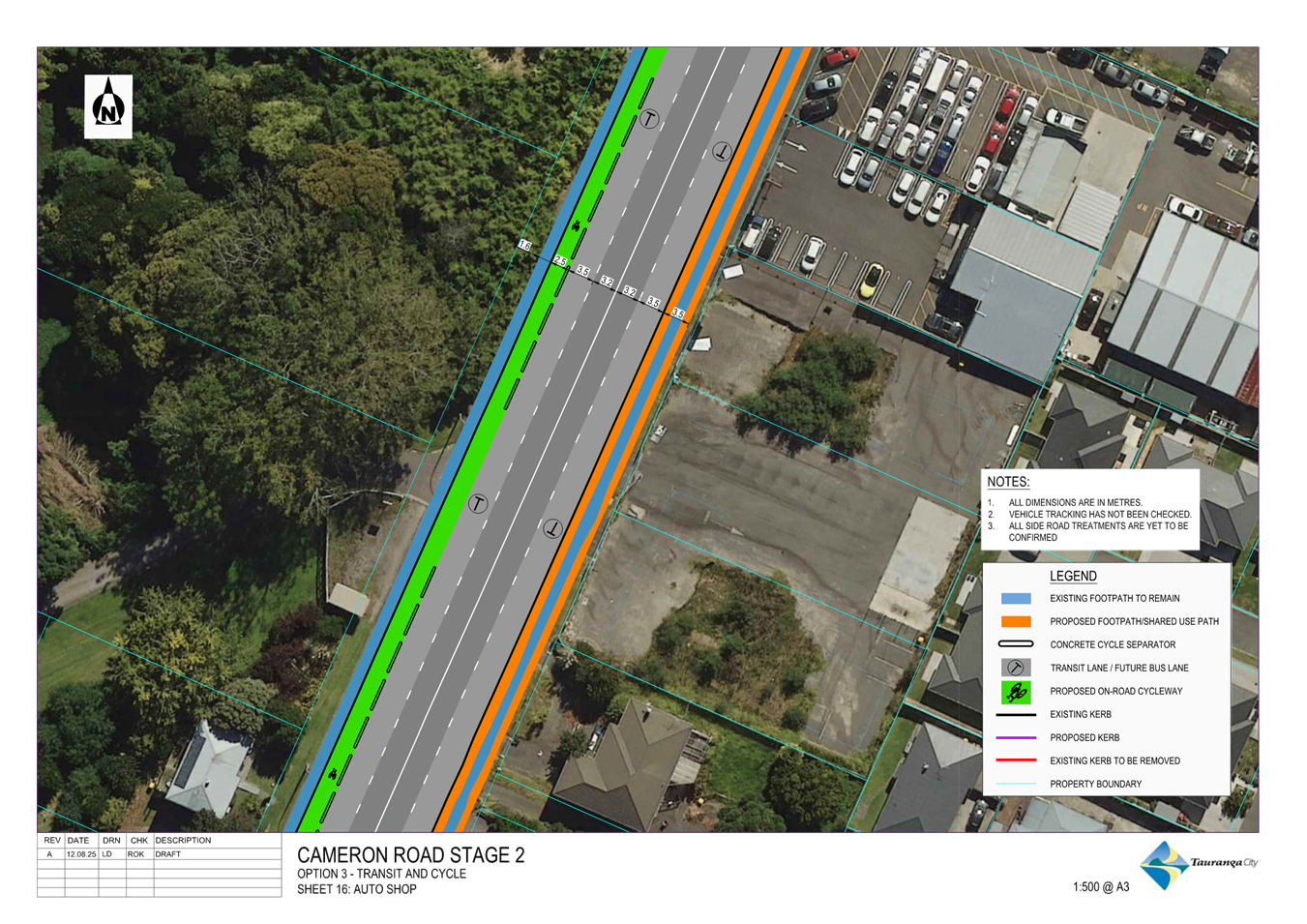

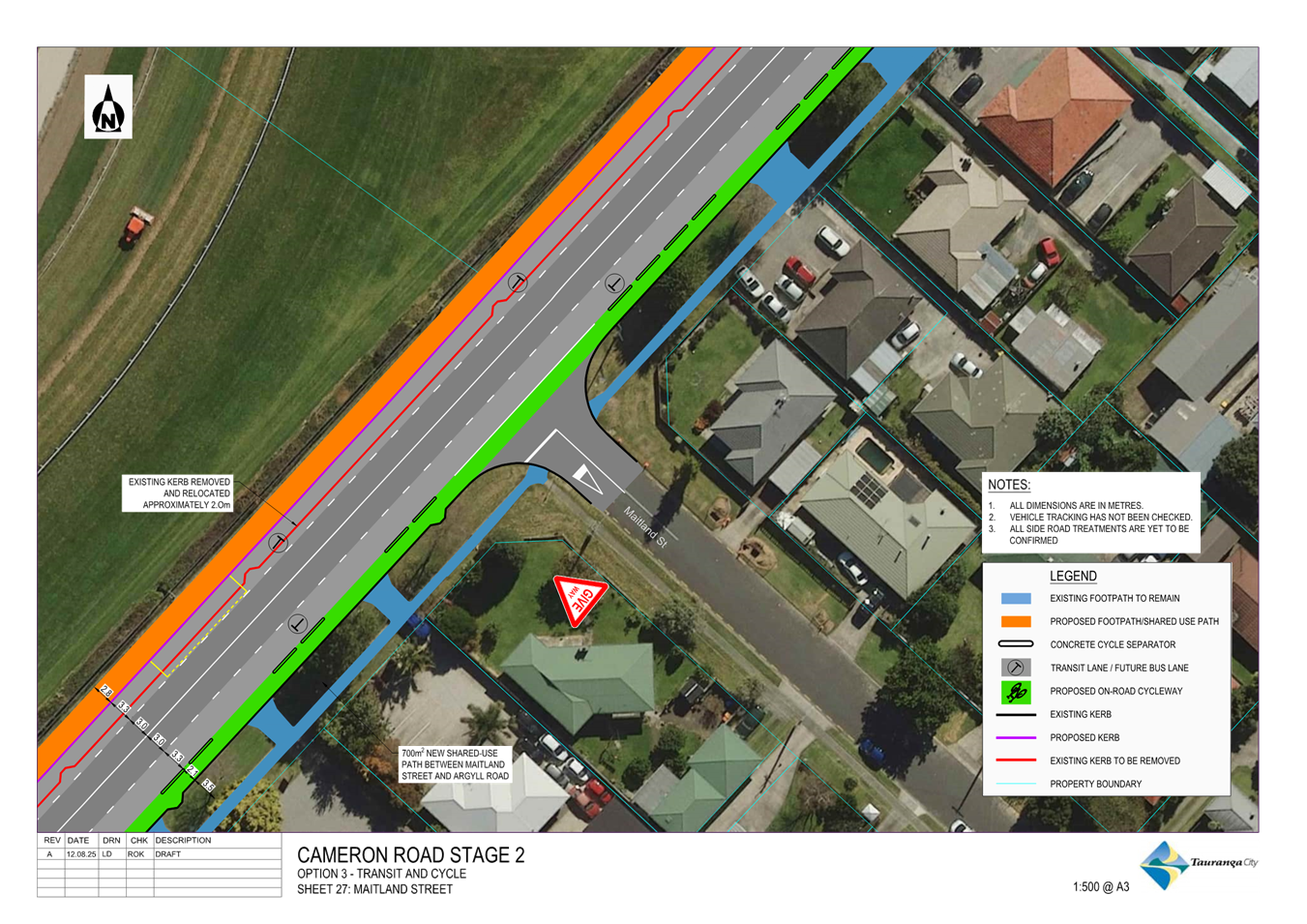

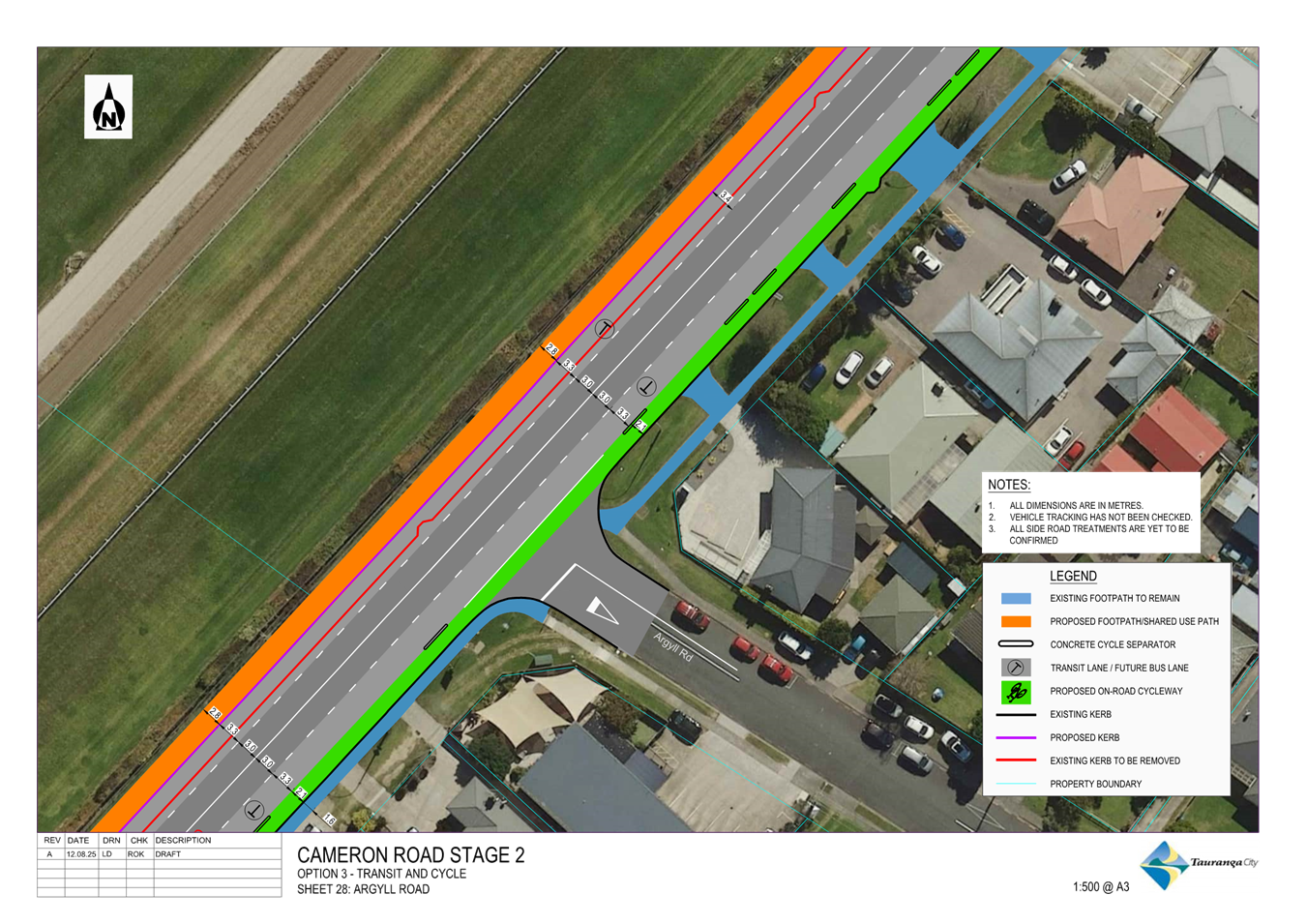

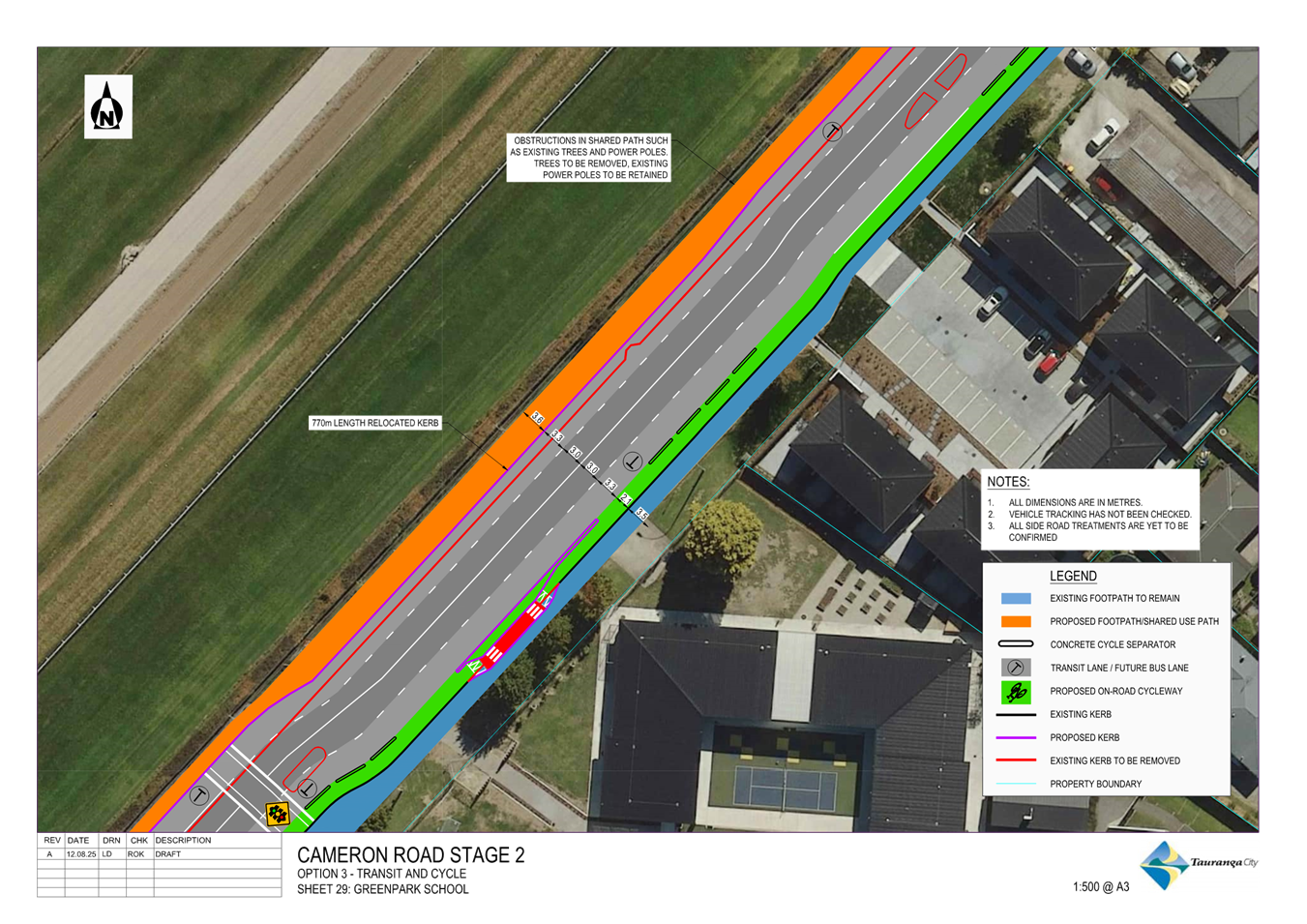

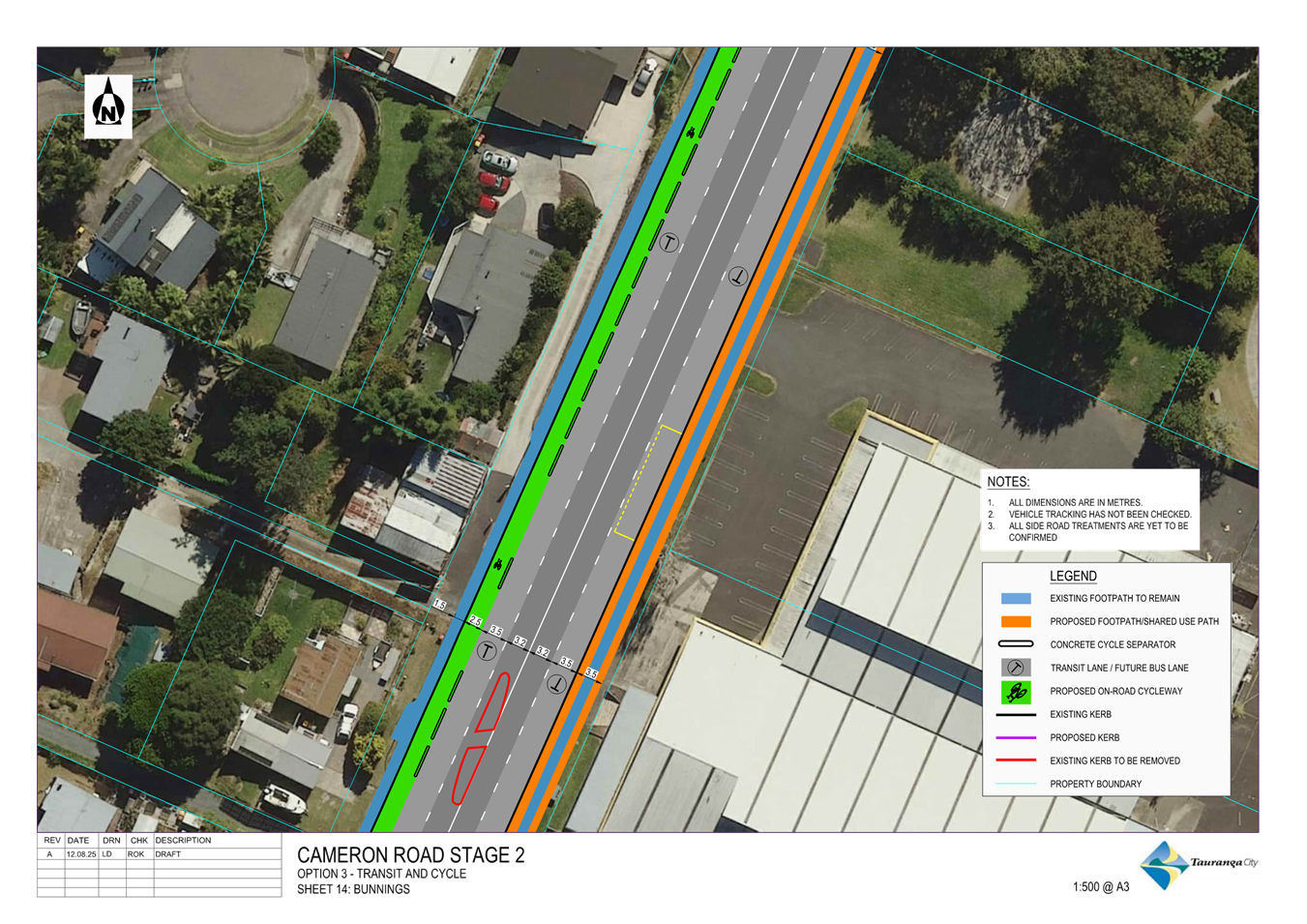

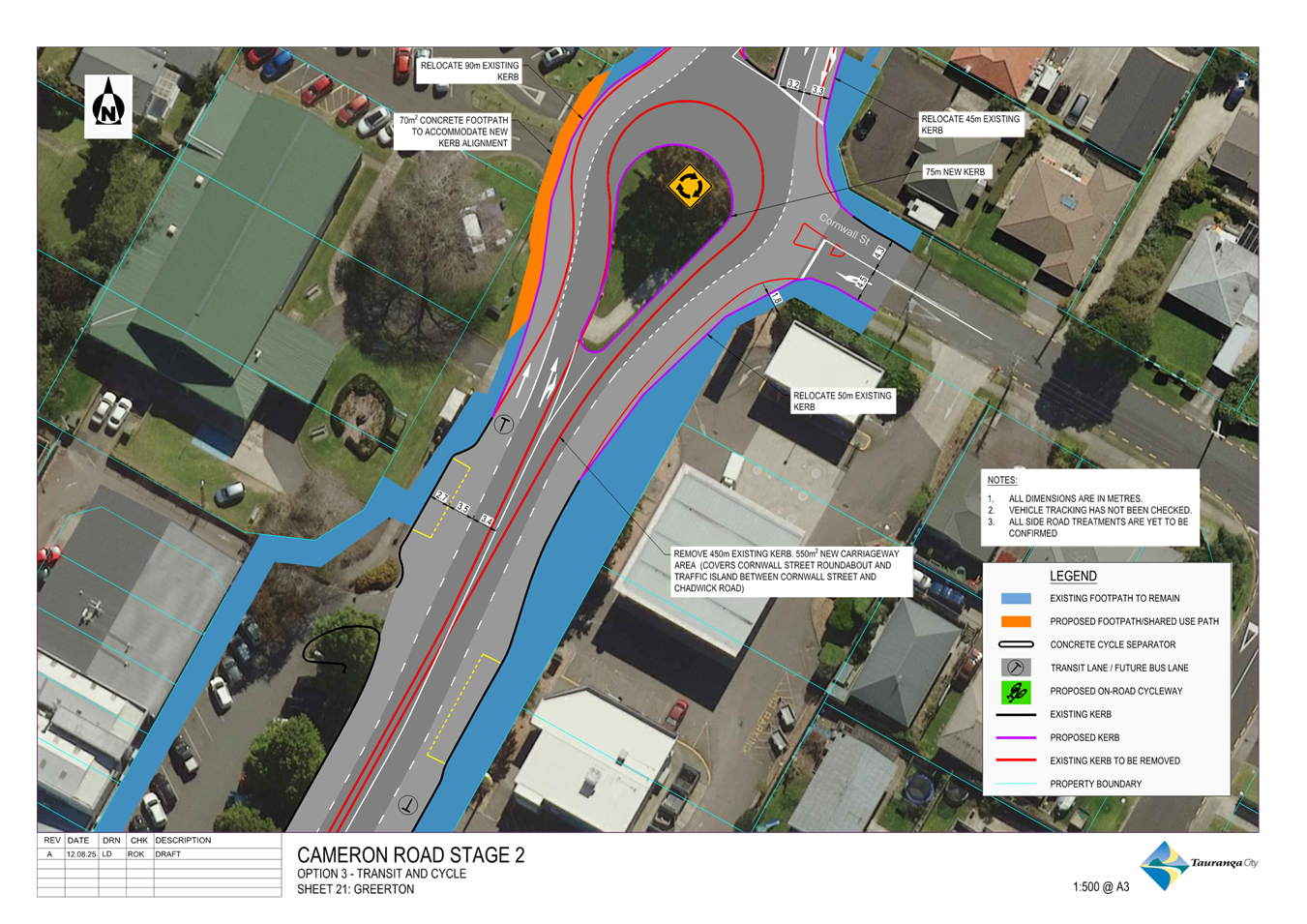

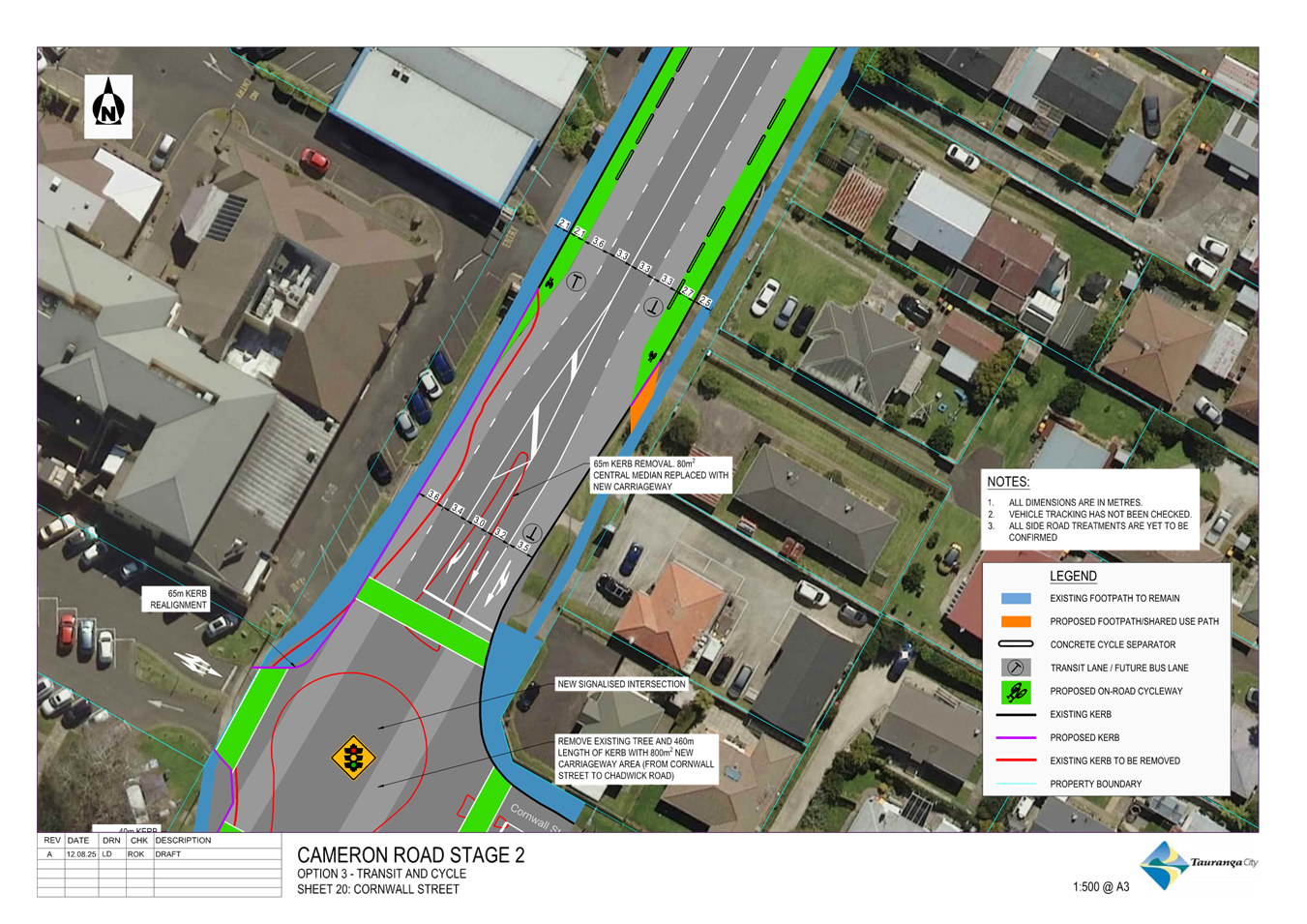

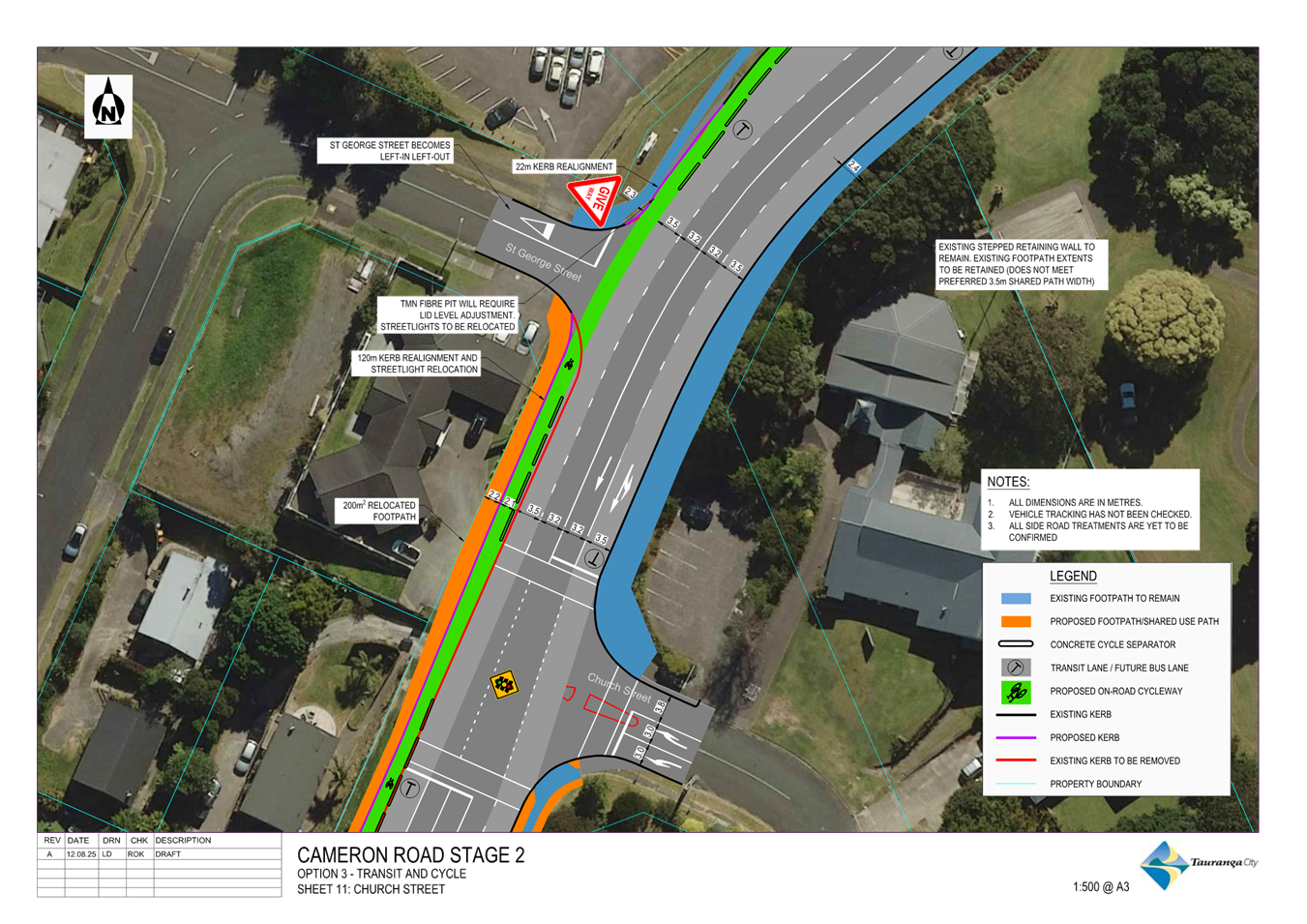

3. As previously reported to the City Futures Committee on 17 February 2025, the project was budgeted in Tauranga City Council’s 2024–34 Long Term Plan (LTP) assuming co-funding support from NZ Transport Agency Waka Kotahi (NZTA), however NZTA co-funding for this project has not been prioritised in the 2024–27 National Land Transport Programme (NLTP).
4. The City Futures Committee resolved for staff to further investigate options to progress and deliver the Cameron Road Stage 2 project and its intended benefits within a reduced funding envelope excluding NZTA co-funding.
5. Concept options have been identified and workshopped with the City Futures Committee on 12 June and 31 July 2025 which functionally deliver the intended transport benefits for all modes within a reduced funding envelope through a number of value engineering considerations, including maximising delivery within existing road pavement areas (current kerb to kerb) where possible and revisiting the requirement for full depth pavement rehabilitation along the majority of the corridor.
6. The emerging preferred concept option for the corridor (excl. Greerton village) provides for a four lane roading corridor along the full length plus a full length cycle route – primarily with separated on-road cycle facilities and with shared paths in some areas where space is constrained. It is assumed that initially outside lanes would operate as peak period transit lanes with provision for ‘off peak’ parking where required, however the corridor would be future-proofed for operation with full-time transit or bus lanes.

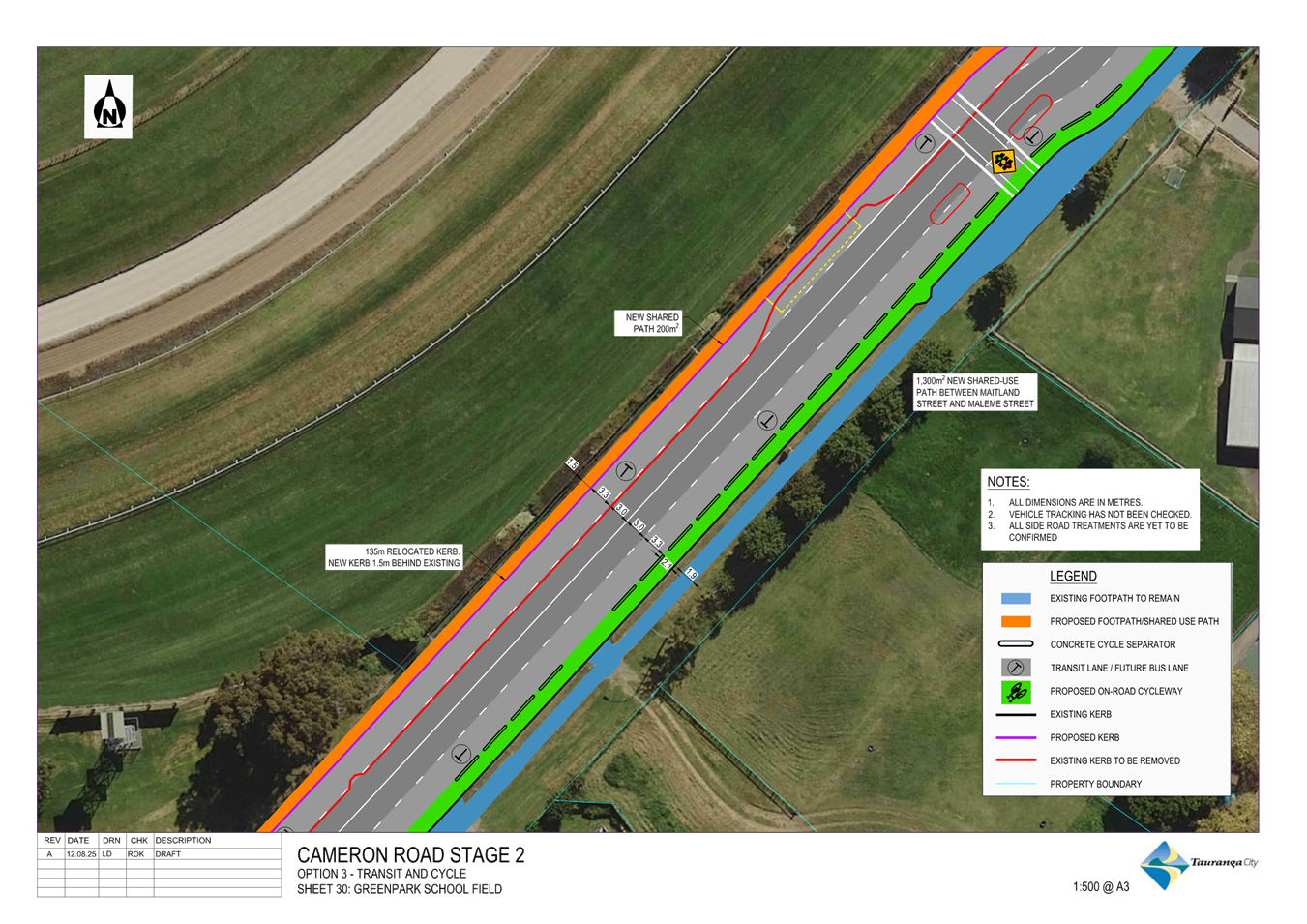

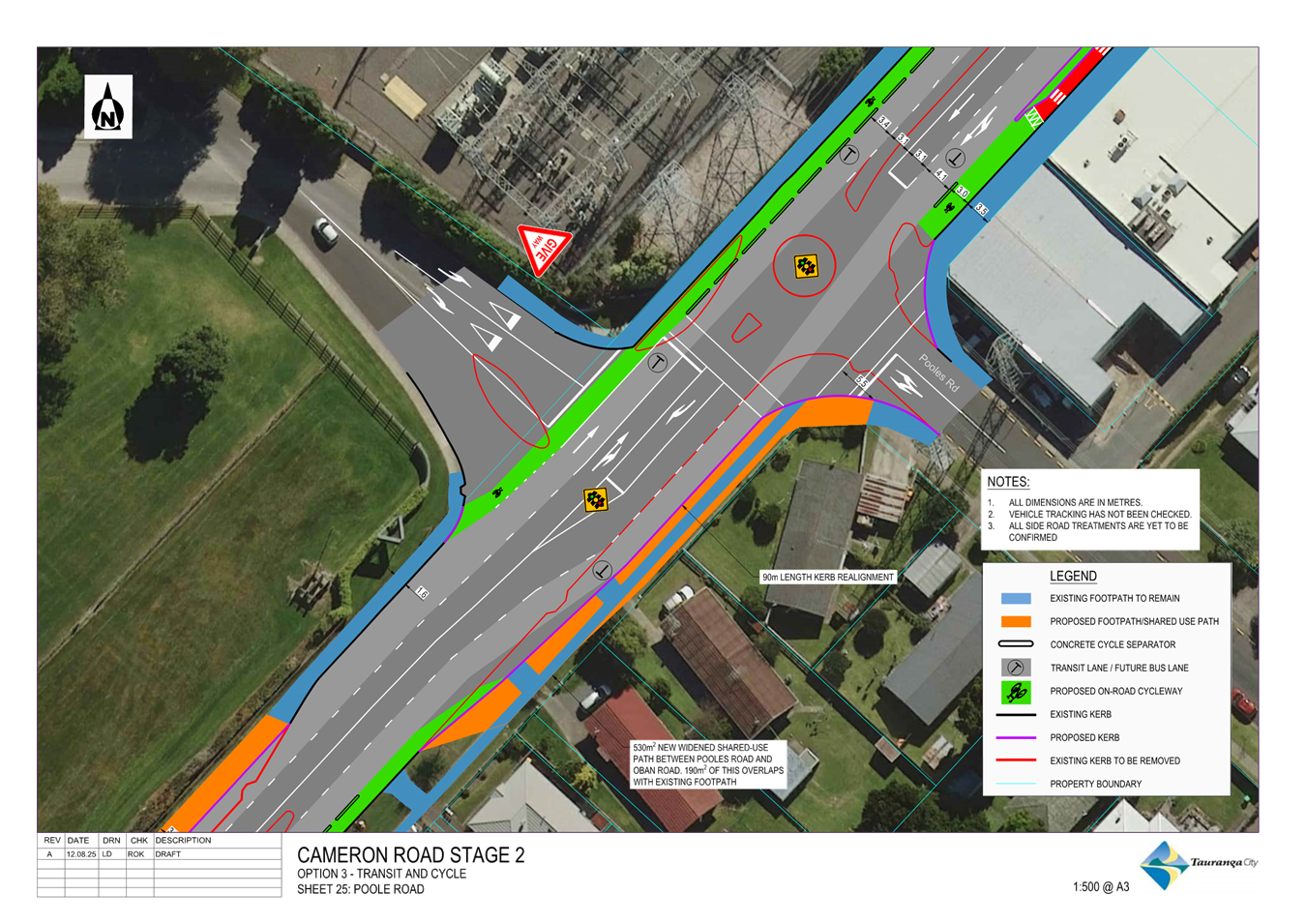

7. Through Greerton village there remain options for either 2-lanes or 4-lanes of traffic and traffic signals or roundabouts at the Chadwick Road and Cornwall Street intersections. Initial assessments indicate all options are viable in delivering intended benefits without significantly compromising the strategic operation of the corridor, however the options have different features and associated benefits or compromises. To inform a preferred option in this area community and stakeholder engagement is proposed.

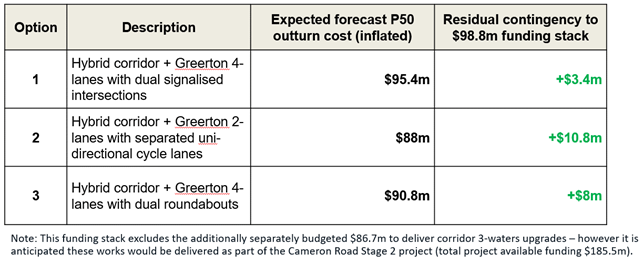

8. The revised funding stack for the total Cameron Road Stage 2 project (excl. NZTA co-funding) is $185.5m. Current cost estimates for the revised concepts are within this funding stack budget. The funding stack is comprised of:
· Transport Components - $98.8m
§ $56.4m Crown grant via the Infrastructure Acceleration Fund (IAF)
§ $20m via Transport System Plan Infrastructure Funding and Financing Levy (IFF)
§ $22.4m of Developer Contributions (DC’s)
· Waters Components - $86.7m
§ Fully funded in the 2024-34 LTP
9. From 1 July 2025 administrative responsibility for the IAF was shifted from Kainga Ora to National Infrastructure Funding and Financing Limited (NIFF). The Minister for Infrastructure has tasked NIFF with reviewing the IAF fund progress, highlighting any material issues and making any recommendations on developments as result of the review.

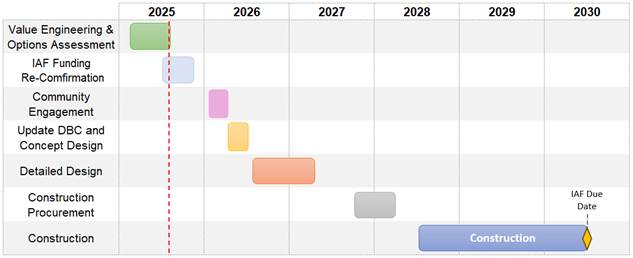

10. NIFF have identified CRS2 as a project which has not met the agreed milestones and specific requirements and is considering material changes in scope since the IAF Funding Agreement was put in place, due to:
· anticipated NZTA funding has not been approved – which was identified as a milestone to be met by 31 January 2025 in the IAF Agreement;
· the extent of works at the SH29A end of the project is proposed to extend to Maleme Street to tie-in with NZTA’s planned works at the Barkes Corner intersection (SH29A / Cameron Road) which is planned to be separately delivered as part of the Tauriko SH29/SH29A RoNS project; and
· there has been a material decrease in total project budget.
11. With the transition of IAF administration from Kainga Ora to NIFF, the project is undergoing a preliminary review. NIFF identified the scale of changes - particularly the absence of NZTA subsidy and reduced budget - as likely constituting a ‘material change of scope’ under the Funding Agreement. Additionally, any revision to the agreed completion date of 30 June 2030 would require further Ministerial approval. As it stands, the project remains scheduled for delivery by that date.
12. In order to have the best chance of retaining IAF funding, NIFF recommends Council provide a clear indication that it intends to deliver CRS2 by 30 June 2030 to a design that supports significant housing intensification in the Te Papa peninsula as detailed under the IAF Funding Agreement. This will enable recommendations to be put forward to Ministers.
13. Subject to Council endorsement, it is proposed that community consultation and engagement on the project would be progressed with an intention to report back to City Futures Committee in early 2026 to confirm the proposed concept option prior and seek approval to progress to detailed design and construction.
Background
14. The Cameron Road Stage 2 project is a key enabler to continued city growth, particularly as a connector for development of the western corridor and planned intensification of the Te Papa peninsula.
15. There is a significant housing shortfall and affordability crisis in Tauranga and the wider sub-region. Moving forward at pace to deliver serviced and zoned land is critical to increasing supply which in turn will improve affordability.
16. The Urban Form and Transport Initiative, Te Papa Indictive Business Case and Spatial Plan, SmartGrowth Strategy and Transport System Plan are all key planning documents which provide direction on the future housing and business land supply to sufficiently accommodate the projected growth in the sub-region, along with supporting transport infrastructure required to enable housing intensification of existing urban areas and new greenfield areas.
17. Cameron Road is one of Tauranga’s main arterial corridors, providing an important connection to the city centre for people within and beyond the corridor. It is an important route and a destination for many with the city centre, primary and secondary schools, businesses, public spaces, and the hospital located along it. Over the next 30 years, it is anticipated that more than 35,000 people will be living on Te Papa Peninsula.
18. More broadly, the wider Western Bay of Plenty region is planning for an extra 200,000 people living in the region over the next 30 to 50 years. Tauranga needs to transform into a place where more people can live, work, study, and provide more sustainable ways to move around.
19. The Cameron Road Stage 1 project from Harington Street to 17th Avenue has now been completed. Cameron Road Stage 2 connects between this and the future planned State Highway 29 and 29A upgrades from Tauriko to Barkes Corner / Cameron Road. Delivery of CRS2 is required to fully realise the intended benefits of these adjacent projects.
20. The Te Papa Indicative Business Case (prepared alongside the Te Papa Spatial Plan), a joint business case prepared by NZTA, TCC and Bay of Plenty Regional Council, was approved by NZTA alongside the Urban Form and Transport Initiative Programme Business Case in 2020.
21. Both the Urban Form and Transport Initiative and the Te Papa Indicative Business Case provide for an integrated land use transport strategy supporting significant intensification within the Te Papa corridor, located around the Cameron Road spine.
23. Te Papa is identified as the city’s largest residential intensification zone over the next 30 years to support housing growth. The Development Capacity Assessment undertaken as part of the Plan Change 33 process shows that feasible and reasonably expected additional development capacity through the Te Papa peninsula (incl. the city centre and Te Papa high density zone) is approximately 3,940 attached dwellings over the next 30 years in addition to detached intensification.
![]()

24. There have been a number of larger scale apartment developments delivered along and in the vicinity of Cameron Road over the past few years, with significant future development opportunity also existing in the Gate Pā area where Accessible Properties Limited (recently identified by Government as a strategic partner for delivery of community housing) owns approximately 120 parcels within walking distance to Cameron Road. Dwellings consented in Te Papa over the last three years are summarised below demonstrating a strong demand:
|
Dwelling Type |
2022/23 |
2023/24 |
2024/25 |
Total |
|
Stand-alone dwelling |
17 |
11 |
21 |
49 |
|
Apartment – mixed use |
6 |
6 |
||
|
Attached dwellings |
141 |
85 |
40 |
266 |
|
Duplex dwelling |
10 |
9 |
2 |
21 |
|
Secondary dwelling |
1 |
1 |
2 |
|
|
Total |
175 |
106 |
63 |
344 |
25. Cameron Road will play a key role providing transport alternatives to enable growth and development of the Western Corridor, connecting planned greenfield residential and industrial development areas to the city centre and other key city destinations. The Western Corridor development includes the Tauriko West residential area of approximately 3,000 new homes, continued development of the Tauriko Business Estate supporting significant employment growth, and future planned development areas such as Keenan Road and Belk Road areas.
26. The Te Papa Indicative Business Case and Spatial Plan is also strongly aligned with Government Policy Statement on Land Transport 2024, particularly the Strategic Priority for Economic Growth and Productivity. The economic analysis for the indicative business case, which included Cameron Road stages 1 and 2 as key components, identified significant benefits relating to safety, travel time savings, congestion reduction, productivity gains and emissions reduction.
27. Investment in movement within the Te Papa area and along Cameron Road corridor, including modal choice options for walking, cycling, public transport and high occupancy vehicle travel is both a necessity to respond to reasonably expected growth and network capacity challenges, as well as providing a catalyst for future private investment. This aligns with both the existing National Policy Statement on Urban Development and envisaged future amendments to this policy, which provide for a focus to enable “more people to live in, and more businesses and community services to be located in, areas of an urban environment … well-serviced by existing or planned public transport”.
28. The CRS2 project is also planned to deliver significant upgrades and renewals to water and wastewater infrastructure along the Cameron Road corridor. Upgrades to the water and wastewater networks are also key enablers to planned intensification and growth.
29. An initial CRS2 Detailed Business Case (DBC) was completed in January 2024. Noting changes to Government Policy Statement for Land Transport (GPS) in 2024, in July 2024 NZTA advised this original Business Case was not endorsed or accepted.
30. A reworked DBC that focused strategic alignment to the priorities within the 2024 GPS was commenced in August 2024, with completion in February 2025.
31. The reworked DBC incorporated a design philosophy that prioritised a four-lane route wide layout that provides future flexibility for multi modal infrastructure – however cost estimates to deliver the DBC scope exceeded funding availability without NZTA co-funding.
32. The City Futures Committee considered a progression options report at the 17 February 2025 meeting based on the reworked DBC scope and 30% design, with the following resolutions:
(a) Asks for a report on continuing with Cameron Road Stage 2, delivering a project within the envelope of IAF+IFF+DCs that delivers the outcome of value for money with priority on enabling housing intensity and roading throughput, and:
(b) Explores opportunities to reallocate planned IAF and IFF funding to alternative eligible projects.
33. Following the City Futures Committee resolution, staff commenced a value engineering/cost efficiency process which produced five concept options that were presented to the City Futures Committee Workshop on 12 June 2025.
34. The City Futures Committee Workshop provided direction to the project team to further refine two full corridor length options, along with the development of a ‘hybrid’ third option.
35. Refined options were further presented at a City Futures Committee Workshop on 31 July 2025 where the developed hybrid corridor option has emerged as a preferred option for progression, with three sub-options for Greerton Village.
STRATEGIC ALIGNMENT
36. This contributes to the promotion or achievement of the following strategic community outcome(s):
|
Contributes |
|
|
We are an inclusive city |
ü |
|
We value, protect, and enhance the environment |
ü |
|
We are a well-planned city |
ü |
|
We can move around our city easily |
ü |
|
We are a city that supports business and education |
ü |
37. We are an inclusive city – The CRS2 project supports inclusive access consistent with the Ministry of Transport’s Transport Outcomes Framework and the National Policy Statement on Urban Development.
38. We value, protect, and enhance the environment – The project will incorporate minimal impact design principles and support reduced emissions through improved modal choice and maximum retention of existing flora and fauna.
39. We are a well-planned city – CRS2 will help deliver the Connected Centres, Urban Forum and Transport Initiative (UFTI), Transport System Plan and Te Papa Spatial Plan outcomes.
40. We can move around our city easily – Flexible design with multi-mode conversion options aims to maximise the people movement function of Cameron Road in supporting the required intensification of housing along the peninsula.
41. We are a city that supports business and education – The Te Papa Peninsula is a key intensification area with Cameron Road the main arterial corridor, providing connection between residential, employment, health, education, and recreational destinations.
Financial Considerations
42. Waters works for the Cameron Road Stage 2 project are planned and budgeted in the 2024-34 LTP to a value of $86.7m.
43. The proposed funding stack for Transport works is $99m - $106m (excl. originally budgeted NZTA 51% FAR subsidy). This is comprised of:
|
Current Funding Agreement Stack ($M) |
Notes/Risk |
|
|
Infrastructure Acceleration Fund (IAF) |
56.4 |
Total apportioned to CRS2 project. NIFF (IAF fund administrator) have signalled that funding is at risk of being terminated unless TCC can: o provide certainty that TCC is committed to delivering the project by 30th June 2030. o provide evidence that project will deliver intended housing outcomes. o evidence a credible delivery timeline. |
|
Transport System Plan Infrastructure Funding and Financing (TSP IFF) |
20 – 27.5 |
$20m currently assigned to CRS2. Additionally, there is circa $7.5m of unallocated IFF levy funding to support identified projects, which could potentially be assigned to CRS2. |
|
Developer Contributions (DCs) |
22.4 |
The Development Contributions Policy 2025/26 includes $22.4m of funding for this project. This amount is likely to change somewhat to reflect (i) growth enabled by the final design and (ii) the final budget for this project. Staff do not anticipate significant change at this time. |
|
Total |
98.8 – 106.3 |
|
Table 1 – Current Funding Agreement stack.
44. Funding is currently budgeted in the 2024-34 LTP and 2025-26 Annual Plan to enable project construction to be completed by mid 2030.
Infrastructure Acceleration Fund
45. In 2023 TCC agreed the Te Papa Intensification IAF funding agreement with Kainga Ora (then the administrator of the IAF). This agreement provided the following Crown grant funding provided certain milestones are met:
(a) $56.4m for CRS2,
(b) $6.8m for Chadwick Road water supply main; and
(c) $4.7m for Cameron Road Connections (of which roughly $1.3m has already been drawn down).
46. The Te Papa Intensification IAF funding agreement is premised on accelerating infrastructure delivery to enable and support development of at least 1600 additional dwellings within the Te Papa intensification area over 10 years.
47. Earlier this year NIFF took over administering IAF from Kainga Ora. The Minister for Infrastructure has tasked NIFF with undertaking a review of the performance of the IAF. In particular the Minister is keen to understand why drawing under the IAF agreements is significantly slower than anticipated when the agreements were entered into and what can be done by NIFF to speed up drawings. As part of this review, NIFF will identify projects that are not expected to achieve their intended outcomes either due to delivery delays or because the project is being delivered at a smaller scale (or not at all). CRS2 falls into this category as NIFF does not have clarity regarding:
(a) Whether TCC intends to deliver the project;
(b) If TCC does intend to deliver the project, how this will be achieved by 30 June 2030;
(c) How the overall funding requirements will be met without NZTA FAR subsidy;
(d) The potential changes to project scope – in particular the removal of the Barkes Corner / State Highway 29 intersection – and the impacts for housing outcomes; or
(e) The substantial proposed decrease in project budget and the impact of this change for housing outcomes.
48. NIFF has advised staff that each of these changes is likely to be considered a material change of scope under the funding agreement. This will require Ministerial approval. NIFF has also noted that any delay in completing the project beyond 30 June 2030 is likely to be considered an additional material change in scope.
49. In the event funding is terminated for CRS2, funding for the other two projects in the Te Papa IAF funding agreement will also be terminated.
50. NIFF has advised that there is a risk with the Agreement and continued funding availability due to materiality of the proposed changes and with TCC not meeting key milestone dates under the IAF Agreement. TCC’s best opportunity to retain the funding is to:
(a) Provide certainty that TCC is committed to the project and the completion by 30th June 2030.
(b) Evidence a timeline from now until delivery commences.
(c) Evidence how this project contributes towards achieving housing outcomes, in particular housing intensification, in Te Papa.
(d) Demonstrate how CRS2 realises the full benefits of the CRS1 project and facilitates the proposed housing growth in the Western Corridor to Te Papa.
(e) Emphasise the importance of CRS2 upgrades to enabling community housing development in Te Papa by APL (one of the Government’s strategic development partners).
(f) Emphasising the importance of this project in connecting a relatively economically deprived area to the hospital and medical facilities, schools, employment opportunities in the city centre, areas of cultural significance and significant open space areas.
51. Point (a) can be achieved through resolutions today. In order to have the best chance of retaining IAF funding, it is essential that Council provide a clear and definitive statement in support of delivering CRS2 by 30 June 2030. Without this statement, it is likely that NIFF will recommend terminating the IAF funding. It is not known which considerations will influence the Minister’s decision but it is reasonable to assume a clear statement of support from Council will be viewed positively.
52. The remaining points will be achieved by the content of this report and supplementary information provided by TCC.
53. NIFF will prepare their project review to the Minister in October 2025. The Minister is expected to make the final decision in October – November 2025.
54. Staff will provide informal updates to Council on the NIFF resolution and the Minister’s decision.
Transport System Plan Infrastructure Funding and Financing (TSP IFF)
55. The TSP IFF is a charge levied on Tauranga properties over a 30-year period from 1 July 2024. The TSP IFF Levy finances capital expenditure of approximately $177m to fund up to 13 transport projects including CRS2.
56. $20m of TSP IFF funding has been allocated to CRS2. There is currently an unallocated balance of approximately $7.5m which could also be applied to CRS2 if required.
57. Should the CRS2 project delivery not continue, TCC would look to direct these funds to an alternative project. This is likely to occur in time but is likely to leave the TSP IFF underutilised for some years before eligible projects proceed.
Development contributions
58. CRS2 was included in the 2024/25 Development Contributions Policy for collection in the Te Papa Infill catchment. In the current year, DCs are funding $22.4m. When collection for this project was set, TCC considered the concept design and its potential to support intensification growth in the peninsula. TCC consulted and adopted a funding share of 20% of capital expenditure after NZTA FAR subsidy.
59. Staff will reassess the preferred design once agreed to understand whether it is likely to generate materially similar growth outcomes. As the proposed design is expected to provide much the same functionality, this is considered likely to be similar.
Options Analysis
60. In accordance with resolutions from the 17 February 2025 City Futures Committee meeting and workshops on 12 June and 31 July, revised design options have been developed within a reduced funding envelope.
Cameron Road Corridor – Seventeenth Avenue to Maleme Street (excl. Greerton Village)
61. Through workshops an emerging preferred ‘hybrid’ concept option for the corridor has been identified (included on attachments 1, 2 and 3). This is a full route concept that supports housing intensification and enhanced accessibility to schools, recreation and medical amenities, which:
(a) Prioritises a four-lane carriageway through the route
(i) Initially assumed to operate with peak period transit lanes with ‘off peak’ parking
(ii) Future-proofed for full-time transit or bus lanes as required
(b) Includes dedicated separated ‘uni-directional’ cycle route along majority of corridor to promote safer cycling
(c) Includes full corridor resurfacing and remarking
(d) Includes raised bus ‘landings’ at bus stops for safety
(e) Retains right turn facilities at major signalised junctions
(f) Generally fits within existing ‘kerb to kerb’ – with localised widening where required.
62. Key constraints and compromises of hybrid option:
(a) Compromises median for right turn movements into side streets and driveways
(b) Shared paths in sections where corridor width does not facilitate two separated cycle lanes
(c) Limited budget for community ‘place’ enhancements and cultural artwork
(d) Restrictions to existing on street parking in peak periods
63. All concept options have undergone a high-level internal safety review without any ‘fatal flaws’ identified
64. It is recommended that stakeholder and community feedback is sought on the concept to support design refinement and confirmation of a preferred design option.
Greerton Village
65. Through Greerton village there remain sub-options for either two lanes or four lanes of traffic and traffic signals or roundabouts at the Chadwick Road and Cornwall Street intersections.
66. Three concept design options have been identified for the Greerton Village:
· Option 1 – Four lanes with dual signalised intersections (Attachment 1)
· Option 2 – Two lanes with separated uni-directional cycle lanes (Attachment 3)
· Option 3 – Four lanes with dual roundabouts (Attachment 2)
67. The options have different features and associated benefits or compromises as summarised below:
|
Greerton Village Options |
|
|
Summary of scope and key benefits |
Key constraints and compromises |
|
Option 1 - Four lanes with dual signalised intersections |
|
|
• Prioritising a four lane carriageway full route • Initially with assumed peak period clearways for transit lanes and parking ‘off peak’ • Future proofed for dedicated transit or bus lanes • Signalised junctions safer than roundabouts |
• Restrictions to existing on street parking in peak periods • No separated cycle facility through village • Trees to be removed at roundabouts |
|
Option 2 – Two lanes with separated uni-directional cycle lanes |
|
|
• Uni-direction separated cycle lanes through village • Reduced construction work and lower cost through kerb/median retention • Retention of all existing trees • More space opportunity for ‘place’ enhancements and cultural artwork • Less corridor segregation with less traffic lanes for pedestrians to cross – supporting a people-centric town centre. |
• No future proofing for transit/bus lanes • Buses would require ‘bus jumps’ on approaches for priority • Most on street parking removed for cycle lanes • Cycle lanes on roundabouts not preferred |
|
Option 3 – Four lanes with dual roundabouts |
|
|
• Prioritising a four lane carriageway through the route • Initially with assumed peak period clearways for transit lanes and parking ‘off peak’ • Future proofed for dedicated transit or bus lanes |
• Restrictions to existing on street parking in peak periods • No separated cycle facility through village • Limited budget for ‘place’ enhancements and cultural artwork |
68. Initial assessments indicate all options are viable in delivering intended benefits without significantly compromising the operation of the corridor.
69. To inform a preferred option in this area further community and stakeholder engagement on the concept options is proposed.
Cost Estimation
70. Independent bottom-up detailed cost estimates have been completed on the revised options – with the expected estimate of all options being within the identified funding stack as shown below. These estimates include a P50 contingency allowance and forecast inflationary adjustments.

Traffic Modelling
71. The initial modelling shows the CRS2 project is predicted to reduce travel times and significantly improve travel time reliability along the length of the corridor. This is particularly evident in the more congested commuter peak directions.
72. The project is predicted to reduce average travel times by:
(a) Around 1½ minutes northbound in the morning peak in 2035, increasing to 3 minutes in 2048 (Southbound peak remains about the same)
(b) Around 1½ minutes southbound and 2½ minutes northbound in the evening peak in both 2035 and 2048
(c) Around 1½ minutes southbound and 2½ minutes northbound in the evening peak in both 2035 and 2048
73. Further full traffic modelling will be completed as part of the 30% design process.
On-Street Parking
74. The existing Cameron Road Stage 2 corridor includes approximately 338 on-street carpark spaces. Initial assessment of the proposed hybrid concept has identified potential to retain up to 300 on-street parking spaces in transit lanes outside of peak periods - subject to subsequent Council decisions on whether to allocate and allow on-street parking.
75. Although on-street parking can be retained, there may be inconsistencies along the corridor. For example, based on the current concept, in the area between Chadwick Road and Pooles Road 11 of the existing 38 on-street parking spaces could be retained. Further assessment of parking demand and provision will be completed through next stages of design development.
Waters
76. The project includes planned upgrades to the water, wastewater, and some stormwater networks
77. All three transport hybrid options detailed in this memo align with the Waters infrastructure upgrade projects that support the planned housing intensification and would be coordinated accordingly.
78. It is noted however that if implementation of the Cameron Road Stage 2 transport upgrade project is deferred beyond 2030, it is likely some water infrastructure upgrades and renewals would need to be progressed in advance of the transportation works to maintain network levels of service.
TE AO MĀORI APPROACH
79. Council’s Te Ao Māori approach has been incorporated throughout project development to date. As valued delivery partners, hapū/iwi have been intrinsically involved with the project with a particular focus on the significant Gate Pā /Pukehinahina site.
80. As the project progresses it is intended this engagement would continue to support the principles of manaakitanga, rangatiratanga, kaitiakitanga, whanaungatanga, wairuatanga, tūmanako and Te Reo Māori.
CLIMATE IMPACT
81. The CRS2 project DBC has incorporated and assessed options and opportunities to adapt to a changing climate, reduce emissions and enhance nature and biodiversity.
82. Key project opportunities include partial stormwater treatment, retention, and incorporation of flora into design, reduction in raw material requirements through optimised design and recycling of materials and encouraging sustainable transport modes through ensuring appropriate connections and design optimisation.
Significance
83. The Local Government Act 2002 requires an assessment of the significance of matters, issues, proposals, and decisions in this report against Council’s Significance and Engagement Policy. Council acknowledges that in some instances a matter, issue, proposal, or decision may have a high degree of importance to individuals, groups, or agencies affected by the report.
84. In making this assessment, consideration has been given to the likely impact, and likely consequences for:
(a) the current and future social, economic, environmental, or cultural well-being of the district or region
(b) any persons who are likely to be particularly affected by, or interested in, the decision.
(c) the capacity of the local authority to perform its role, and the financial and other costs of doing so.
85. In accordance with the considerations above, criteria and thresholds in the policy, it is considered that the decision is of medium significance.
ENGAGEMENT
86. There have been four phases of community engagement on the project to seek community input and feedback since 2022 when project scoping originally commenced. This has included targeted engagement with mana whenua and key stakeholders, including businesses and schools along the corridor. Engagement tools have included visioning workshops, project business cards, walking tours with schools, surveys, community drop-in sessions, awareness campaigns, letter drops, newsletters and email updates. The project has a Virtual Engagement Room (https://cameronroad.ghdengage.com/) and a presence on the Let’s Talk Tauranga website (www.tauranga.govt.nz/cameronroad). Further community engagement on proposed changes are intended.
87. Taking into consideration the above assessment that the decision is of medium significance, officers are of the opinion that the following consultation/engagement is suggested/required:
(a) The project team would carry out community engagement on the recommended hybrid concept design along with the three variable concept designs for Greerton Village.
(b) The feedback from this process would be reviewed in conjunction with the detailed historic community engagement data collected over the last 4 years and presented back to Council in 2026.
Next Steps
88. Subject to decisions and direction from Council, staff will continue to engage with NIFF to provide the necessary information required to support a recommendation to continue funding. Staff will advise Council of the recommendation in October and the Ministers decision thereafter.
89. Subject to Council endorsement and re-confirmation of IAF funding availability, community engagement on the concept and options is proposed to be completed. If confirmation is received in September community engagement would be completed this year prior to finalising a Detailed Business Case, however we anticipate re-confirmation of IAF funding availability will not be received until October/November 2025.
90. It is currently anticipated community engagement would be progressed in early 2026 to inform subsequent concept design confirmation – which would be sought from the City Futures Committee in the first half of 2026 before commencing the detailed design (pre-implementation). The below timeline shows an indicative CRS2 programme.

91. In regard to managing construction impacts of project delivery, it is not desirable to be completing major construction of Cameron Road Stage 2 at the same time as the Fifteenth Ave to Welcome Bay project, which is scheduled for construction primarily in 2027 and 2028 calendar years. Based on indicative concepts, it is currently estimated construction would be able to be completed over an approximate 18 month period. There are opportunities however for some overlap of low-impact works, and also opportunities within the programme to further advance construction implementation subject to funding availability and network constraints.
92. In accordance with the current IAF/NIFF funding agreement implementation of the project is required to be complete by 30 June 2030. The project is deliverable within this timeframe, with funding allocated in the Long Term Plan for works to proceed.
1. Cameron

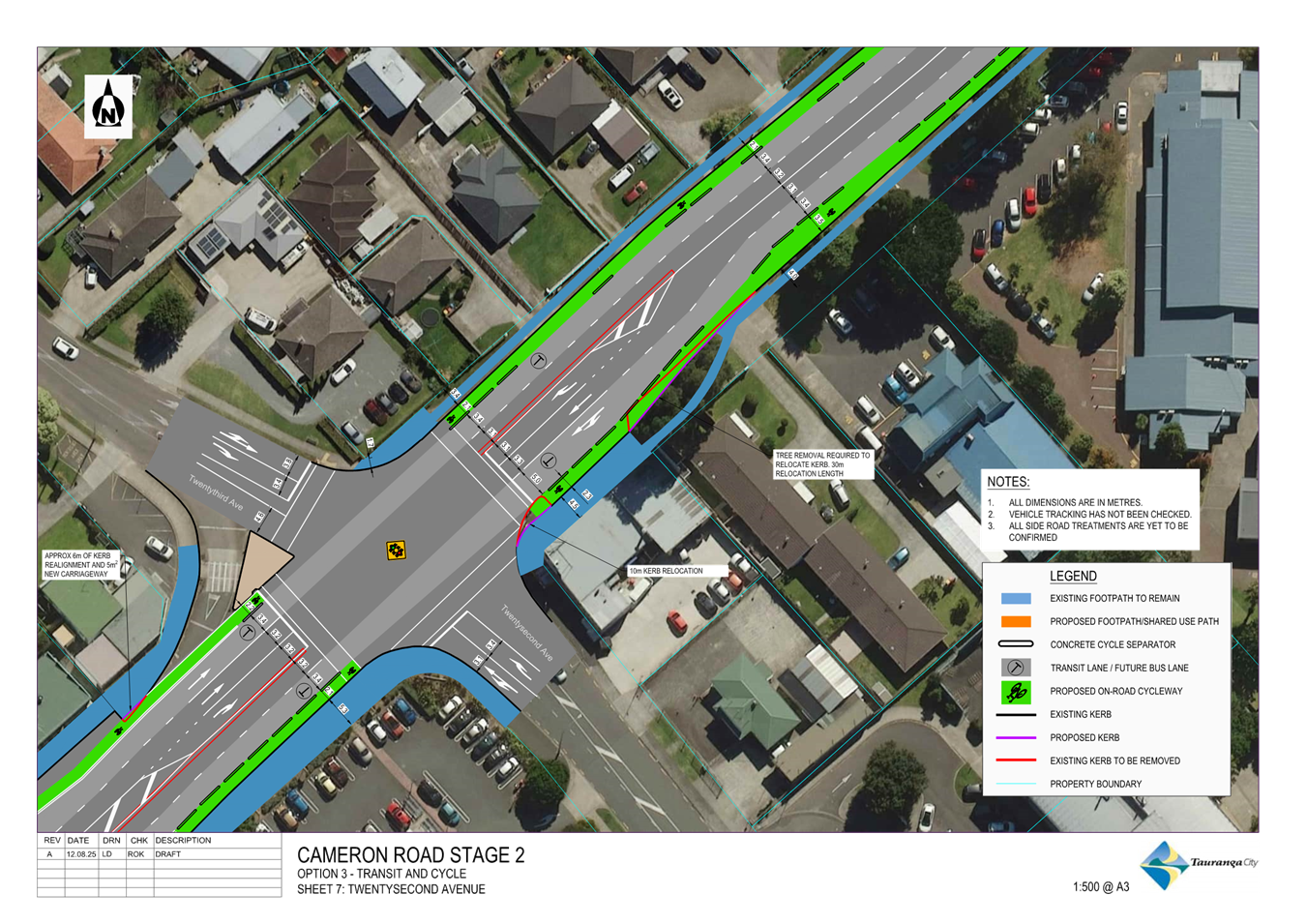

Road Stage 2 - Concept Option 1 - Hybrid Design with Greerton Village 4-Lanes +
Signalised Intersections - A18598531 ⇩ ![]()
2. Cameron
Road Stage 2 - Concept Option 2 - Hybrid Design with Greerton Village 2-Lanes +
Roundabout Intersections - A18598532 ⇩ ![]()
3. Cameron Road
Stage 2 - Concept Option 3 - Hybrid Design with Greerton Village 4-Lanes +
Roundabout Intersections - A18598533 ⇩
|
26 August 2025 |
11.3 Concept Design for NZ Institute for Marine Futures
File Number: A18592587
Author: Ross Hudson, Manager: Strategic Planning and Partnerships, Spaces and Places
Jaimee Kinzett, Senior Strategic Advisor
Authoriser: Barbara Dempsey, GM: Operations & Infrastructure (City Ops & S&P)
Please note that this report contains confidential attachments.
|
Public Excluded Attachment |
Reason why Public Excluded |
|
Item 11.3 - Concept Design for NZ Institute for Marine Futures - Attachment 3 - UoW_MSC_Concept_Confidential Appendix |
s7(2)(b)(i) - The withholding of the information is necessary to protect information where the making available of the information would disclose a trade secret. |
Purpose of the Report
1. To make a public record of the Concept Design, and Council’s response, for the University of Waikato’s Institute of Marine Futures, submitted in accordance with the Agreement to Lease for land for the facility at Marine Park.
|
That the Council: (a) Receives the report "Concept Design for NZ Institute for Marine Futures". |
CONCEPT DESIGN SUBMISSION & COUNCIL RESPONSE
2. Council has an Agreement to Lease (Agreement) approximately 7,000m2 of land at Marine Park to the University of Waikato (University) for the development of the New Zealand Institute of Marine Futures. This Agreement was made public at the 3 March 2025 Council meeting.
3. Under clause 2.1(a) of the Agreement, the University was required to submit a Concept Design within 12 months of the date of this Agreement (4 July 2024). The Concept Design was received on 2 July 2025 and, following review, was approved by Council staff in accordance with clause 4.7 of the Agreement.
4. Clause 4.7 requires Council to give its approval as soon as practicable, and in no more than 20 working days after receipt of the Concept Design, if it is satisfied that the Concept Design is consistent with the Design Criteria. Approval must not be withheld or delayed where the Concept Design is consistent with the Design Criteria, nor otherwise unreasonably withheld for any other reason. If Council does not respond within this timeframe, the Concept Design is deemed to be approved. As the Concept Design was received only two days before the Condition Date, Council staff sought and obtained an extension from the University under clause 2.3(d) to the to enable the full 20 working days to consider the concept and provide constructive feedback.
5. This process has been undertaken in line with the good faith commitments in clauses 3.4 and 3.5 of the Agreement, with both parties working collaboratively to progress the design and address any matters constructively as part of the development process.
6. Upon receipt on 2 July 2025, the Concept Design was circulated to relevant Council staff for review. An internal meeting was held on 8 July 2025 to discuss the Concept Design and identify matters for discussion with the University at the Design Group meeting.
7. A Design Group, established under clauses 4.2 and 4.3 of the Agreement, met on 10 July 2025 to discuss the Concept Design. Members of the Design Group are:
· Deputy Vice Chancellor, University of Waikato
· Director, Tauranga Campus Development & Operations, University of Waikato
· Manager Strategic Planning & Partnerships, Spaces & Places, TCC
· Senior Strategic Advisor, Commercial Advisory, TCC
8. Council staff then reviewed the Concept Design and shared the design package and a draft response to it with Elected Members informally on 23 July 2025 for information and the opportunity to provide input prior to the formal response. There is no requirement within the Agreement for further formal resolution by Elected Members, which is consistent with Council’s approach to lease management and the Reserves Act, where once direction is set, implementation is delegated to staff.
9. The formal response to the Concept Design was sent to the University on 28 July 2025. The Concept Design (excluding commercially sensitive material) was then made publicly available on Council’s website on 1 August 2025 at:
https://letstalk.tauranga.govt.nz/projects/new-zealand-institute-for-marine-futures-sulphur-point
10. Schedule 2 of the Agreement sets out the Design Criteria, which clause 4.7 requires Council to apply when considering approval of the Concept Design. The Design Criteria establish the key performance and design expectations for the facility, including requirements for environmental sustainability, cultural and iwi engagement, simplicity of built form, integration with the surrounding reserve, community accessibility, and long-term research adaptability.
11. The letter approving the Concept Design acknowledges the general alignment with the Design Criteria and the Preliminary Concept Design, and outlines areas where further detail is required at the next stage of design development, particularly in relation to:
(a) Integration with the reserve and public realm
(b) Seawater intake infrastructure (noting that Bay of Plenty Regional Council will be the consenting authority for infrastructure in the harbour)
(c) Services and car parking
(d) Sustainability
(e) Project Staging
(f) Iwi engagement

12. The Concept Design is at Attachment 1. The response letter from the General Manager, Community Services providing Council’s response to it is at Attachment 2 of this report. Note that an appendix to the Concept Design is provided as a Public Excluded Attachment as it contains information that is commercially sensitive intellectual property of a third party.
Next Steps
13. The approval letter requests that the University prepare a developed design for further consideration before the University proceeds to detailed design and consenting stages of the project. Any further design iterations will be shared with Elected Members and published on the Council website.
14. This approval to proceed to the next stages of design and consents is given in Council’s capacity as landlord and administering body under the Reserves Act. Council retains its separate role as Consenting Authority for any resource and building consents.
15. The University is progressing its funding strategy for the project, with the aim of securing funding and consents for construction commencement before 2028.
1. UoW_MSC_Concept_Package
- A18637572 ⇩ ![]()
2. UOW
Marine Facility - response to Concept Design - A18637532 ⇩ ![]()
3. UoW_MSC_Concept_Confidential Appendix - A18637573 - Public Excluded
|
26 August 2025 |
13 Public excluded session
Resolution to exclude the public
